|
|
Status
|
Construction scheme
(future) |
|
Where
|
To
provide a dual-carriageway bypass of the
neighbouring towns of Ballybofey and
Stranorlar on the N13 and N15 roads,
County Donegal
|
|
Total
Length
|
9.5 km / 5.9 miles
for the bypass plus 5.2 km / 3.2 miles
of single-carriageway for the link to
the N15 and other new local roads
|
|
Dates
|
Dec 2017 Feasibility
report published
Feb 2019 Route options published
Jan 2020 Preferred
route announced
2023 Included in the draft County
Donegal Development Plan 2024-2030
2024 Scheme approved
in principle by Department of Transport
2028 Possible start of construction
(as of Jul 2024)
|
|
Cost
|
150-180m (as of 2022)
- to be funded via the TEN-T Priority
Route Improvement Project, Donegal
|
|
See
Also
|
General area
map
Official
web site on scheme
|
Click
here to jump straight down to updates
for this scheme.
The N13 and N15 form two of the main trunk
roads in the east of County Donegal. The N15
starts from Strabane/Lifford and and heads
south-west via Donegal town and Ballyshannon
towards Sligo. At Stranorlar it is met by the
N13 which begins near Derry, then via
Letterkenny and heads south. Stranorlar, and its
neighbour, Ballybofey, (with a total population
of just under 5000 people) form the two biggest
bottlenecks on the road. This scheme would see a
dual-carriageway (type 2) bypass built around
the north/west of the twin towns, with a new
single-carriageway road link connecting the
bypass to the N15 towards Lifford/Strabane. A
second link road would connect the centre of the
bypass to the R252 Glenfin Road and into the

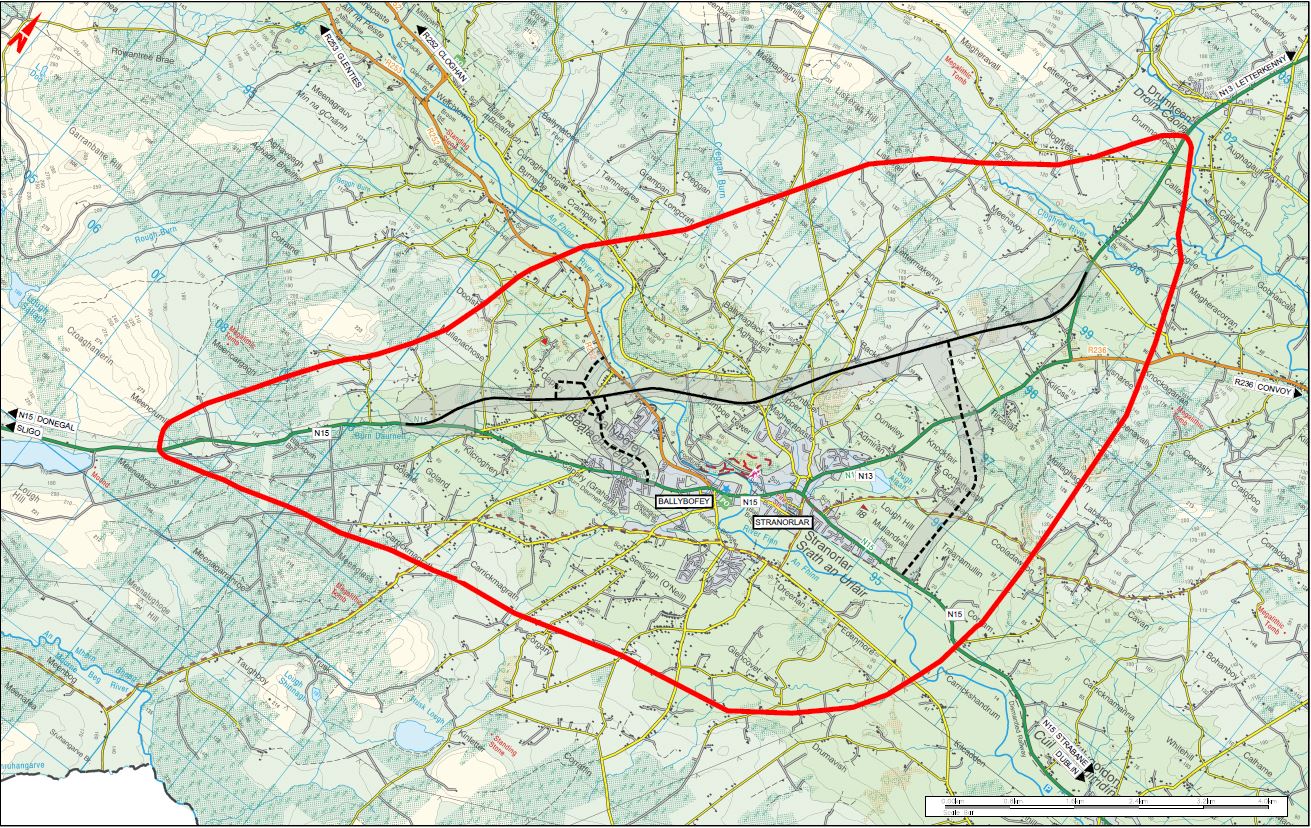

Ballybofey. The map below shows the proposed
route as of 2020 (click to expand). Sold black
is dual-, and dashed is single-carriagerway. A
more detailed design can be seen here.

The road would be dualbuilt to a high quality
-carriageway standard, with no intermediate
junctions on the level, and two grade-separated
junctions. It will include a major bridge over
the River Finn. The scheme is one element of
three schemes being taken forward together as a
single project, the other two being the N56/N13
Letterkenny to Manorcunningham upgrades
and N14
Manorcunningham to A5 at Lifford/Strabane.
Updates
10 Nov 2025: Note that this
update refers to ALL THREE Donegal Ten-T
projects. To avoid duplication, I'm only
updating this page instead of putting
identical updates on all three of the
related projects see links below the map above
for the other two. An article
in the Donegal Daily at Hallowe'en reports
that the compulsory purchase orders (CPOs) for
this road (the Irish equivalent of a Vesting
Order) will be published in January. It's not
totally clear to me if the publication of the
CPOs is the point at which the land ownership
transfers, or if it is merely publication of the
proposed CPO. With work not due to get underway
until 2028 the latter seems more likely to me as
there would be little point in acquiring the
land now. The Donegal County engineer who
addressed the meeting that the article covers
said "Were at the very final stage now and
very much looking at publishing in January.
However, we would have to allow for one or
one-and-a-half years of delays in the event of
appeals. We are looking at a five year
construction period, with completion date in
2032". Even through the legislation that
scuppered the A5 project doesn't apply to
Donegal, the engineers are still cognisant of
the threat of legal challenges. The engineer
said "its a massive project and we saw what
happened with the A5 (appeal). The project
team is doing great work and they are making
sure they are dotting all Is and Ts". With
thanks to redfred for letting me know about this
article.
16 Aug 2024: With thanks to a
correspondent who wrote to clarify that the
bypass is going to be a dual-carriageway,
not a single-carriageway as I had said
initially. The associated link roads, including
the one connecting the bypass to the N15 east of
Stranorlar, will be single-carriageway. Despite
the announcement of approval for the scheme in
July (see below), the official web site
on the scheme hasn't been updated for about
three years.
26 Jul 2024: The Irish Cabinet yesterday
finally approved this scheme, later than
anticipated in the previous update. The scheme
and the two other Donegal TEN-T schemes which
have been approved too will now move to the
planning and procurement processes. Subject to
all going to plan with these processes,
construction is anticipated to get underway in
2028, i.e. four years from now. The government
has also said that it will be revising the cost
estimates in due course, as the current estimate
of 150-180m dates from 2022 and the rate of
construction inflation has been quite high in
the past few years. With thanks to Paul
McCloskey for giving me the heads up about this
decision.
30 Aug 2023: First point to make is that
this is my first attempt to follow a scheme
outside Northern Ireland, so if I have made any
basic errors please be gentle and let me know
roads at wesleyjohnston.com! At this stage the
scheme has a detailed design (see here)
but construction is unlikely to begin before
2026. The next couple of years will need to see
the scheme taken through the process to obtain
planning permission. The scheme also needs a
business case signed off, which is expected
sometime this year. The current cost estimate is
150-180m at 2022 prices but this is likely to
rise due to the recent surge in construction
inflation. A reminder that the excellent JP
Dowling over at Irish
Motorway Info maintains information on new
roads across the whole of the Republic.
|
