|

                            |
                               Status
                             |
                            Construction scheme
                                (current)  |

                            |
                               Where
                             |
                            To
                                construct a link road connecting the
                                Movilla Road to Donaghadee Road, and on
                                to the A21 Bangor Road, round the
                                north-east of Newtownards  |

                            |
                               Total
                                Length
                             |
                            1.7 km / 1.1 miles
                                for Movilla Road to Donaghadee Road
                                0.9 km / 0.6 miles for Donaghadee Road
                                to Bangor Road
                               |

                            |
                               Dates
                             |

                               2007 - Included in
                                Sub-Regional Transport Plan
                                March 2009 - Included in adopted Ards
                                and Down Area Plan
                                15 Feb 2016 - Planning granted for Phase
                                1 at the Movilla Road end
                                June/July 2016 - Work began on the
                                Movilla Road to Donaghadee Road section
                                Whole road could be completed within ten
                                years - as of May 2016
                                Oct 2022 - Work began on the Bangor Road
                                to Donaghadee Road section
                                Apr 2024 - About 850 metres now open at
                                north end

                             |

                            |
                               Cost
                             |
                            Unknown - to be
                                funded by private developers
                               |

                            |
                               See
                                  Also
                             |

                               General
                                  area map - Google Maps
                             |

                      The Ards and Down Area Plan 2015, which was
                        adopted in 2009, foresees significant growth in
                        housing in Newtownards. The land is divided into
                        two "Phases". Phase 1 lands must be fully
                        developed before Phase 2 lands are released. The
                        bulk of the proposed housing land lies to the
                        east of the town (Phase 1) and the north-east of
                        the town (Phase 2). The largest area of land in
                        Phase 2 has the designation NS 20 and NS21 and
                        these are shown on the map below. A condition of
                        planning is that a distributor road must be
                        built traversing the site, connecting Movilla
                        Road to Donaghadee Road, and then on towards the
                        Bangor Road. The route of this road will be up
                          to the developer of the lands in question,
                        but by way of illustration I have included below
                        an example of a route that such a road might
                        take. But bear in mind that this is pure
                        conjecture. The NS20 and NS21 housing lands are
                        shown in red, while a possible route of
                        the road is shown as a blue line where it
                        traverses the NS20 land. However, the route
                        through the NS21 lands is better known, and is
                        shown as a red line. It is known because this
                        red line is part of a plan for a
                          housing development by Dunlop
                        Developments, for which outline
                          planning permission was granted on 20
                        December 2012.

                        View Movilla
                            Road to Donaghadee Road Link, Newtownards
                          in a larger map
                      This scheme ties in to two other schemes that
                        will, ultimately, lead to the creation of a
                        partial "ring" road round the east of
                        Newtownards from the A20 Portaferry Road in the
                        south to the A21 Bangor Road dual-carriageway in
                        the north. The two further components that would
                        be needed to make this a reality are:

                      Updates

                      22 Oct 2025: I recently spotted a
                        planning application that has gone in to provide
                        the next part of this road on the south side of
                        Donaghadee Road (between the two sections of
                        road shown in the image in the previous update
                        below). The planning application, ref
                        LA06/2024/1095/F, was received in 2024 and
                        includes a roundabout on the Donaghadee Road, as
                        well as a few hundred metres of the link road
                        itself. The application can be seen here.
                        A map of what is proposed is here
                        (though this link might break).

                      30 Jun 2025: This developer-led scheme
                        has now been under construction for nine years.
                        I thought it was worth checking in with the
                        latest Google Earth imagery to see the progress.

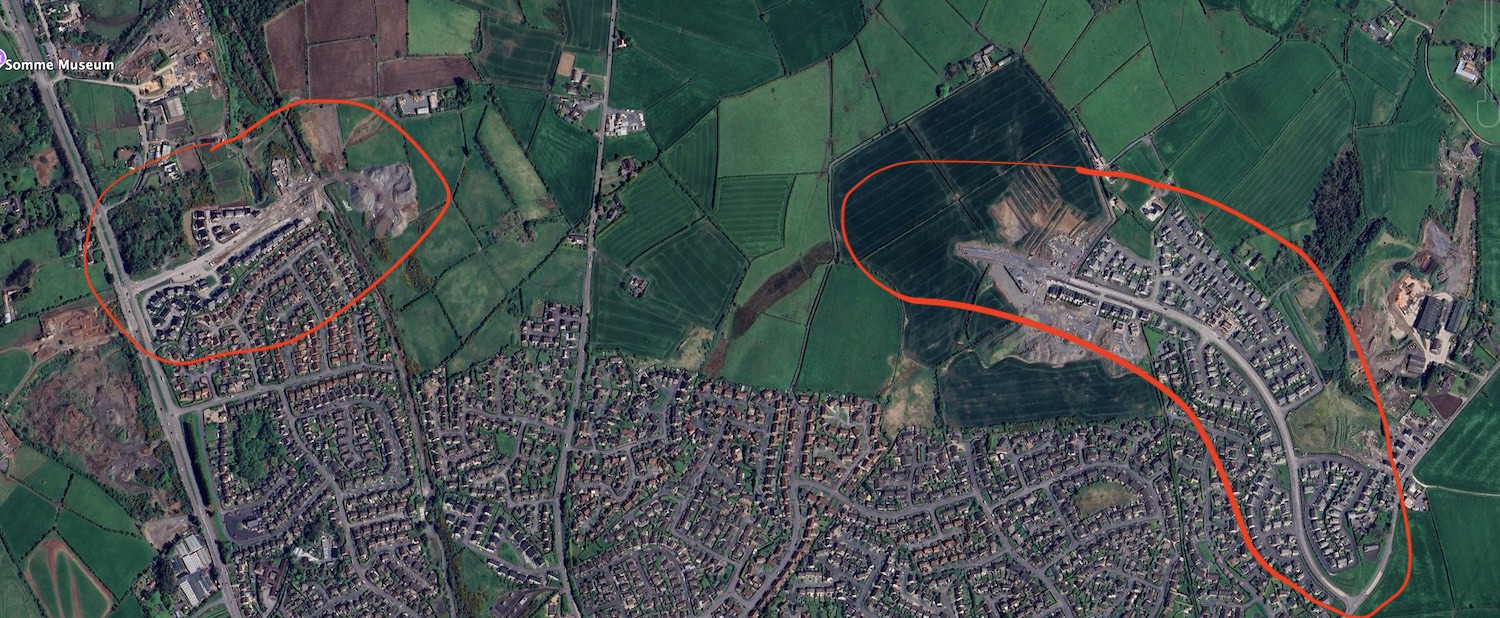

                        The image below was taken on 23 April 2025, so
                        shows things as they pretty much are. North is
                        to the top-right. I have circled the two ends of
                        the scheme in red. At the left end is the A21
                        Bangor Road, while the right-hand side of the
                        road terminates on the Movilla Road. The
                        Donaghadee Road is just left of centre, with
                        neither road yet meeting it. Almost 50% of the
                        road is now in place. So, at this rate, we'll
                        see the whole road completed around 2034!

                        Progress on the Movilla Road to Donaghadee Road
                        to Bangor Road Link as of April 2025 (Google
                        Earth).

                      17 Apr 2024: The southern end of this
                        road (Rivenwood) continues to take shape, with
                        about 850 metres now built at that end, almost
                        exactly half its distance to Donaghadee Road.
                        The image below was taken in February 2024 and
                        shows the current terminus of the road. With
                        thanks to Keith Nash who monitors the area
                        nicely. A reminder that the road is being built
                        in separate sections, with the other one
                        advancing east from the Bangor Road at Beverly
                        Garden Village. We're still far from the whole
                        road being completed, but we're perhaps 40% of
                        the way there.

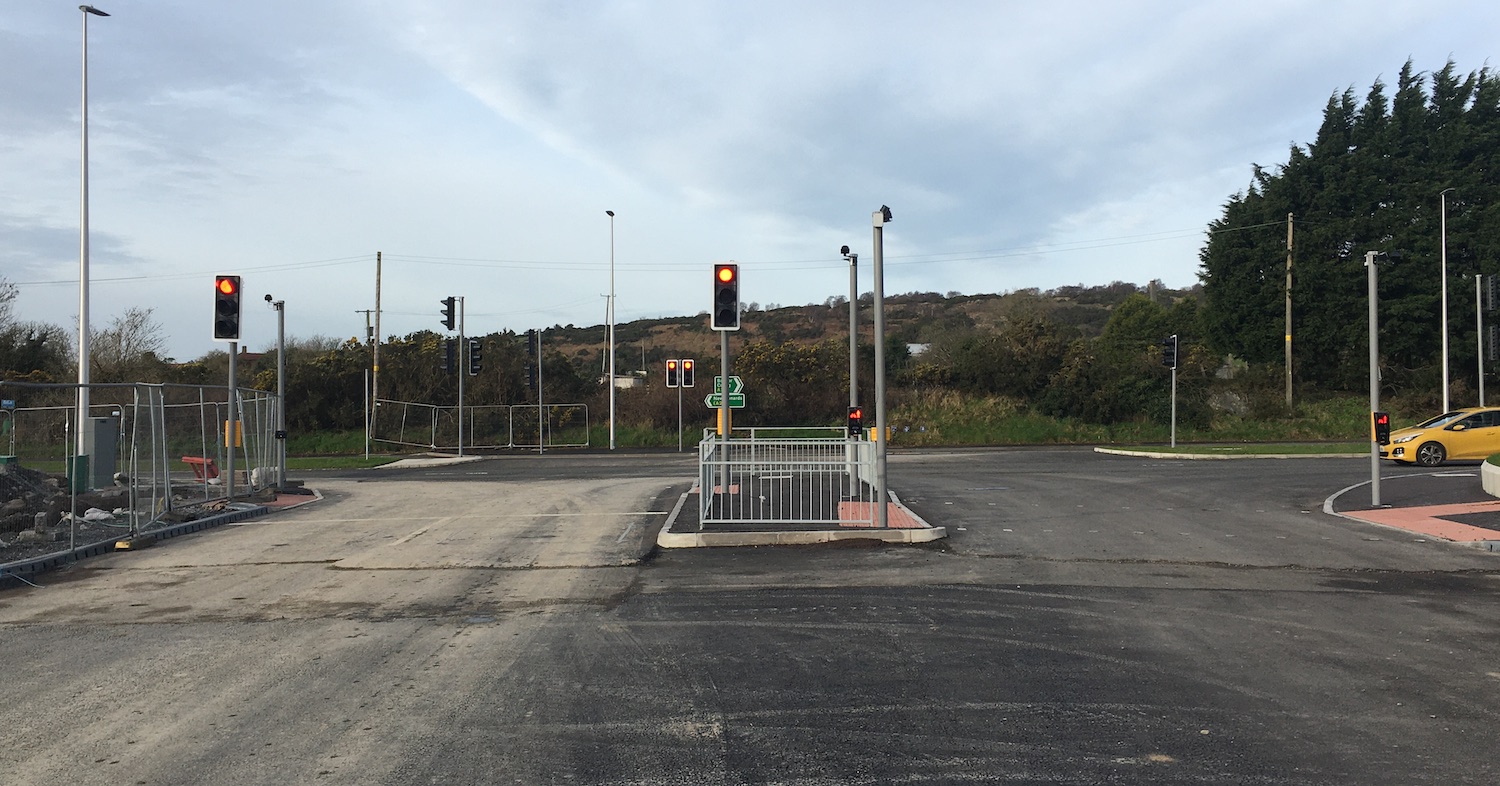

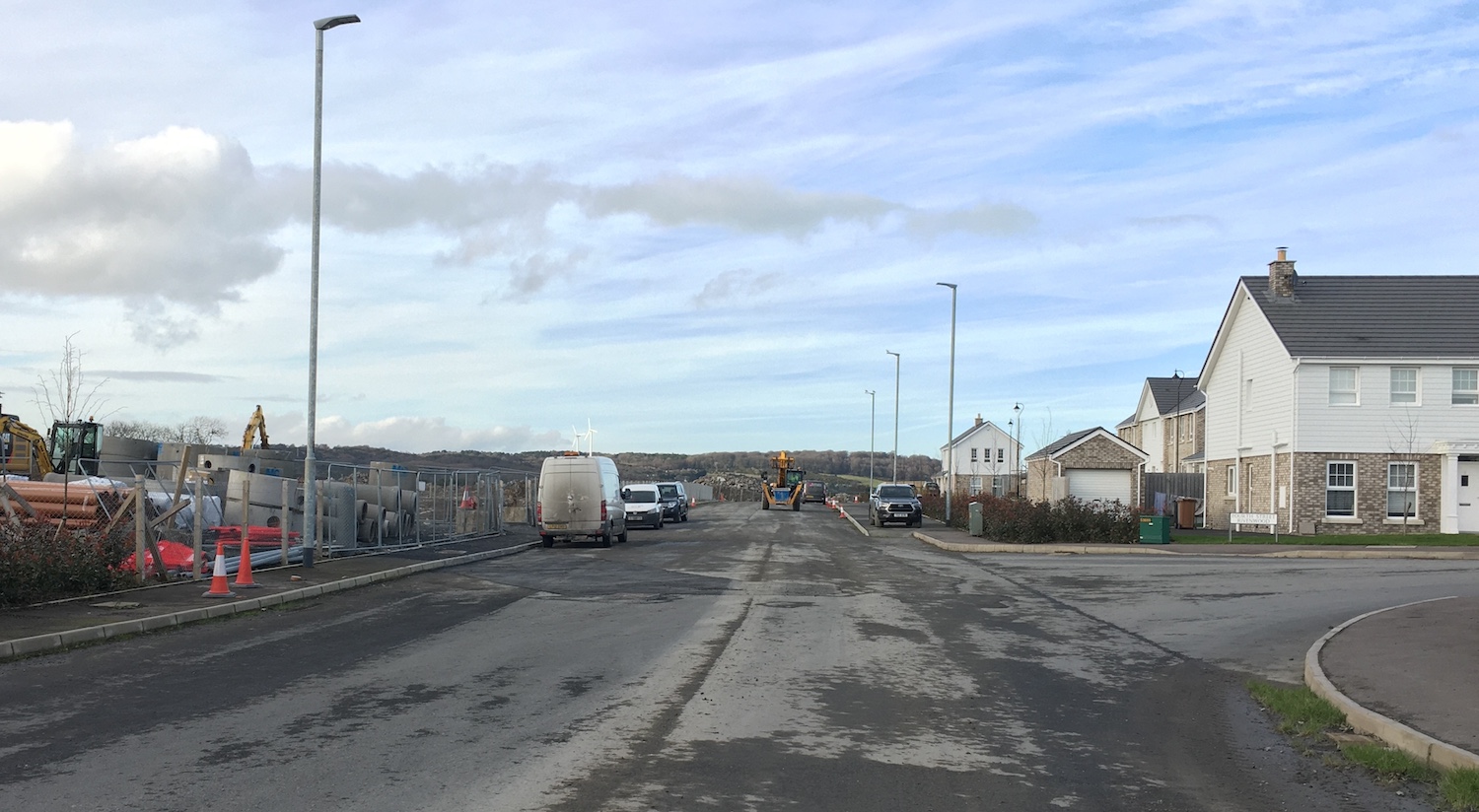

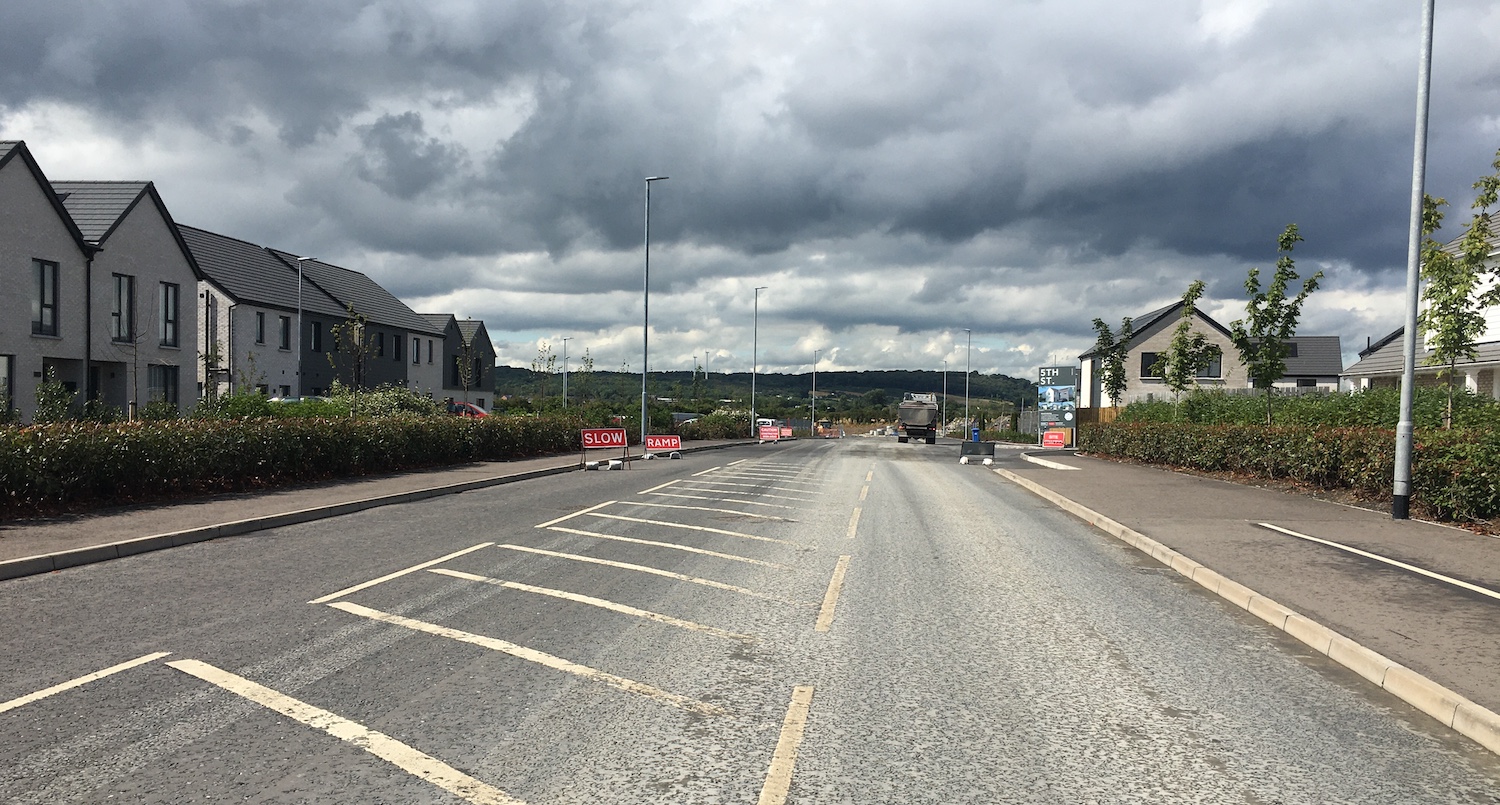

                        Current terminus of Rivenwood Boulevard as seen
                        on 21 February 2024 [Keith Nash]

                      9 Feb 2024: This update is to
                        share a few photos of the new junction on the
                        A21 Bangor Road at Beverley Garden Village, what
                        will eventually be the northern terminus of this
                        link road. The signalised junction opened about
                        six weeks ago and so it far seems to have gone
                        smoothly. With thanks to Keith Nash for sharing
                        these.

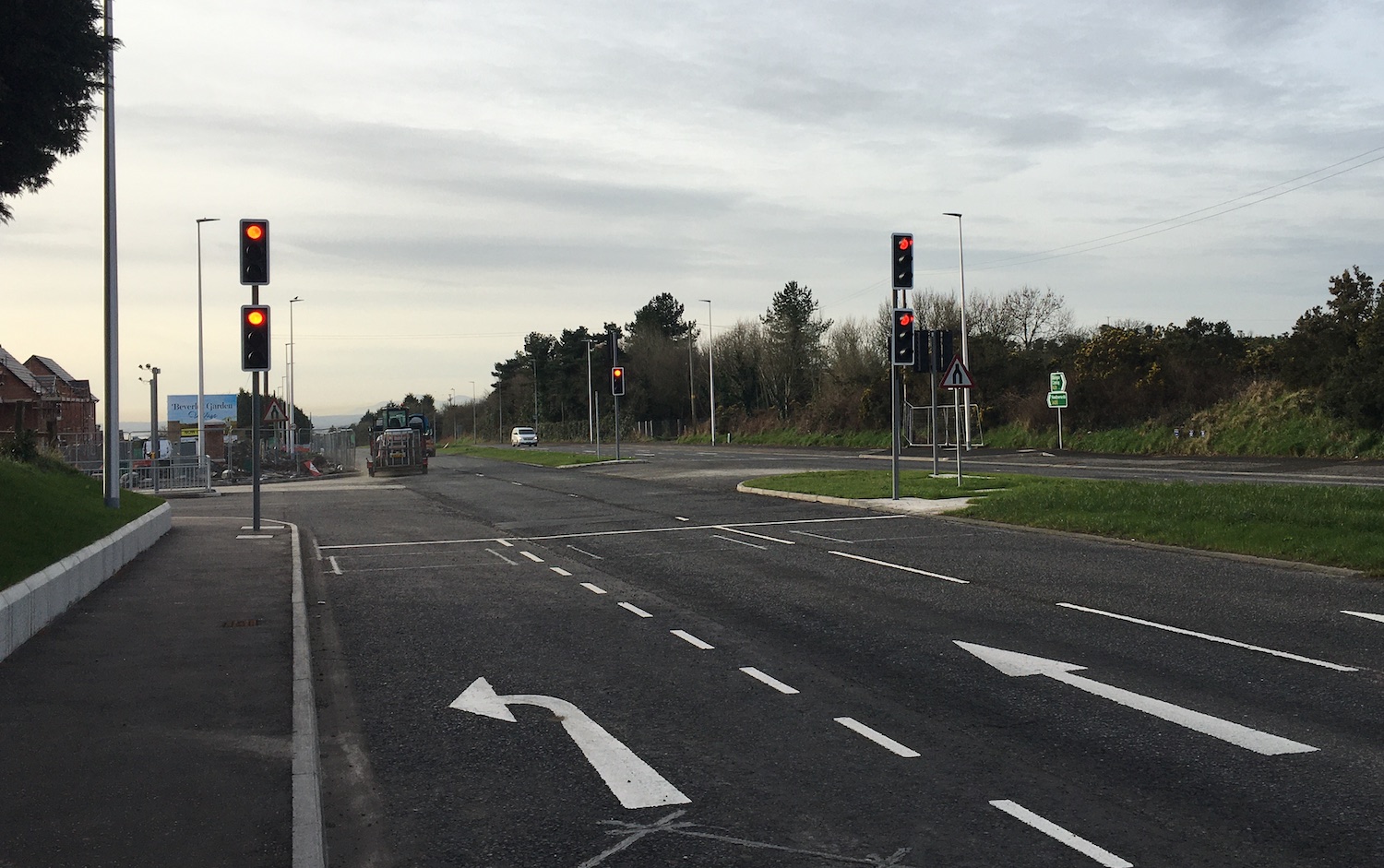

                        View south with Bangor behind the camera and
                        Newtownards ahead on 7 Feb 2024. The new link
                        road is on the left, with traffic signals in
                        place. A turn-left filter lane has been added.
                        [Keith Nash]

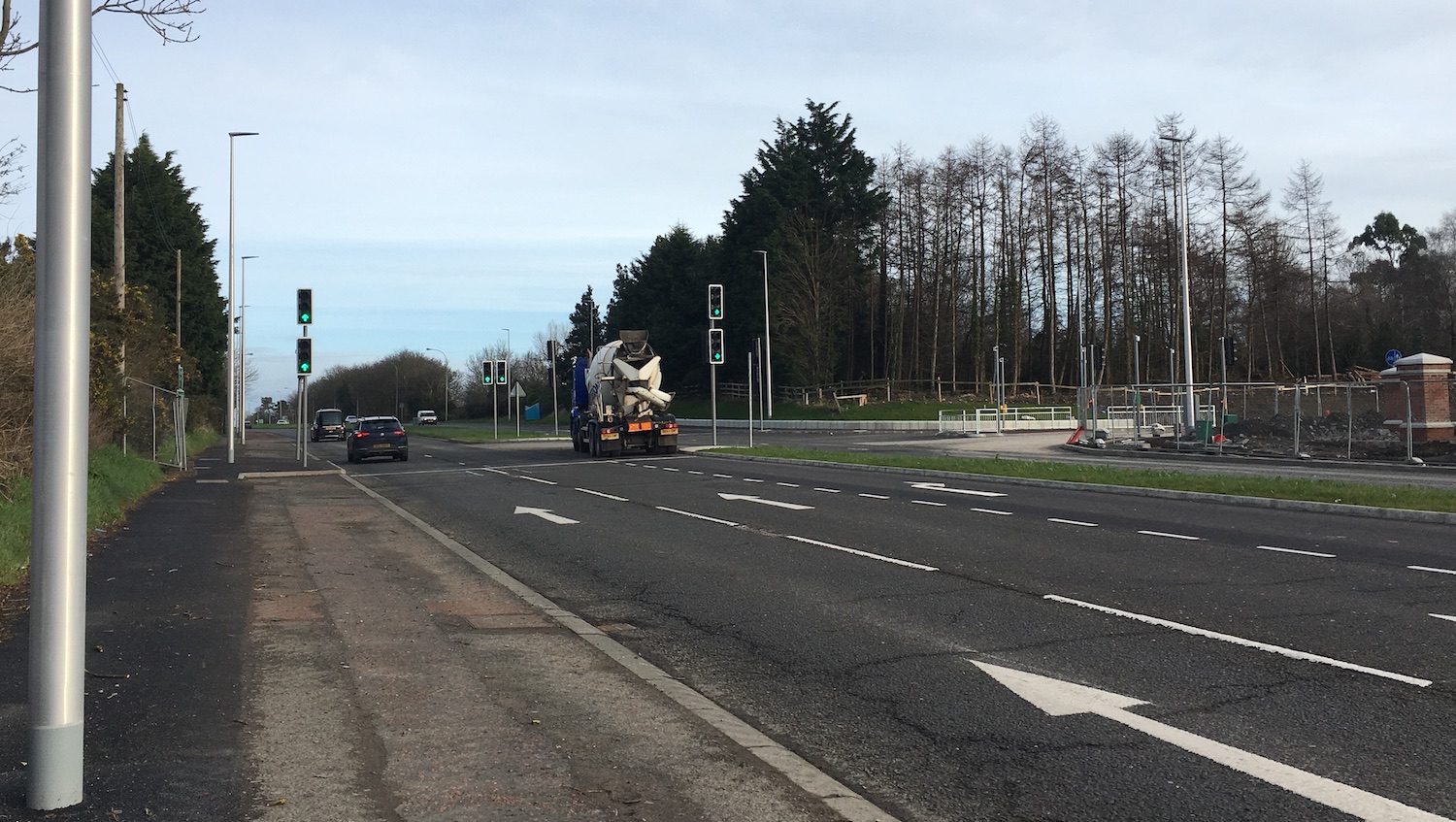

                        View north with Bangor ahead and Newtownards
                        behind the camera  on 7 Feb 2024. The new
                        link road is on the right, with traffic signals
                        in place. A turn-right lane has been added in
                        the central reservation. Same view as the photo
                        on 30 Aug 2023 below. [Keith Nash]

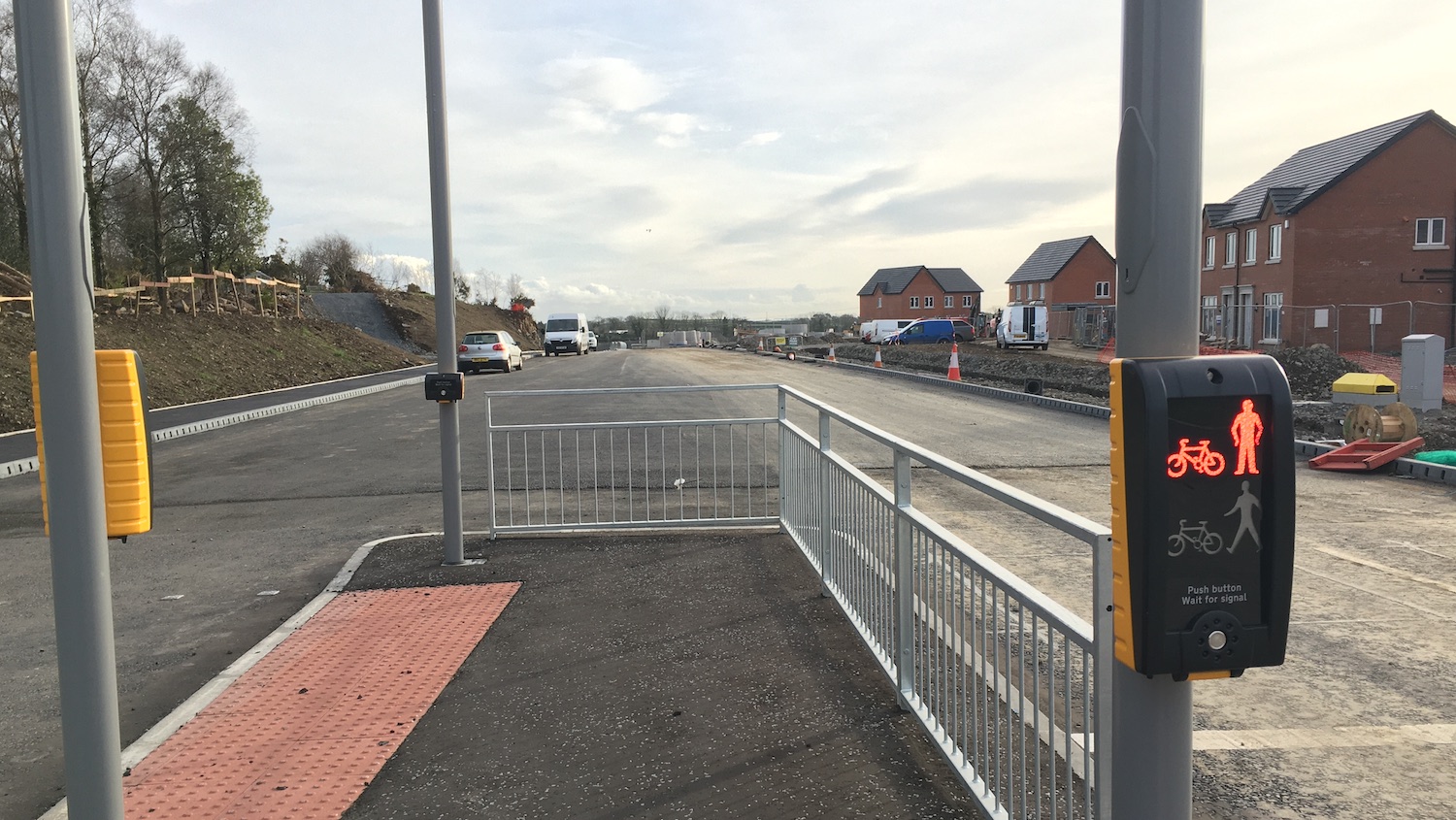

                        View along the first section of the new road
                        from the A21 junction on 7 Feb 2024. No lanes
                        have been painted yet. 36 houses are being built
                        here in phase 1 with 12 on sale. [Keith Nash]

                        View west from the new road towards the new
                        junction with the A21 on 7 Feb 2024. The traffic
                        island ahead is the same one shown in the
                        previous image. [Keith Nash]
                      4 Jan 2024: A very brief update to say
                        that the traffic signals on the new junction on
                        the A21 Bangor Road came into operation on
                        Wednesday, 20 December 2023. This will allow
                        safe access to the new housing at that end of
                        the scheme, to be known as Beverly Garden
                        Village. I haven't got photos yet but will aim
                        to. With thanks to K Nash.

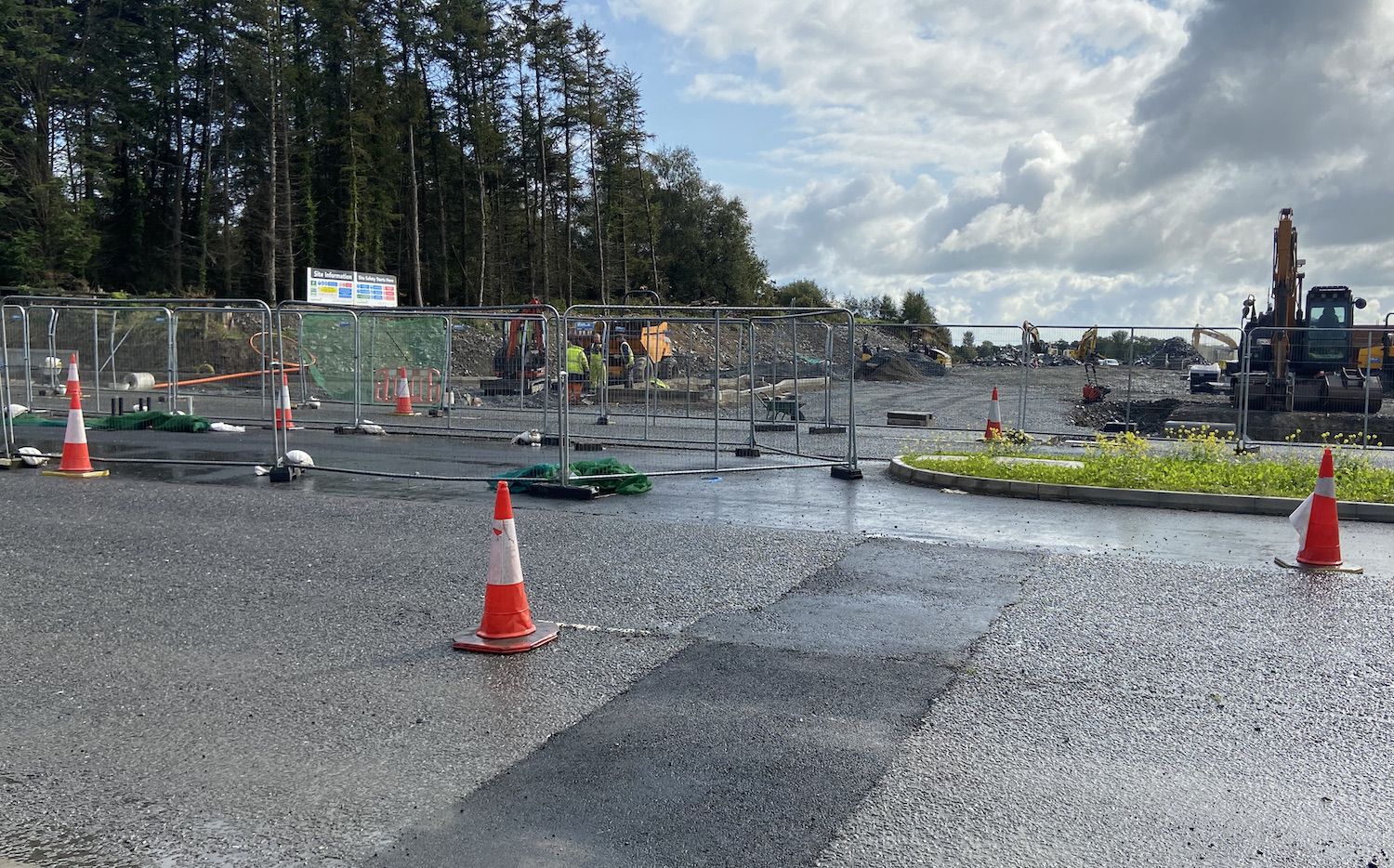

                      30 Aug 2023: Work on the new junction on
                        the A21 Bangor Road has progressed over the
                        summer, with traffic currently coned down to one
                        lane with a 40 speed limit. The photos below
                        were taken today and show what looks very much
                        like a signalised junction being built. Work on
                        the new road itself hasn't advanced much, but as
                        new houses are now going up close to the
                        junction, it's likely that the first short
                        section of the road will be needed soon.

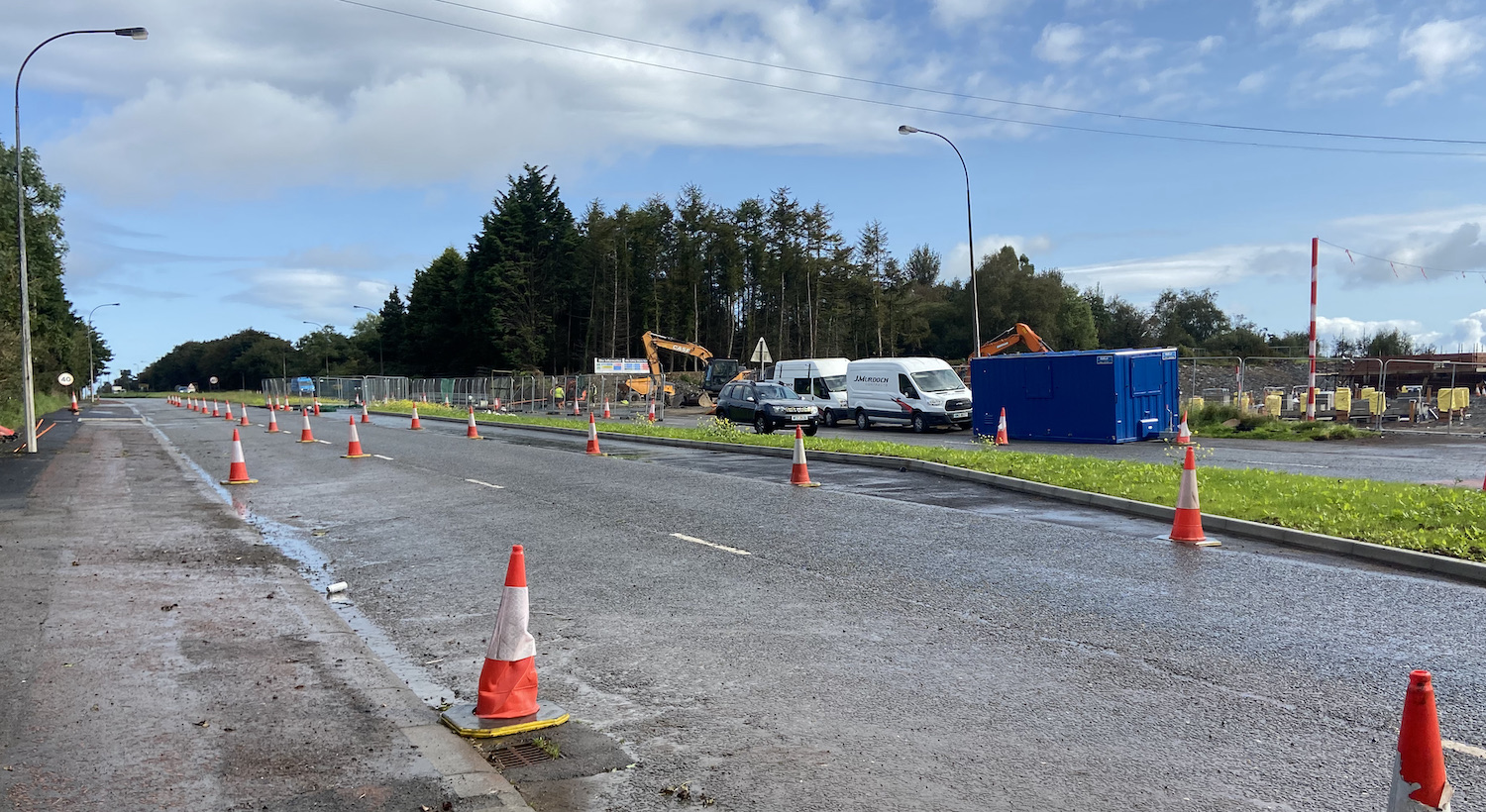

                        Pic 1: View north along the A21, with the future
                        road heading to the right where the diggers are.
                        Part of the central reservation has been
                        reconstructed to form a right-turn lane. Note on
                        the extreme left a new build-out of kerbs onto
                        the hard shoulder. This would be quite a
                        dangerous setup without traffic signals,
                        implying a traffic signal column will be placed
                        there. 30 Aug 2023. [Wesley Johnston]

                        Pic 2: View east across the A21 along the line
                        of the new road, 30 Aug 2023. The new right-turn
                        lane is visible in the foreground. On the new
                        road itself there is a new traffic island which
                        will likely separate the two directions of
                        traffic, or possibly separate a left-turn filter
                        lane for traffic heading south. The road base of
                        the new road is taking shape, but only for about
                        100 metres at this point in time. Some new
                        houses are being built off frame to the right of
                        the shot. [Wesley Johnston]
                      17 May 2023: Work has been ongoing over
                        the past six months on the Donaghadee Road to
                        Bangor Road section of the new road, starting at
                        the Bangor Road end. After the site was cleared,
                        heaving excavation work got underway to lower
                        the height of the whole site to the level of
                        Bangor Road, as shown in the photograph below.
                        The excavation has been taken right down into
                        the underlying rock which is a major
                        undertaking. Works are due to get underway over
                        the summer on the new junction with the A21
                        Bangor Road, which I suspect is to be
                        signalised. The general area plan can be seen in
                        the previous update below.

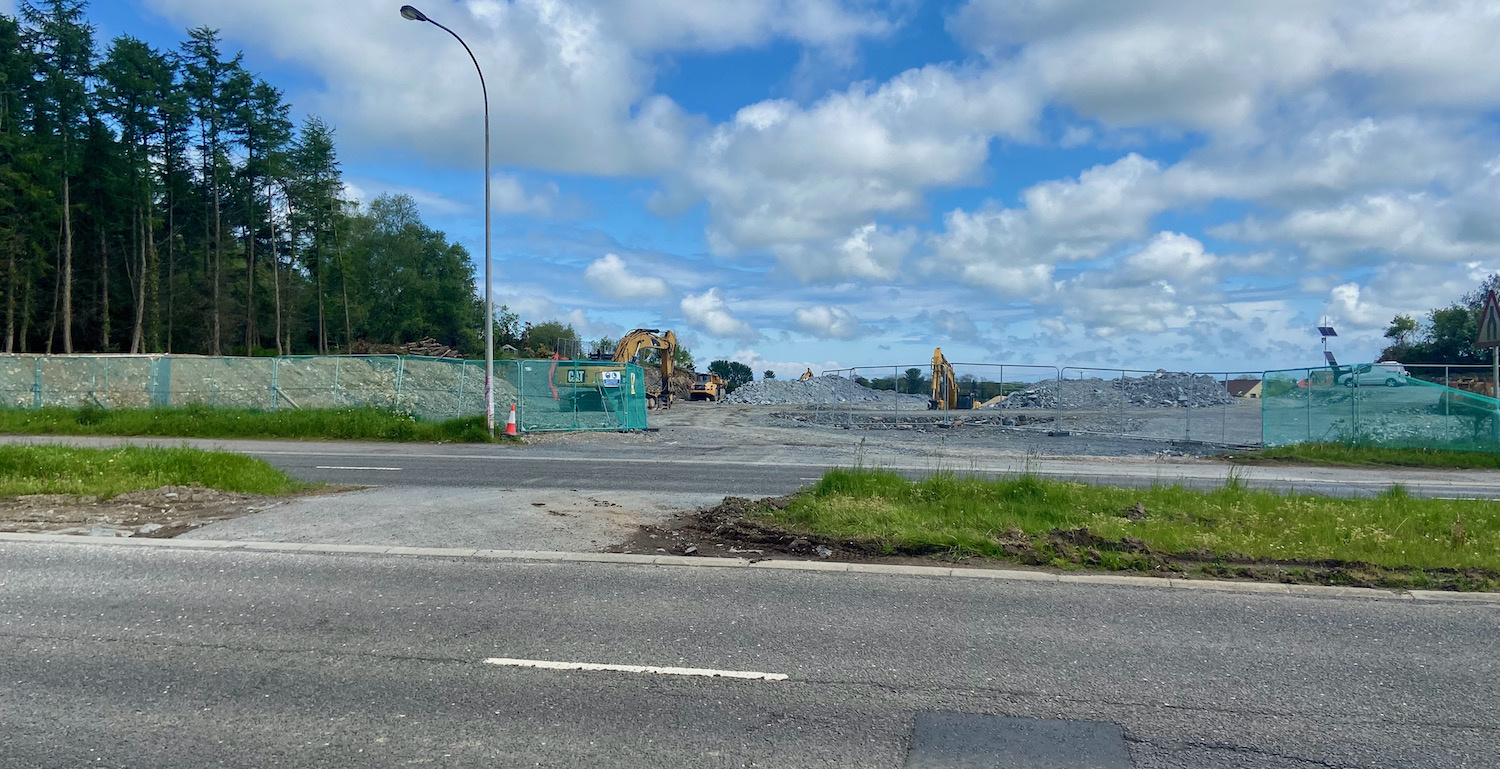

                        View across the A21 Bangor Road on 11 May 2023,
                        showing clearance works for the western end of
                        the new road. The whole site has been lowered
                        down into the bed rock. The A21 here is a
                        dual-carriageway, and the new junction may
                        feature traffic signals. [Wesley Johnston]

                      14 Oct 2022: Six years after work began
                        on the southern part of this new road (Movilla
                        Road to Donaghadee Road) work finally seems to
                        be getting underway on the second section of
                        this road (Donaghadee Road to Bangor Road). As
                        this scheme is developer-led (i.e. developers
                        build and pay for it) this new phase is being
                        built by the developers of the Beverley Garden
                        Village site, a plan of which is included below.
                        So far the works have been site clearance on the
                        site generally, but as the new road is essential
                        to the plan it will need to be provided along
                        with the houses. With thanks to Darren Mackey
                        for letting me know about this.

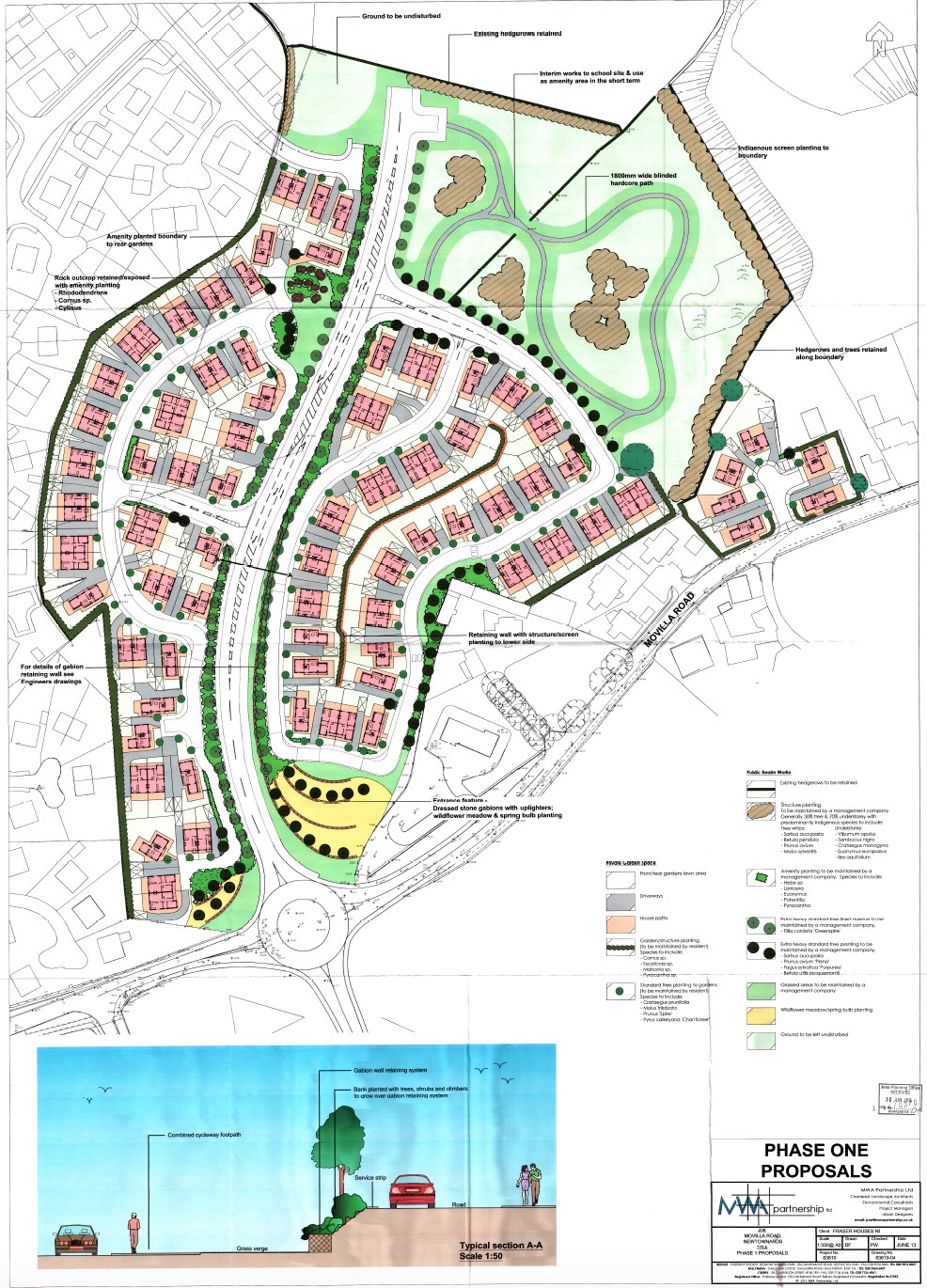

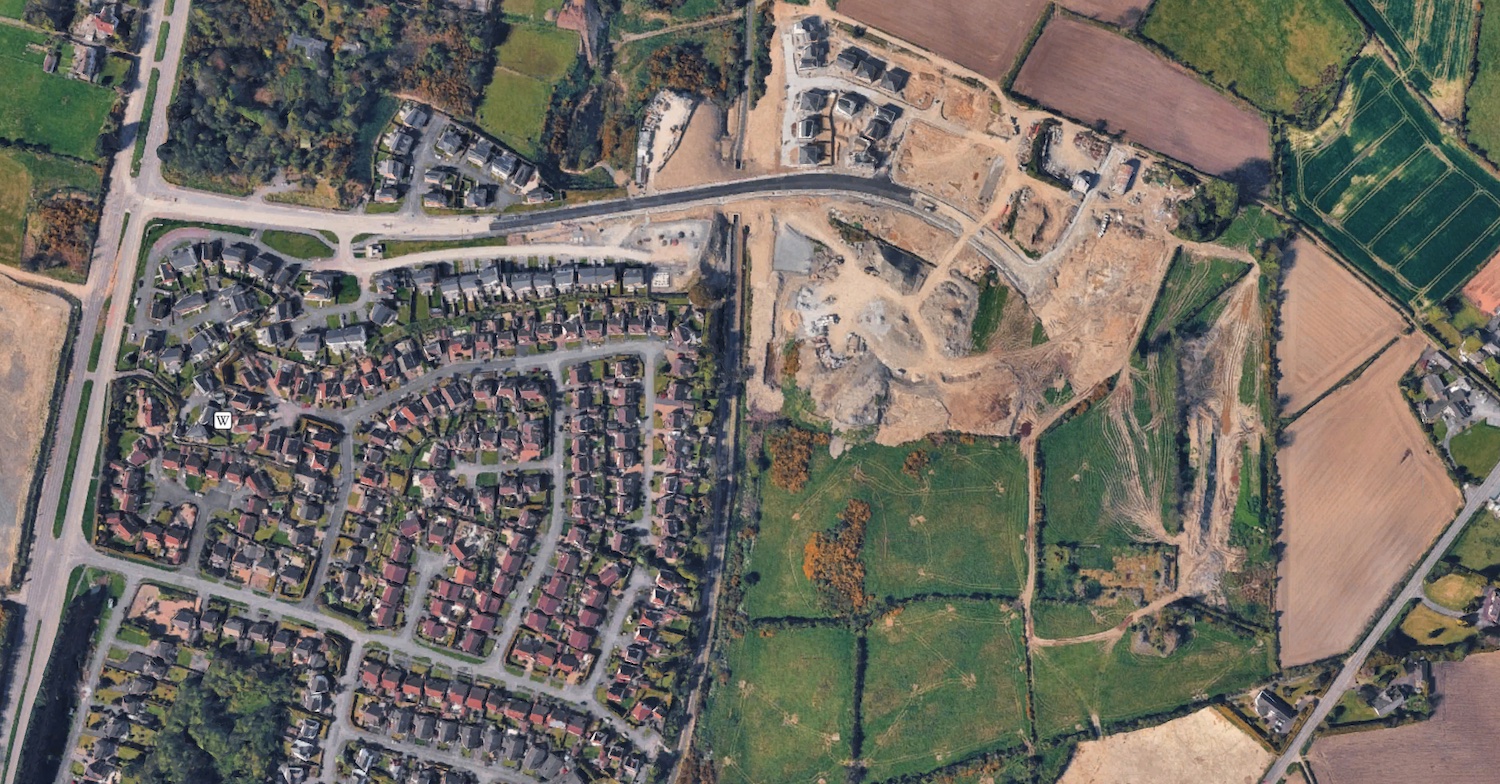

                        Proposed layout of Beverley Garden Village
                        showing the section of the new road from Bangor
                        Road to Doanghadee Road, where a roundabout
                        seems to be anticipated. It's not clear how the
                        new road will link to the Bangor
                        dual-carriageway but traffic signals are
                        plausible if the road generates a lot of
                        traffic. [From scheme developer]

                      2 Mar 2022: The new road continues its
                        slow advance as the developer adds more houses.
                        About 800 metres of the road between Movilla
                        Road and Donaghadee Road is now either completed
                        or underway, all at the Movilla Road end. The
                        road is appearing on Google Maps named Rivenwood
                        Boulevard/Rivenwood Road, but I am not sure if
                        this the "official" name which has to be agreed
                        by Ards & North Down Borough Council. Work
                        began 6 years ago, at which point it was
                        suggested that the whole road could be open
                        within 10 years. This seems very unlikely now,
                        unless the pace of development increases
                        rapidly. Certainly the Covid pandemic will have
                        delayed matters a bit. The developer is
                        currently working on Phase 2, and after this is
                        completed will extend the road further to the
                        north-west as part of phase 3. However phase 4
                        will be at the Donaghadee Road end, so that will
                        require part of the other end of the new road to
                        be built. Phase 5 will close the gap between
                        phases 3 and 4 and hence connect the two ends of
                        the new road together. If the current rate of
                        construction is maintained, then this wouuld be
                        sometime around 2028. The image below is the
                        most recent Google Earth image, showing the road
                        and associated (Phase 2) housing as it was in
                        spring 2021.

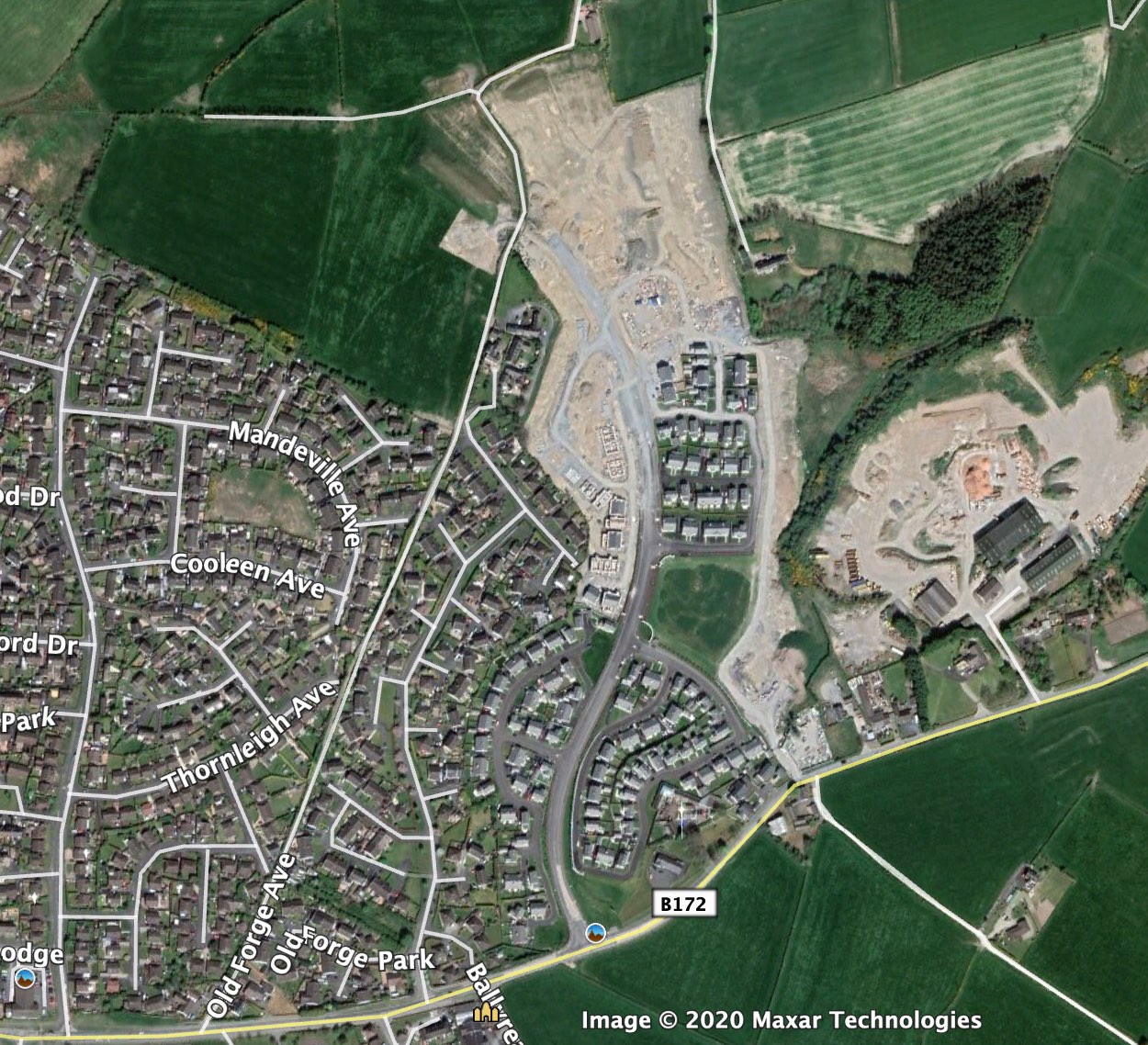

                      Aerial shot of the new link road
                        taken on 24 April 2021 and showing progress at
                        that point. The yellow line at the bottom is
                        Movilla Road. Donaghadee is out of shot to the
                        upper left. [Google Earth]

                      30 Dec 2020: In the four years since the
                        last update the developer has worked away and a
                        number of houses in the Rivenwood development
                        are now occupied. The arterial route through the
                        site (Movilla Road to Donaghadee Road and Bangor
                        Road Link) is now partly build and has
                        apparently been named Rivenwood Boulevard - it's
                        not clear to me whether this is the name
                        approved by Ards and North Down Council, or just
                        a "working" name. In any case, 400 metres of the
                        road was open and in use by the time the image
                        below was taken (during lockdown in April 2020),
                        and an additional 300 metres was under
                        construction. This represents about 40% of the
                        stretch from Movilla Road to Donaghadee Road. At
                        this rate, I'd expect it to take another five
                        years or so to complete this stretch, which is
                        being built as needed as construction
                        progresses. No work has yet taken place on the
                        Donaghadee Road to Bangor Road section.

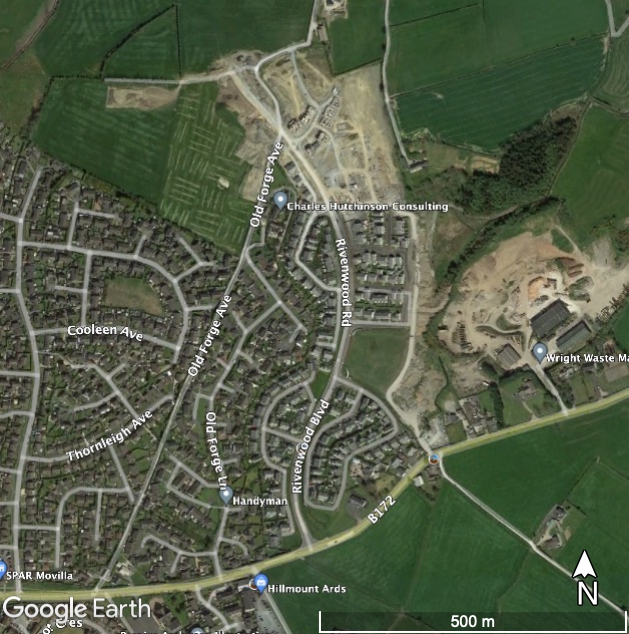

                        Aerial shot of the new link road taken on 25
                        April 2020 and showing progress at that point.
                        The yellow line at the bottom is Movilla Road.
                        Donaghadee is out of shot to the upper left.
                        [Google Earth]

                      19 Jan 2017: After my appeal for images
                        in the previous update on 1 January I am
                        grateful to two people for stepping up to the
                        mark! Firstly, a
                          short video by Carson Tse taken driving
                        east on Movilla Road past the start of the new
                        road on 9 January. This video shows us two
                        things, firstly that the roundabout shown in the
                        planning documents at the start of the new road
                        has NOT been built. Instead the junction has
                        been set up as a signalised junction. And
                        secondly, that it has involved widening a
                        lengthy stretch of Movilla Road (perhaps 100
                        metres) to provide a right-turn lane into the
                        new road. So thank you Carson. And secondly to
                        Paul McIlfatrick who explored the area on foot
                        on 9 January. I include four of his images
                        below. (There is a map at the bottom of this
                        page that may help you get your bearings.) Thank
                        you to Paul for taking and sharing these images.

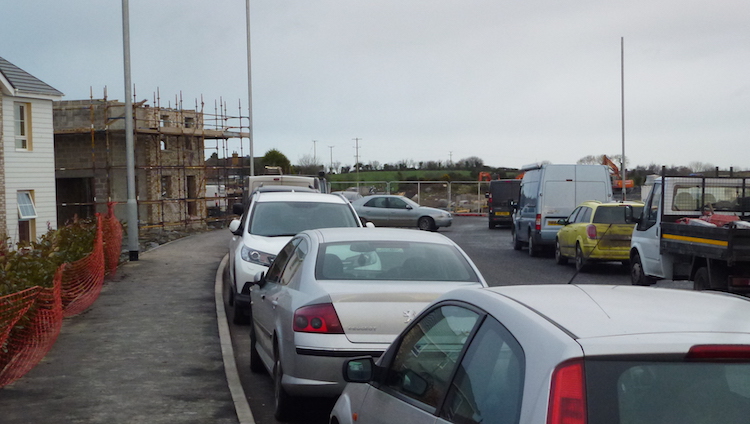

                        Pic 1: View east along Movilla Road on 9 January
                        2017, with the junction at the southern end of
                        the new road now completed but with the lights
                        currently deactivated. Original plans showed a
                        roundabout here. [Paul McIlfatrick]

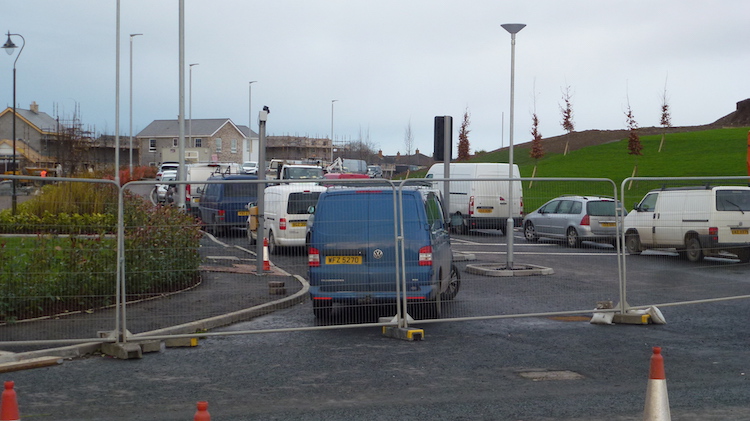

                        Pic 2: Looking north along the first section of
                        the new road on 9 January 2017. The developer is
                        calling the development "Rivenwood", but the
                        road hasn't been formally named yet. [Paul
                        McIlfatrick]

                        Pic 3: Moving a couple of hundred metres north
                        along the new road  towards the point where
                        the completed stretch ends, on 9 January 2017.
                        [Paul McIlfatrick]

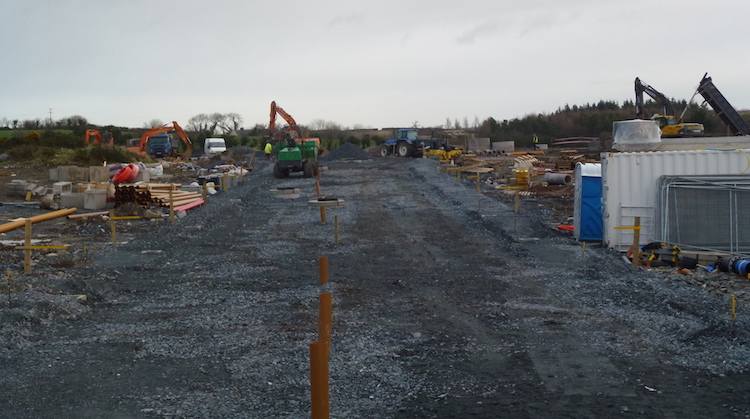

                        Pic 4: The final hundred metres or so of the
                        first phase of the new road under construction
                        on 9 January 2017. In total about 400 metres of
                        the 2.6km road is being built as part of this
                        phase of work. The rest will follow over a
                        period of years. [Paul McIlfatrick]

                      1 Jan 2017: I have not been in the area
                        of this road scheme since the last update in
                        May. At that point it was said that work would
                        begin on the southern stretch in "summer" 2016.
                        This seems to have happened, because Google have
                        now put up imagery that was taken in August 2016
                        and this clearly shows work underway. See
                        picture below. Given that this was taken five
                        months ago, work has surely progressed since
                        then. So if anyone is in the area and has
                        pictures of the scheme as it looks now please do
                        get in touch! If not, I will see if I can get a
                        trip out at some point in the coming weeks.

                        Imagery of work underway on the southern part of
                        the road on 16 August 2016. The road labelled
                        B172 is Movilla Road. Compare to the map in the
                        previous update below and you can clearly see
                        the line of the road. [Google Earth].

                      2 May 2016: According to a news
                          article on the BBC, Fraser Houses, who are
                        now developing these lands, has announced that
                        construction on new houses is to commence this
                        summer, with the first homes completed before
                        the end of 2016. The work is to take place at
                        the Movilla Road end of the N20 site (the bottom
                        right of the map above) in a development called
                        "Rivenwood". Fraser Houses estimate it will take
                        ten years to develop the site fully. This news
                        is relevant in that provision of the "Movilla
                        Road to Donaghadee Road" link is a condition of
                        planning for these homes. However, it is
                        important to stress that the road is not going
                        to be built in its entirety at this stage.
                        According to the most recent planning
                          permission (application X/2014/0370/F)
                        this is phase 1 and only the first part of the
                        distributor road will be provided at this stage.
                        Because the Planning Portal no longer (and very
                        unhelpfully) allows me to link directly to
                        documents relevant to the public, I have instead
                        had to reproduce the map below. This now
                        clarifies what the layout of the southern part
                        of the link road will be, which includes a new
                        roundabout on Movilla Road. Work commencing on
                        the site does raise the hope that this road will
                        be built sometime within the next ten years.

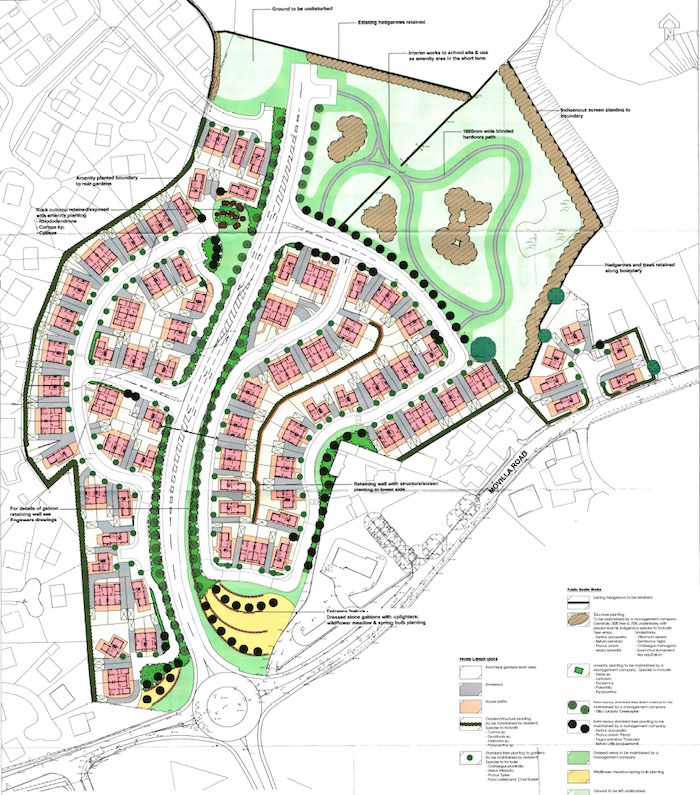

                        Map showing Phase 1 of the attractive Rivendale
                        development and the layout of the southern part
                        of the new link road. Movilla Road runs from
                        bottom left to centre right. Click image for a
                        larger version. [Map by the developer]

                     |
