Status
|
Construction scheme
(completed) |
Contractor
|
Gibson (Banbridge)
Ltd
|
Where
|
To
extend Millennium Way, Lurgan, south
east to meet Gilford Road |
Total
Length
|
0.6 km / 0.4 miles
|
Dates
|
Proposed since at
least the 1970s
Promised (for example) in 1976
Phase 1 opened - Dec
2002
Planning permission
granted 2006, renewed - Jan 2012
Planning permission for altered route
granted - Mar 2014
Land purchased via a Vesting Order - 23
Mar 2015
Went out to tender -
Dec 2015 (as of Aug 2015)
Contract awarded - 15 Apr 2016 to Gibson
(Banbridge) Ltd
Work began - 23 May
2016
Road appeared to be
complete and in use - 13 May 2017
(changed from "April 2017" as of Feb
2017; change from "to take 6 months to
complete hence completion late Nov
2016" as of Oct 2015)
|
Cost
|
£5.7m (as of Apr 2017)
|
See
Also
|
General
area map - Google Maps
See also map below
Millennium
Way Phase 1 on this site
|
Click
here to jump straight
down to updates for this scheme.
Phase 1 of the
Millennium Way link road, which opened in 2002,
allowed it to quickly meet its primary objective
- the redevelopment of the lands to the south
west of Lurgan town centre. However for it to
meet its secondary goal - to take traffic away
from the congested town centre, the road really
needed to be extended a little further east, to
the Gilford Road / Banbridge Road junction which
are two of the primary destinations of traffic
travelling along the main street. The map below
shows the approximate route of the extension as
of February 2014. Since the junction of
Banbridge Road and Gilford Road is built up,
this scheme involved more vesting of property
than phase 1 did.
View Millennium
Way Phase 2 Lurgan in a larger map
Updates
16 May 2017: The tie-ins of
Millennium Way to Flush Place/Gilford Road is
now complete with the roundabout essentially
finished and in use. Since there are no longer
any lane restructions, and the road appears
largely complete I am marking it as "completed".
There may still be final minor works to be
carried out. The project took about six months
longer than originally planned, and this was
largely due to difficulties encountered in
relocating the maze of services that were buried
under the site. Well done to the contractor for
completing such a complex project. Finally,
someone at TransportNI was in touch to clarify
that the new road is still the A99, not the A3
as I speculated. So that implies that the sign I
commented on in the first picture below at
Malcolm Road junction is incorrectly showing
"A3" without brackets. At the same time, it does
perserve one of our oddest road numbers for
future generations of road enthusiasts to puzzle
over!
13 Apr 2017: The new road
is essentially complete at the western (Malcolm
Road) end and work is now underway to complete
the roundabout at its eastern (Flush
Place/Gilford Road) end. This has required a
closure of part of Flush Place, and as a
consequence traffic was routed along the new
road from the morning of Monday 10 April,
initially westbound and then, later in the day,
eastbound. TransportNI had issued a
press release noting that diversions would
be in place all this week with Millennium Way
used as part of the diversion. The press release
does NOT say what will happen after this week -
it's possible that the road will then close
again for a period. Either way, it was an
exciting time for road users to be able to try
out this relatively short but potentially very
useful stretch of road. The press release says
that project completion is now timetabled for
"late May", about six months later than
originally planned. The six photos below were
taken by two different people (thank you) on 10
April. Interestingly, the new signage on the
road indicates that the new road bears the
number "A3" rather than "A99" as phase 1 has
been designated for the past decade. Since the
existing main street is the current A3, this
strongly suggests that Lurgan town centre will
be de-trunked and lose the A3 number once the
new link is completed. This means the rather odd
number "A99" may well be about to disappear back
into the illogic that it came from! With thanks
also to John Campbell for information on this
week's events.

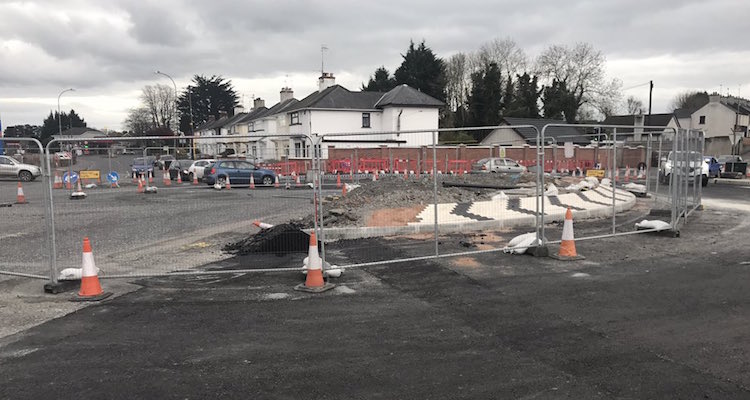

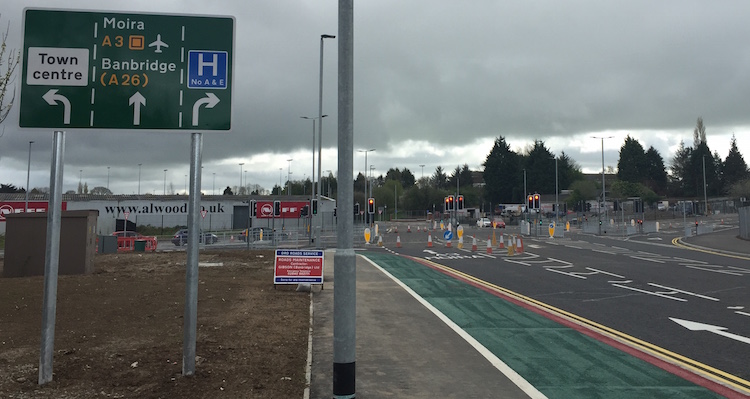

Starting at the western end this is the view
east from the existing Millennium Way, across
Malcolm Road (to the left ahead) and then onto
the new road on 10 April 2017. Cars can be seen
emerging from the new stretch of road. [Mark
Turkington]

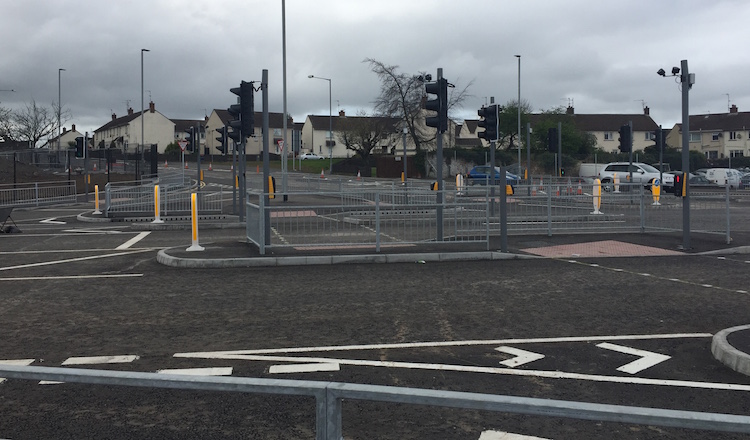

The newly enlarged signalised junction between
Millennium Way and Malcom Road is huge - an
absolute forest of traffic islands, pedestrian
barriers and traffic signals, interlaced by
multiple traffic lanes. It looks as if a
pedestrian crossing the junction in this
direction will have to negotiate four separate
crossings in sequence. 10 April 2017. [Mark
Turkington]

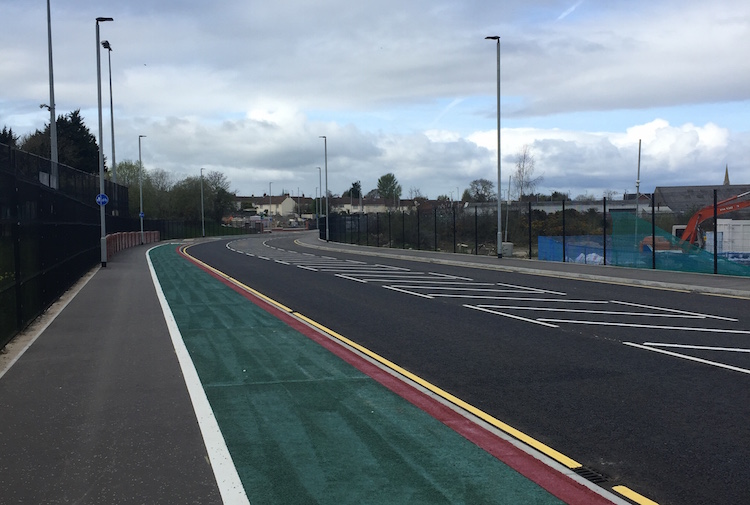

View west from half way along the colourful new
section of Millennium Way showing that it
features one lane each way with a generous
central hatched area, brightly-surfaced green
cycle path, red edge markings and yellow parking
restriction lines. 10 April 2017. [Mark
Turkington]

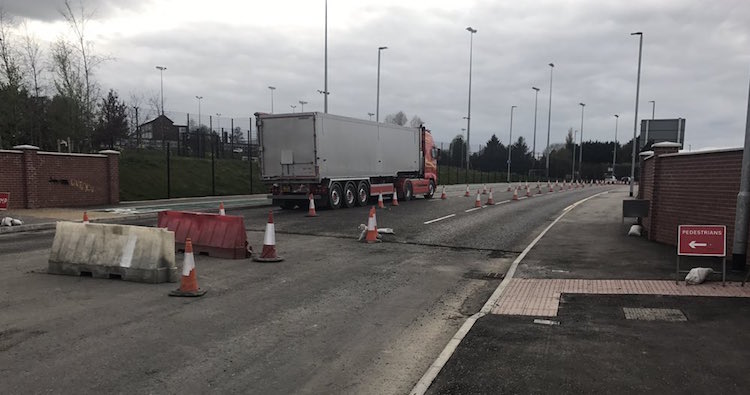

This view looking west from Flush Place shows
that this end of the road is still incomplete,
though being used this week by vehicles as a
diversion route. 10 April 2017. [Anonymous
contributor]
At Flush Place the new roundabout is taking
shape in stages as traffic management allows -
here we see one half of the central island in
place on 10 April 2017. [Anonymous contributor]

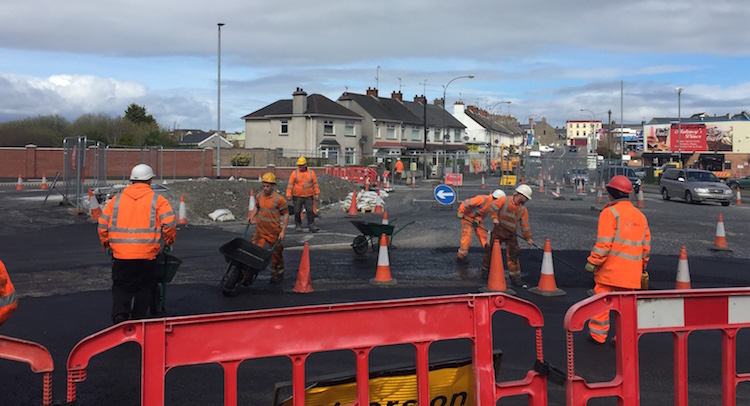

Contractor busy putting down blacktop surfacing
on 10 April 2017 - perhaps as part of temporary
traffic management. This is the area where the
newly enlarged roundabout is being built. [Mark
Turkington]
22 Feb 2017: Four months on
from the previous update, and work is still
ongoing on this scheme. TransportNI issued a press
release at the start of the year warning
that the work to tie-in either end of the new
road to the existing road network would be
commencing on 9 January, and that's what been
happening. A second press
release yesterday updated this to note
that Flush Place (at the Gilford Road end) will
be closed for two weeks from 27 February. It
also confirms that completion is now scheduled
for April. The pictures below were taken by a
contributor who prefers to remain anonymous
(thank you) about a fortnight ago and show the
works to tie-in the Russell Drive end of the
scheme seen from three different angles at that
time. At this point Russell Drive/Malcolm Road
was entirely closed to facilitate the works.

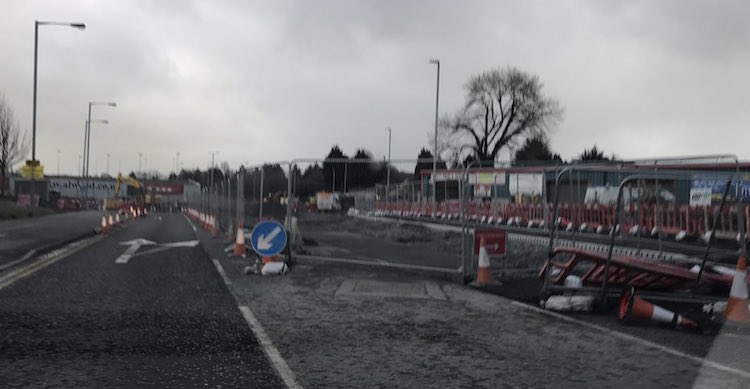

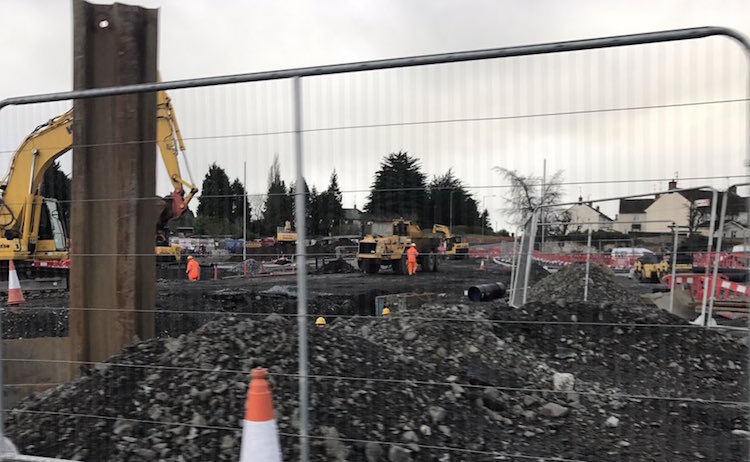

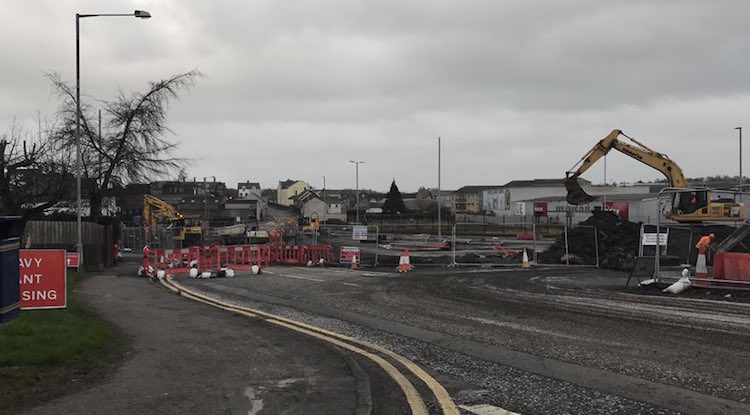

View south from Malcolm Road along Russell Drive
c5 Feb 2017. The road here is closed to allow
the tie-in to the new road (which heads off to
the left). This
is the same view before work began.
View east along the existing part of Millennium
way towards the junction with Malcolm Road and
hence the new road, c5 Feb 2017. This
is the same view before work began.
View south along Russell Drive
from Transa Way towards Malcolm Road and the
junction with the new road (which heads off to
the right), c5 Feb 2017. This
is the same view before work began.
19 Oct 2016: In my previous update a
month ago I noted good progress on much of the
scheme but that nothing had so far happend at
the Gilford Road, where the existing roundabout
is to be enlarged. TransportNI issued a press
release two days ago to comment that
progress has been "slower than expected"
both here and at the other end, on Russell
Drive. They explain that "Both junctions
contain a significant amount of utility
provider equipment and despite considerable
advance works the necessary alteration and
diversion of this equipment has been
protracted and has proved more challenging
than anticipated". When rebuilding a road,
the various utilities (such as phone cables,
electricty wires, sewers, water mains) all need
diverted partly so that they don't get damaged,
and partly to ensure they are still accessible
once the road has been moved. Only the owners of
the utilites can move them, so this involves
close work between the utility companies,
TransportNI and the contractor. So it sounds as
if this process has not been plain sailing, and
that more time than anticipated is needed for
all this work to be done. The press release goes
on to anticipate completion in "Spring 2017". We
had previously anticipated November 2016, so if
we were being generous and took Spring to mean
"March" then that would represent a four month
delay.
14 Sep 2016: I was in Lurgan yesterday
and just managed to get some pictures of
Millennium Way before the sun set. They show
that progress continues to be good. Work on the
tie-ins at the Russell Drive end (west) and the
Gilford Road end (east) are ongoing, but there
are no changes as yet to the signalised junction
at the former, and no sign of work to enlarge
the roundabout at the latter.

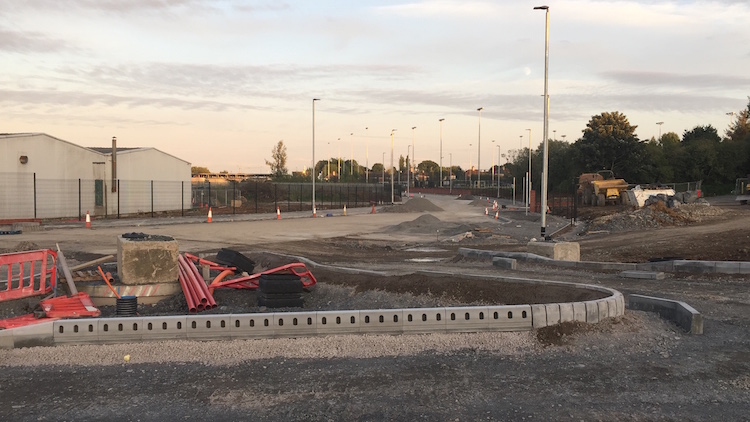

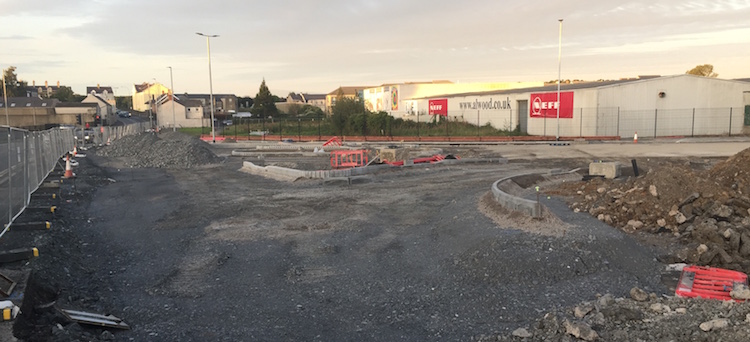

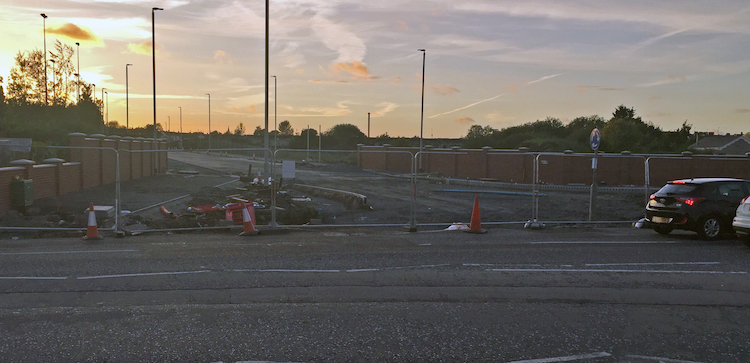

Pic 1: View looking north from Russell Drive on
13 Sep 2016 with Phase 2 of Millennium Way
heading off to the right. Ahead you can see
kerbing now in place for the traffic islands at
the junction. [Wesley Johnston]
Pic 2: Walking forwards from the previous shot

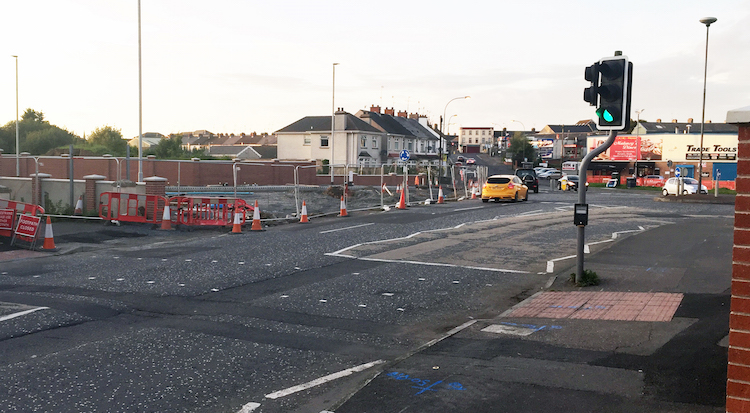

and turning to the right, this was the view east
along Millennium Way Phase 2 on 13 Sep 2016. The
triangular island in the foregound separates a
left-turn filter lane. Note the drainage
contained in the kerb, something TransportNI
have got very keen on in recent schemes as it
negates the need for metal grilles in the road.
[Wesley Johnston]
Pic 3: Moving to the Gilford Road end of the
scheme, this is the view north towards the
existing roundabout on 13 Sep 2016. It is to be
enlarged but so far, other than some painted
lines on the footpath, there is no sign of this
work commencing yet. [Wesley Johnston]
Pic 4: Finally, in fading light, this was the
view west along Millennium Way Phase 2 from
Gilford Road on 13 Sep 2016. [Wesley Johnston]
30 Aug 2016: We are now half way through
the six month construction period for this
scheme and progress has been very good. The
photos below were all taken by on 22 August by a
contributor who prefers to remain anonymous
(thank you) and show the progress at both ends
of the scheme (from Russell Drive at the west
end and Gilford Road at the east end). The
photos show that the kerbs and street lighting
columns are now in place along the bulk of the
scheme, so presuambly the drainage system is
also in place. Work now seems to be focused on
(a) the subsurface of the road itself and (b)
enlarging the existing Gilford Road roundabout
at the eastern end, which seems to be well
underway.

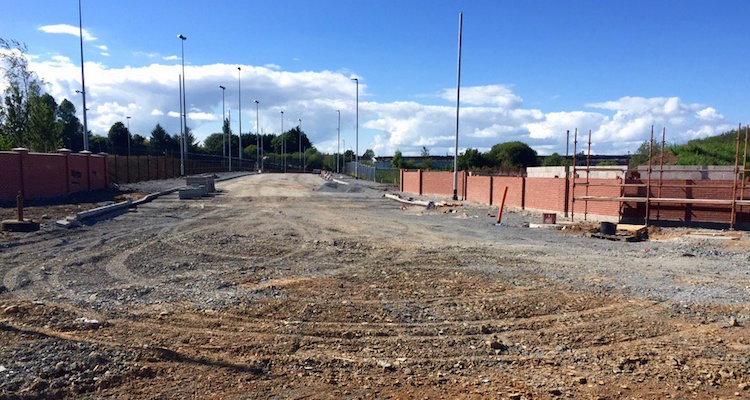

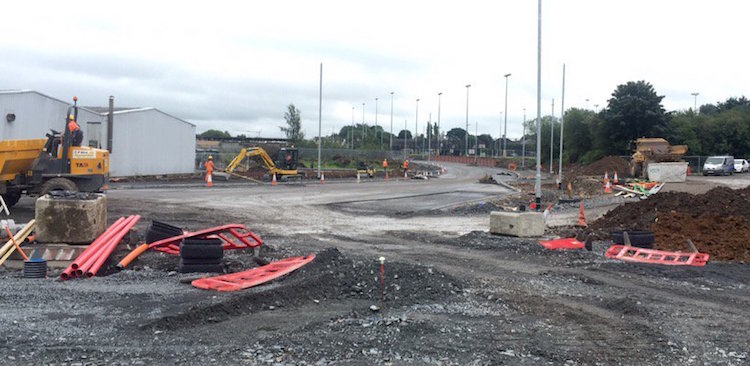

View north-west along Millennium Way Phase 2
from Gilford Road roundabout on 22 August 2016.
The road is well formed up ahead, while the
large area of stones in the foregound will
eventually be part of the enlarged Gilford Road
roundabout. TransportNI are adding nice
red-brick feature walls on either side of
Millennium Way which is a nice touch. [Anonymous
contributor]
Taking a few steps back grom the previous shot,
this is the north-west along Millennium Way
Phase 2 looking across Gilford Road where it

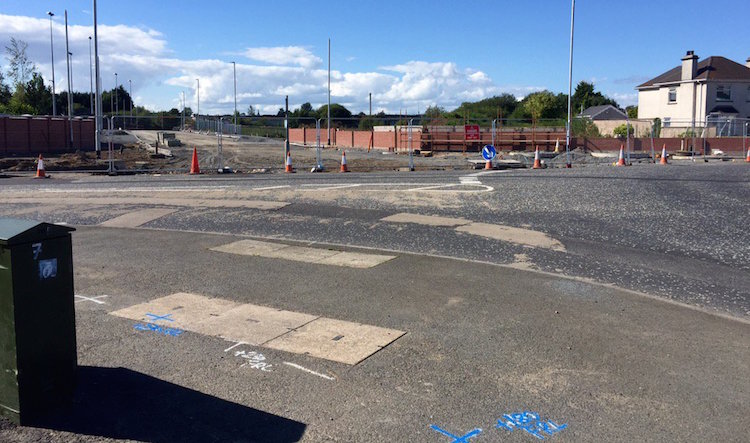

meets the existing roundabout (off shot to the
right) on 22 Aug 2016. This rounabout is being
enlarged. The lines on the footpath either mark
the location of underground services, or they
are indicators of where the relocated kerbline
should go. This is the same
view taken in May 2016. [Anonymous
contributor]
Moving to the other end of the scheme, this is
the view south east along Millennium Way Phase 2
from Russell Place on 22 Aug 2016. The road is
well-defined along its middle stretch, but this
location - where the existing signalised
T-junction will become a cross-roads - still
shows evidence of a lot of ongoing work. This is
the same
view taken in May 2016. [Anonymous
contributor]
4 Jun 2016: We now have our first shots
of work underway, with grateful thanks to Martin
Young who visited on 1 June. Both pictures are
taken from Russell Drive, ie the western side of
the scheme (see map above). It is great to see
work finally underway on this scheme almost 14
years after the completion of Phase 1. The
scheme should be completed by late November
2016.

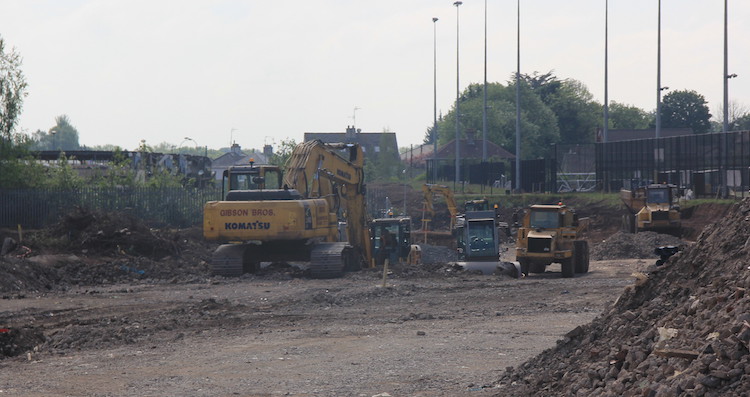

Pic 1: View north-east along Russell Drive on 1
Jun 2016 showing the site of the derelict houses
that have now been removed to make way for the
road. Millennium Way Phase 1 currently
approaches from off frame to the left and ends
at the junction just visible on the left of this
shot, where the painted arrows are. It will
continue to the right, between the photographer
and the industrial building. [Martin Young]

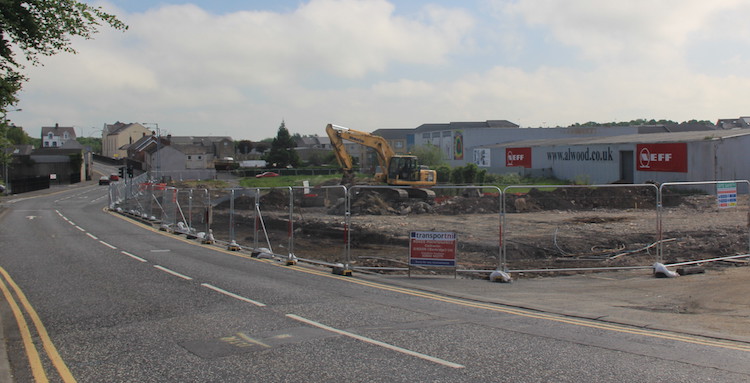

Pic 2: Walking forward about 50 metres from Pic
1, to the Millennium Way Phase 1 junction, this
is the view east along the line of the new road
on 1 Jun 2016. The high mast lights on the right
are for the pitches beside Lurgan Junior High
School. The new road will run alongside the
fence visible here. [Martin Young]
30 May 2016: The main construction
contract got underway a week ago, on Monday 23
May as reported in the Lurgan
Mail and then in a press release by the
new Department
for Infrastructure (DFI, which has now
replaced the Department for Regional
Development). The picture below was released by
the DFI on 26 May. It is not captioned, but the
person on the left is the new Minister for
Infrastructure Chris Hazzard (Sinn Féin) who is
settling into his new job. The background is
presumably the site of the Millennium Way Phase
2 showing signs of lots of activity. With a
construction period of six months, and starting
on 23 May, we can expect completion by late
November 2016.
The new Minister for Infrastructure Chris
Hazzard (left) with two other un-named people
(possibly representatives of TransportNI and/or
the contractor, Gibson (Banbridge) Limited.
[Dept for Infrastructure image]
24 Apr 2016: The construction tender for
this scheme was awarded to Gibson (Banbridge)
Ltd on 15 April - congratulations. Construction
is likely to get underway very soon. To this
end, the row of derelict terraced houses that
have sat for many years on Malcolm Road has
finally been demolished - see image below. These
houses stood in the way of the eastward
extension of Millennium Way. Construction is due
to last approximately six months, so we can
expect to see completion around Hallowe'en –
almost 14 years after Phase 1 opened in December
2002.

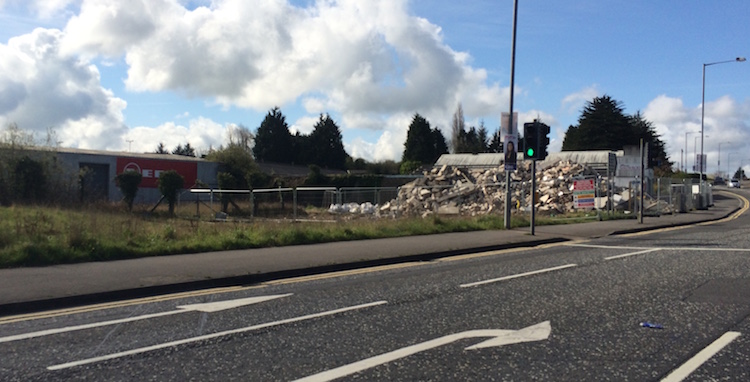

View south along Malcolm Road on
23 April 2016 showing the row of terraced houses
now demolished. The existing A99 Millennium Way
runs to the right of the shot here, and the
extension will run to the left through where the
rubble is. This
is the same view before work began. [Chris
Scott]
31 Jan 2016: The tender to construct
this scheme ended on 28 January, so we will
hopefully see a contractor appointed within the
next month or two. The DRD Minister mentioned
the scheme in a Written
Answer (AQW 52171/11-16) in the Assembly
last week, where she said "It is anticipated
that construction of this scheme will commence
in May / June 2016
subject to funding being made available".
The money has still not been allocated, but the
scheme is so cheap (relatively speaking) that it
is very likely to get funding. In addition, the
DRD tend not to put schemes like this one out to
tender unless they're fairly confident of
getting the funding. So I think we're likely to
see work begin on Phase 2 of Millennium Way by
the summer. Welcome news for Lurgan.
19 Dec 2015: This scheme is continuing
to edge closer to construction. The tender
for construction was released during the
past week, with a closing date of 28 January
2016. It does not seem to have been advertised
more widely around the EU, probably due to its
relatively small scale, so this should simplify
the tender process. With a fair wind we could
see a contractor appointed by March with
construction likely to begin fairly quickly
after this. Good news for Lurgan, 13 years after
the completion of Phase 1!
29 Oct 2015: The DRD has published their
most
recent procurement plan, and it lists this
scheme. It gives the construction cost as £2m
though note that this is not the total
project cost, which also includes planning and
land acquisition. It states that the contract
should be awarded in March 2016 with a total
construction period of 6 months. Schedules like
this have a habit of slipping, so don't be
surprised if it gets delayed beyond March 2016,
but let's hope for the best case scenario
nonetheless.
14 Aug 2015: The DRD web site is now
listing this scheme on its "Future
Tenders" list. This is the list of
construction projects which the DRD think are
likely to be put out to contractors in the near
future. The date being given as of today is
"November 2015". Procurement of road schemes
usually takes anything up to 9 months, with
construction generally commencing very quickly
after a contractor has been appointed. I would
caution that tenders listed on the "Future
Tenders" page have a tendency to get deferred
several times, so in practice it may slip into
2016, but even if it were to slip by a few
months it's plausible that construction of this
scheme could be underway by late 2016, which
would be great news for Lurgan. The cost
estimate is being given as £2m. This is likely
to be the construction cost only, the overall
project cost also including things like land
acquisition and design costs.
3 May 2015: The DRD Minister was asked
about this scheme in the Assembly on 21
April. He confirmed the making of the Vesting
Order on 23 March (see previous update below)
and this became live on 28 April. When pressed
on when the scheme might be built, he noted that
there was currently no money allocated for
construction, but that "if funding is
available, it is expected that construction
could commence in spring 2016 and would take
approximately six months to complete". I'm
not sure how seriously to take this as an actual
timescale, and how much it is merely wishful
thinking, but the fact that he is prepared to at
least hazard a timescale, and because the
Vesting Order has now been made, suggests that
it's not going to be too far into the future.
25 Mar 2015: The DRD Minister made
the Vesting Order on Monday 23 March. This
was published in draft form in November 2014
(see previous update). The Vesting Order gives
TransportNI the right to compel landowners to
sell them the land needed for the scheme, and
this action means that TransportNI have now gone
ahead and bought the land. The fact that it has
now been made means that the Minister did not
see the need for a public inquiry. The same
press release also finally gives us a cost
estimate for the scheme - £6m. It may not be a
coincidence that this has happened a week before
the end of the financial year - it could be that
as budgets are tidied up, any spare unspent cash
can be used for things like this. This does not
mean that construction is imminent, but this is
an important step towards construction. Since it
doesn't look as if a public inquiry is needed,
the next step would be to identify funding and
then start a procurement process to appoint a
contractor to build the road. There is really
nothing other than money needed to proceed now.
23 Nov 2014: TransportNI (the new name
for Roads Service) published
a draft Vesting Order for this scheme on 7
November 2014. People have until 16 December to
inspect the Vesting Order and object if they so
wish. A "Vesting Order" is the legal document
required to compel landowners to sell the land
needed for the scheme to TransportNI. The fact
that it is a "draft" means that at this stage it
is their intention to purchase this land, but
the actual purchasing has not yet occurred.
However, the fact that they are about to spend
money on the land implies that TransportNI are
serious about building this scheme in the
not-too-distant future which is good news.
Therefore I've moved it up the list to "schemes
in planning". The same press release also says
that there won't be an Environmental Impact
Assessment for this scheme, presumably because
in their judgement the scheme does not meet the
criteria requiring such an assessment. It's
still not clear whether there will be a public
inquiry, since public inquiries for road schemes
are often (technically speaking) inquiries into
Environmental Statements, and it now looks as if
there won't be one for this scheme. Finally, the
press release reveals that Millennium Way has
been given the number A99, which is a completely
random number to choose, devoid of any apparent
logic, but entirely in keeping with the
whimsical way roads have historically been
numbered here! So hurrah for the A99!
10 Apr 2014: The planning
application for the revised route of Phase
2 of Millennium Way, which was submitted in
September 2013, was granted on 24 March 2014.
This was then reported in a Question
for Written Answer in the Assembly a few
days later. The Minister went on to make two
interesting comments. Firstly "Due to the
number of landowners affected, the project is
likely to require a Vesting Order and a Public
Inquiry may also be required, to
determine if the level of land take identified
is appropriate." The need for a public
inquiry will add time and cost to the scheme,
but is part and parcel of the democratic
process. Secondly he said that "It is
estimated the scheme should take four to six
months to construct" which is the first
time I have heard an actual timescale. Of
course, the scheme has no funding allocation so
even if it cleared all these other hurdles, it
can only go ahead once it has money and that
depends on how it rates against other competing
schemes within Roads Service and within all
Executive departments. In other words, the usual
story!
10 Feb 2014: It's been exactly two years
since the last update, and it seems there has
been some movement on this scheme. In a Question
for Written Answer in the Assembly, the
Minister gave us an update. Although planning
permission was granted in 2006, and renewed in
2012, it seems that the alignment has been
changed slightly meaning that a new planning
application had to be submitted in September
2013, which
you can see here. The application suggests
that the road will be a 2-lane
single-carriageway 600 metres long, with an
enlarged roundabout at the Gilford Road end and
a signalised crossroads at the Malcolm Road end.
You can view a very detailed design document here.
He then went on to say that once permission is
granted (he seems confident that it will) he
will begin the vesting process with landowners
and may need to call a public inquiry. As
always, actual construction will depend on
finding funding in the years to come.
10 Feb 2012: There was an adjournment
debate in Stormont about this project
on Tuesday. An adjournment
debate is a debate held by a private
member of the Assembly concerning an issue
in their constituency, but it's just a
debate and can't lead to any decisions. The
debate essentially provided an opportunity
for various politicians to outline the case
for the road, and the Minister responded by
saying, again, that he agreed with them but
he basically had no money to build it. He
also confirmed that the 2006 planning
permission was renewed in January 2012. The
proposer of the debate, the Upper Bann MLA Stephen
Moutray, quoted an interesting letter
from 1976 showing that the Direct Rule
minister for roads back then had promised
that the whole road would be completed by
1981 (see link above)!
15 Jan 2012: In a question for Written
Answer in the Assembly last November,
the DRD Minister was asked for the current
status of this project. He said "the route
selection and preliminary design of the
Millennium Way scheme in Lurgan has been
completed. Planning approval has also been
obtained, with a view to advancing the
Vesting Order and completing the detailed
design". However he went on to hint
that he had no money to built it, and that
construction was unlikely in the near
future.
4 Jul 2011: There was an
article about this scheme in the Lurgan
Mail last month. A delegation from "Lurgan
Forward" met the new "Roads" Minister and urged
him to press ahead with Phase 2 of Millennium
Way, later describing their meeting as "very
positive". The delegation argued, correctly,
that the road cannot meet its full potential
until it is extended to Gilford Road. However
there is no indication in the article whether
the Minister intends to alter his current
policy, which is that there are no plans at
present to proceed with the scheme.
Interestingly, the article refers not just to
the extension to Gilford Road, but also a westwards
extension to William Street (the A76 towards the
M1) which has hitherto not been part of this
proposal. It is not clear whether this is just
speculation, a suggestion or an actual plan.
2 Oct 2008: According to a written
answer in the Assembly in September 2008,
the Regional Development Minister said that the
scheme would be "included among the schemes
considered for inclusion" in the
programme of works for the next ten years. This
doesn't really say anything new, and does not
commit to proceeding with the scheme, but does
confirm that the proposal is still "live".
9 Jul 2008:
According to a written
answer in the Assembly in June 2008, the
scheme has still not got the go-ahead, but the
DRD is exploring developer funding. The
minister's full statement was: "...the
recently published Investment Delivery Plan
for Roads over the next 10 years identifies
funds totalling £109 million specifically "….
to complete the Non Strategic Major Improvements
incorporating the schemes identified in the
Sub-Regional Transport Plan". While I would
confirm that the Malcolm Road to Gilford Road
extension of Millennium Way will be included
among the schemes considered for inclusion in
this particular programme of work, there are
many competing demands for these substantial,
but limited, resources and priorities have
still to be determined. For that reason
alternative funding options have not been
ruled out and at a recent meeting with
representatives of Lurgan Forward on 1 May
2008 I suggested that it would be helpful if
it explored the possibility of developer
contribution to this scheme."
|
