Status
|
Construction scheme
(completed) |
Contractor
|
Whitemountain
Quarries
Consulting Engineers: Taylor & Boyd
|
Where
|
To
construct a new 428 space bus-based
park-and-ride facility at M2 j5
Templepatrick and upgrade the existing
junction by adding a roundabout. |
Total
Length
|
n/a |
Dates
|
4 September 1975 - M2
junction 5 opens to traffic (as part of
j4 to j5 contract)
3 Mar 2014 -
Construction given
go-ahead by DRD Minister
4 Apr 2014 - Scheme put out to tender
Circa Sep 2014 - Site works seem to have
begun
26 Feb 2015 - Contract
award published
1 Sep 2015 - Site
opened to the public
(changed from "Late Spring 2015" as
of Jan 2015)
|
Cost
|
£3.8m for whole scheme
Being taken forward by Translink but
funded by Department for Regional
Development
|
Maps/Photos
|
See below |
See
Also
|
General
area map - Google Maps
Official
web site on scheme - Translink
|
This is the point where the M2 motorway meets
the A57, a major road connecting Larne (via the
A8) to Belfast International Airport and which
meets the commuter towns of Templepatrick and
Ballyclare on its way. The point where it
crosses the M2 is a major interchange for
traffic. This is the point where traffic heading
from Derry to Larne diverges from the M2. It's
also the point where airport traffic from
Belfast leaves the M2. And lots of commuter
traffic joins the M2 here too.
When the M2 opened here in 1975 it was quieter
than it is now (you can see a picture of how it
looked on
this page - second image down). Hence it
was felt that a partial cloverleaf design was
sufficient, where two pairs of looped sliproads
meet the main road at a pair of priority
T-junctions. There are only two of these in
Northern Ireland (the other being M1 junction 13
at Verner's Corner). To improve safety between
these two T-junctions a short length of
dual-carriageway was built on the A57 as it
passes through (the A57 otherwise being a
single-carriageway). As traffic levels increased
over the years, the turning movements became
more common and during 2013/14 a 50mph speed
limit was applied to improve safety.
Bear with me as we turn our attention to the
park-and-ride. There has been talk of a
park-and-ride site on the M2 at junction 5
(known locally as Ballymartin) for many years
partly because of its proximity to the M2 where
it would attract a lot of commuters going into
Belfast, but also because of its proximity to
the main Belfast-Londonderry railway line. In
the end the site was approved for construction
in 2014 but as a bus-based park-and-ride
facility, with no rail halt to be built,
presumably for cost and/or operational reasons.
However the design of the site does seem to set
aside a strip of land adjacent to the railway
line which may be intended to keep the
possibility of a railway halt open for a future
date.
The site chosen is to the east of the existing
junction. The access road will join the A57 at the
same point as the southbound sliproads join. So
the easternmost T-junction is to be replaced by a
four arm roundabout. This is essential to make
site access safe, but it also acts to improve the
safety and ease-of-use of the existing junction
and helps to reduce vehicle speeds further, which
will improve the safety of the remaining

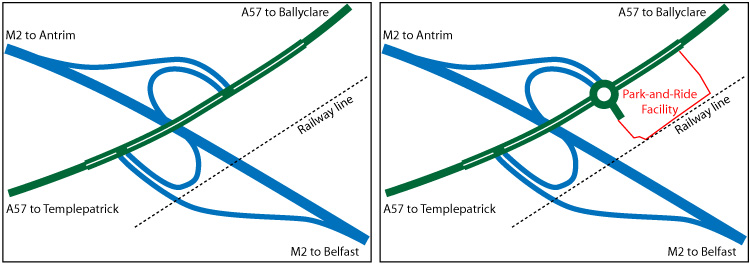

T-junction on the west side. The map below shows
the appearance of the junction before (left) and
after the upgrade (right):
The construction of a
park-and-ride facility adjacent to a main
railway line leading into the city, but
without a railway station, is surely one of
the strangest infrastructure decisions in
Northern Ireland currently. However Translink
has promised a fast and frequent bus service
into Belfast from the site and predicts that
it will be popular. It will also have a secure
fence and CCTV cameras. You can see a more
detailed map of the proposed facility here.
Progress
14 Sep 2015: Well, Ballymartin
Park-and-Ride opened
to the public as anticipated on 1
September, the car boot sale on 29 August
apparently being a success.
Full details are now available on the Translink
web site (although this being a roads
site, I feel compelled to comment that their map
shows the OLD layout of the junction, not the
upgraded junction featuring the roundabout). I
have now marked the scheme as completed - a good
job by the contractor, Whitemountain Quarries.
18 Aug 2015: According to a Translink press
release, Ballymartin Park-and-Ride will
open to travelers on 1 September. This will be
preceded by a charity car boot sale on Saturday
29 August, an event presumably designed to raise
awareness of the site as well as benefit the
charity involved. Translink have also published
the timetables
for the service, which will allow drivers to
park at the site all day and continue into the
city centre by bus, which looks to me to be
served as early as 6.45am on week days.
8 May 2015: I visited the scheme today,
and there has been excellent progress. I took a
few photos, after which a contractor approached
me to politely inquire as to my purposes! He
went on to explain a bit about what they were
doing. Not only are they building the
park-and-ride and associated roundabout, but
also closing up right turns onto the
countrybound onslip, ie when coming from
Templepatrick on the A57 you are no longer able
to turn right onto the countrybound M2. Instead,
vehicles must continue to the roundabout and
carry out a u-turn. This plus the roundabout
will eliminate 3 of the 4 right turn movements
at this junction, significantly reducing the
potential for crashes. I noticed too that there
will be a free-flow "jet lane" bypassing the
roundabout for vehicles turning left from the
eastbound A57 onto the citybound M2 onslip. The
signage at the site is suggesting opening of the
park-and-ride in "summer" 2015, rather than late
spring as was being said in January (see
previous update). Since I created this page a
couple of railway folks have been in touch to
explain that the lack of a railway halt is
because the line here is single-track and a
station would result in stationary trains which
would significantly disrupt rail services
between Belfast and the north/west. So there
would have to be an upgrade of the line before a
station could be considered.

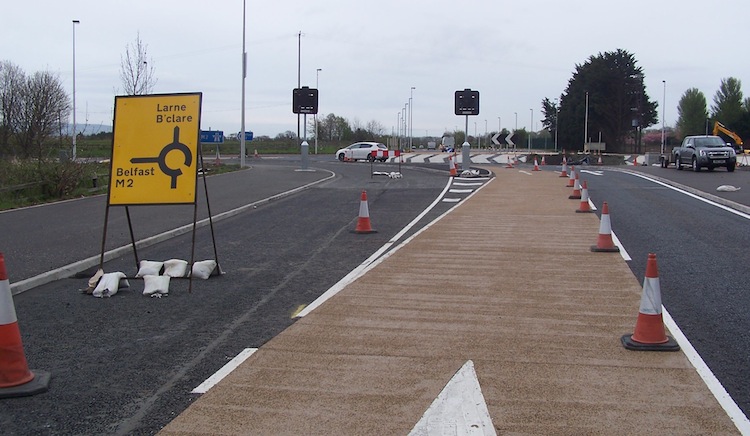

Pic 1: Signage at the site on 8 May 2015
advertising the park-and-ride in advance, and
giving a completion date of Summer 2015. [Wesley
Johnston]

Pic 2: View north-west across the new roundabout
on 8 May 2015, looking towards the citybound
onslip. The roundabout island is largely
completed, but there is still some kerbing and
surfacing work evident around it. [Wesley
Johnston]

Pic 3: Same location as the previous shot but
turning 90° to the right. This is the entrance
to the new park-and-ride itself. In the distance
you can see the car park with its surface down
and posts for lighting in place. 8 May 2015.
[Wesley Johnston]
Pic 4: Looking north-east along the A57 towards
the new roundabout on 8 May 2015. Although not
yet open, there is a free-flow "jet lane" for
left turning vehicles to bypass the roundabout.
The two square signs are presumably to display
messages such as lane closures if there is
maintenance on the motorway. [Wesley Johnston]

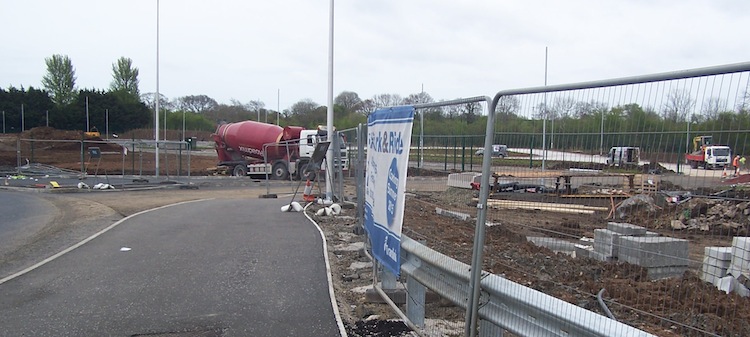

Pic 5: View south from the bridge over the M2
and looking towards the entrance to the
countrybound onslip on 8 May 2015. Right turns
into this onslip are now banned by expanding the
central reservation, although right turns out of
the offslip (what the bus is on) will still be
possible. [Wesley Johnston]
8 Mar 2015: Work seems to have begun on
site by or before September 2014 although the
award of the construction tender seems to have
only just been published.
The Minister visited
the site at the end of January. The press
release says that "To date, the project team
have successfully installed temporary traffic
management arrangements, completed 80% of site
drainage, formed water retention ponds,
installed car park ‘sub bases’, constructed
50% of the new roundabout and continue to make
significant progress on site fencing, main
carriageway widening and new bus access road
construction." The press release goes on
to say that the scheme is due for completion in
"late spring", which I guess means around May.
|
