A8 dualling - Coleman's Corner to Larne UPDATES ARCHIVE
This is a sub-page of the main A8 dualling scheme page. It holds project updates from the planning stages back in 2007 right through to January 2014, when the project was roughly half way finished.

Progress

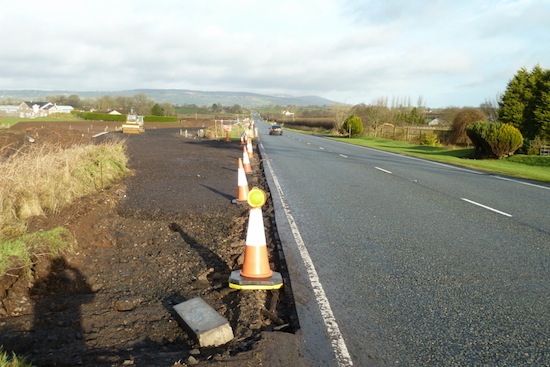

28 Jan 2014: Despite the dark, wet winter days the scheme continues to make progress. From the point of view of motorists, the most visible change is the addition of the final bridge beams at the Moss Road flyover which took place about ten days ago. That means that all three of the flyovers OVER the A8 now have their beams in place. However, work continues to take place all along the A8. The contractor Lagan Ferrovial Costain has published the third issue of their informative A8 newsletter, available here which details some of the work that has happened. The front cover has a lovely shot of the beams being lifted into place at the flyover that will carry the A57 Templepatrick Road over the future dual-carriageway near Ballynure. The newsletter says that the major culverting works are now completed, and attention has turned to removing the old culverts. Rock extraction work has continued through the winter, and the first kerbs and road surfacing have been laid. The article confirms that only one major bridge has not yet begun - it's the bridge that needs to be built to carry a sliproad UNDER the existing A8 at Ballybracken Road, just north of Ballynure. This will presumably require all traffic to be diverted off to one side, and work will commence here in February. The scheme still seems to be on schedule for completion in March 2015. Meanwhile, in the Assembly the DRD Minister has confirmed that an EU grant of €18m (£15m) has been gained for the project, covering a bit more than 10% of the total cost. We already knew this, but the Minister added that it will be paid in three parts - £4m in Dec 2013 just passed, a second installment in the 2014/15 financial year and the balance upon completion. Anyway - time for the pics! The pictures below were, with one exception, all taken by Noel O'Rawe on 19 January, but it's taken me a few days to get them up. They're arranged in order from south to north (the Larne end). Remember, if you want see detailed design drawings you can download the full set of plans here [11MB].

Pic 1: The view along the future A8 from Coleman's Corner on 19 Jan 2014. Not much has changed since last month, but it looks as if it would not take much work to open this short stretch that bypasses Bruslee. [Noel O'Rawe]

Pic 2: View south along the future A8 "Bruslee bypass" stretch on 19 Jan 2014, clearly showing the progressive layer structure that makes up the final road surface. On the right is part of a future layby. [Noel O'Rawe]

Pic 3: View of the A8, running left-right ahead, from Drumadowney Road. This road was previously a standard T-junction, but in keeping with the policy of banning right turns on the new road, it has been converted to left in/left out only by the large triangular traffic island ahead. The road is currently closed. Seen on 19 Jan 2014. [Noel O'Rawe]

Pic 4: View north along the A8 through the Calhame Road/Green Road flyover. The current A8 is on the right. On the left is the future northbound carriageway. You can see how it's being dug down into the hill. This is to provide better sight ahead, and hence reduce the risk of collisions. Lowering the crest of the hill like this is part of a concept called "vertical geometry". 19 Jan 2014. [Noel O'Rawe]

Pic 5: The bridge that will carry the A57 over the future dual-carriageway near Ballynure now appears to have its bridge deck and part of its parapets on 19 Jan 2014. This will the first bridge to open to traffic, after which the existing A57 on the left will be removed to make way for a major cutting. [Noel O'Rawe]

Pic 6: 19 Jan 2014. The view along Church Road near Ballynure, which is currently closed, as the abutments for the flyover that will carry the A8 over it are built. This is the same view before work began. The concrete ramp on the left appears to be a temporary works access route for construction machinery as it crosses the Ballynure Water (behind the white canvas barriers). [Noel O'Rawe]

Pic 7: As the A8 Ballynure Bypass crests the hill behind the village it descends into this enormous cutting, here seen on 19 Jan 2014 from Lismenary Road. The pillars for the bridge that will carry the Lismenary Road are slowly taking shape. [Noel O'Rawe]

Pic 8: The Moss Road flyover sporting all its bridge beams on 19 Jan 2014. Hurrah! You can see how the future northbound carriageway on the left is being built up to achieve the necessary "vertical geometry", ie to smooth out the undulations. [Noel O'Rawe]

Pic 9: This picture of Moss Road flyover was taken on 22 Dec 2013, before the second beams were lifted into place. It shows just how much higher the future road surface will be compared to the existing surface, perhaps 3 metres. It's entirely possible that the existing road here will be simply buried, providing an interesting discovery for future archaeologists. [Noel O'Rawe]

Pic 10: View south east along Moss Road on 19 Jan 2014, with the Moss Road flyover in the distance. The part of Moss Road on the right will become a cul-de-sac, accessed from the little link over the culvert seen here, from the new route of Moss Road, seen taking shape on the left here. The approach ramps for the bridge are also underway in the distance. Note the striking red colour of the rock here - perhaps this reflects the local geology, but I'm not a geologist so can't say! [Noel O'Rawe]

Pic 11: Between Moss Road and Deerpark Road an existing cutting has been widened to accommodate the new road. Here we see the future northbound carriageway (left) sitting neatly beside the existing A8 (right) on 19 Jan 2014. [Noel O'Rawe]

Pic 12: Looking north towards Deerpark Road flyober (visible in the distance) on 19 Jan 2014. The existing A8 makes a sharp left turn here that's too sharp for the high design standards of the new road, so it swings off to the right in order to take the turn more gently. The bit of road taking shape here is the entire dual-carriageway as it swings off to the right to make this turn. It will then turn left roughly where the tanker lorry is parked and slot under the bridge. [Noel O'Rawe]

9 Dec 2013: The scheme is now at approximately the half way point, with completion due in Spring 2015. These 12 pictures were all taken yesterday (8 Dec) by Noel O'Rawe to whom we are indebted for braving the December cold to get these snaps. As far as I can see, no more bridge beams have been put in place, although the Moss Road flyover looks as if it is quite close to being ready for this. The bridge deck at the A57 bridge is also nearing completion and will presumably soon get a parapet and then a road surface. Work in other areas is continuing. The short stretch of road that bypasses the settlement of Bruslee, from Coleman's Corner roundabout to roughly Glen Road, has now been mostly surfaced and looks as if it will be ready to carry traffic soon. It is possible that traffic will be switched onto one carriageway of this part (probably the future southbound carriageway) before too long in order to complete the tie-in to the existing road network. The pictures below are arranged in order from south to north. Because the site can be a bit of a desolate wilderness, with mud everywhere, it can be hard to make sense of some of the images. In these cases I've included a snippet map to try to make it clearer what we're looking at. If you want see more design maps you can download the full set of plans here [11MB]. Enjoy!

Pic 1: Looking north east from Coleman's Corner roundabout on 8 Dec 2013, with the existing road on the left and the new road that swings out past Bruslee on the right. Work seems to be underway to tie the two together. Same view before work began. [Noel O'Rawe]

Pic 2: Moving a couple of dozen metres forward to get a closer look at the stretch bypassing Bruslee, we can see that the final road surface is being laid here. Traffic may soon be diverted onto this very advanced section. 8 Dec 2013 [Noel O'Rawe]

Pic 3: This is the point where the section bypassing Bruslee rejoins the existing A8 (on the right). We've turned round and are looking back towards Belfast here. A new layby is evident taking shape just ahead. Same view before work began. 8 Dec 2013 [Noel O'Rawe]

Pic 4: The view south west (towards Belfast) from Calhame Road on 8 Dec 2013 showing progress on the future northbound carriageway well advanced on the right. In the distance is where the road swings away round Bruslee, the location shown in the Pic 3 above. Approximately the same view before work began. [Noel O'Rawe]

Pic 5: A view of the Green Road/Calhame Road grade separated junction taking shape on 8 Dec 2013, with an inset map showing the location of the camera as a red arrow. The road ahead is the future link road that will connect Calhame Road (where the photographer is standing) up onto the flyover, which is visible ahead. Same view before work began. [Noel O'Rawe]

Pic 6: The bridge that will carry the A57 Templepatrick Road over the new dual-carriageway had a complete bridge deck on 8 Dec 2013. Work on the parapets must surely come next, along with the approach embankments. Same view before work began. [Noel O'Rawe]

Pic 7: At Church Road, on the Ballynure Bypass stretch, work was continuing to build the northern bridge pillars for the future flyover on 8 Dec 2013. Church Road here still appears to be shut, and will presumably remain so until the bridge beams are in place. The small bridge visible ahead is the new bridge that will carry Church Road over the river. This is the location of these structures. [Noel O'Rawe]

Pic 8: At Ballybracken Road, where the local road network is being sunk below ground level to facilitate an underpass, the enormous excavation that was made in the summer was partly full of water on 8 Dec 2013 with not much work evident. The inset shows the location of the photographer as a blue arrow. Same view before work began. [Noel O'Rawe]

Pic 9: Moss Road flyover taking shape on 8 Dec 2013, in this view looking north east from Ballygowan Road. This is likely to be the next bridge to get its beams. Note how rock is being used to fill in the undulating topography so that the new road will be much smoother than the existing one. [Noel O'Rawe]

Pic 10: Ballygowan Road currently joins the existing A8 (where the lorry is) at a T-junction. It will be stopped up eventually, as shown in the inset map. In this shot, taken on 8 Dec 2013, the new turning circle can be seen taking shape as well as a new private access road to provide alternative access to property that will no longer be permitted to open directly onto the A8. [Noel O'Rawe]

Pic 11: Another view of the Moss Road flyover, this time taken from Moss Road (see inset map for location) on 8 Dec 2013. It shows the future route of the diverted Moss Road where the digger is, with two roads running to the left. One is for a private exit, and the second is the approach road that will lead up onto the flyover. Same view before work began. [Noel O'Rawe]

Pic 12: An unusual perspective on the Deerpark Road flyover, looking south east from Deerpark Road itself on 8 Dec 2013. This bridge already has its beams ans is now getting its road deck on top. Same view before work began. [Noel O'Rawe]

5 Nov 2013: This update contains more photographs, this time taken on 3 November by Noel O'Rawe (thanks!). The scheme continues to make good progress. According to the contractor's own web site, the summer saw a lot of soft excavation work (eg removal of topsoil) which is now complete in most areas, and stabilisation of soft ground, especially at the future Green Road/Calhame Road junction. The contractor is attempting to re-use excavated rock on other parts of the project. To date, the source of much of the rock already used for embankments, etc, has been the cutting south of the A57 Templepatrick Road near Ballynure. During the winter the contractor will be extracting more rock from the cutting that is needed in the Ballynure Bypass stretch, in some cases by blasting. This additional rock will also be used to manufacture the road base. Three overbridges now have their beams in place - the A57 Templepatrick Road bridge, and the flyovers at Deerpark Road and Green Road/Calhame Road. On the southernmost stretch the kerbs for the actual carriageway are now going in, making this section the most advanced on the scheme. The pictures below are arranged in order from south to north.

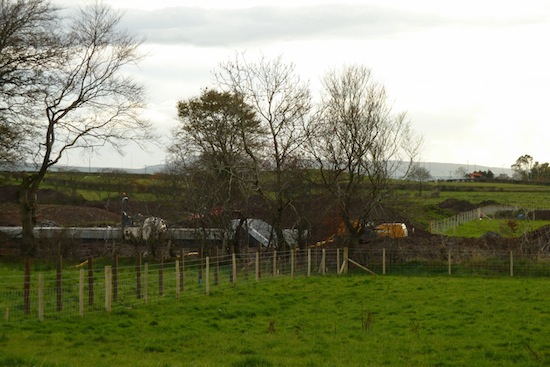

Pic 1: View north from Coleman's Corner on 3 Nov 2013. This is where the A8 swings east to bypass the settlement of Bruslee. Work on the road itself is now underway in the form of kerb lines. [Noel O'Rawe]

Pic 2: Telephoto shot north along the existing A8 on 3 Nov 2013, from near Glen Road and looking towards the partially build flyover at the future Green Road/Calhame Road grade separated junction. Drainage is being installed on the future northbound carriageway on the left, while the old road remains in situ, for now, on the right. [Noel O'Rawe]

Pic 3: View east along the existing line of Green Road (right) and its future route up onto the flyover (left). The road on the right will be retained as a cul-de-sac for access to local properties. The fencing surrounds a diverted watercourse. Between the watercourse and the flyover, but not obvious in this shot, is a flood constriction pond, designed to prevent the overloading of drainage channels during heavy rain storms by storing water and releasing it gradually. 3 Nov 2013. [Noel O'Rawe]

Pic 4: The view south along the A8 towards the flyover for the future Green Road/Calhame Road grade separated junction, which has recently had its beams put into place. 3 Nov 2013. [Noel O'Rawe]

Pic 5: Closeup of the 3 Nov 2013 flyover for the future Green Road/Calhame Road grade separated junction, which has recently had its beams put into place. [Noel O'Rawe]

Pic 6: The flyover that will carry the A57 Templepatrick Road over the new dual-carriageway continues to take shape with the road deck being constructed as seen on 3 Nov 2013. Once completed the A57, where the photographer is standing, will be diverted onto it so that the rest of the cutting can be excavated. [Noel O'Rawe]

Pic 7: At Church Road, on the Ballynure Bypass stretch, the Ballynure Water diversion is complete, the new local bridge in place over it, and the old stone bridge now demolished. Work is now underway on the southern bridge abutment (right) which, together with the one on the left, will allow a flyover to take the new road over the whole lot. 3 Nov 2013. [Noel O'Rawe]

Pic 8: Further along the Ballynure Bypass stretch the road enters a long cutting. This cutting is crossed by Lismenary Road which will be carried on a new flyover, the foundations of which are seen here. The picture is taken from the existing Lismenary Road which runs parallel to the left of the shot. Work this coming winter will focus on excavating the rest of this enormous cutting. 3 Nov 2013. [Noel O'Rawe]

Pic 9: The view north east towards the flyover for the future Moss Road grade separated junction, which had yet to get its beams on 3 Nov 2013. The future road will be a couple of metres higher than the existing road, hence the huge pile of rock on the left where the future northbound carriageway will be. This has been piled literally on top of the tarmac of part of the existing road, creating an interesting artifact for future archaeologists! [Noel O'Rawe]

Pic 10: The view south from the same location as the previous shot at Moss Road, showing how the new road will be built up to a higher level. Eventually the existing road on the left will be similarly built up. 3 Nov 2013. [Noel O'Rawe]

Pic 11: View north along the A8 towards the Deerpark Road flyover on 3 Nov 2013. This will eventually form part of another grade separated junction. [Noel O'Rawe]

Pic 12: Closeup of the underside of the Deerpark Road flyover on 3 Nov 2013, showing that the bridge deck is taking shape above the enormous beams. The platforms on the left and right are presumably temporary structures for workers. [Noel O'Rawe]

28 Oct 2013: This is just a quick update to let you know that the contractor has released their latest newsletter, this one dating from September. It includes some fabulous aerial photography while also containing very interesting updates on what is going on. Notably, it suggests that work will be completed in March 2015, not June as I had calculated based on a 34 month contract. The newsletter confirms that, as suspected, the excellent weather this summer has allowed work to progress rapidly, with 50% of earthworks now completed, with enough material moved so far to fill half of Wembley Stadium! The newsletter confirms that, as shown in the September photos (below), drainage works have now commenced at the south end of the scheme while this winter will see some rock blasting in some cuttings, and the first kerbs being placed in other locations. There's lots more info in the newsletter, so give it a browse. I should also comment that this is pretty much the highest quality information that has been given out to the public by a contractor on any scheme I have followed over the past decade, so thank you to them.

24 Sep 2013: This update is to bring you another set of images, taken on Sunday 22 September by Noel O'Rawe (with thanks as always). The most obvious change from the perspective of the observer is the addition of the bridge beams at the A57 bridge near Ballynure. It seems likely that beams will be added to the Deerpark Road bridge within the next week as well, which would make two. From the contractor's point of view, the past month seems to have been a combination of earthworks, especially the enormous cutting on the Ballynure Bypass stretch, but also embankments and bridge approaches. Work has also been progressing on structures, with more work on various bridges and culverts – the Larne River has now been diverted into its new culvert. Work has also advanced on the road base in some locations, with drains now in place on some stretches, along both what will be the central reservation and the sides of the future road. The photos are arranged in order starting at the Belfast end of the scheme and heading towards Larne.

Pic 1: The view north east from the Coleman's Corner roundabout at the south end of the scheme, showing the foundations of the new road taking shape, with drains going in. This part of the route is offline to bypass the settlement of Bruslee. 22 Sep 2013 [Noel O'Rawe]

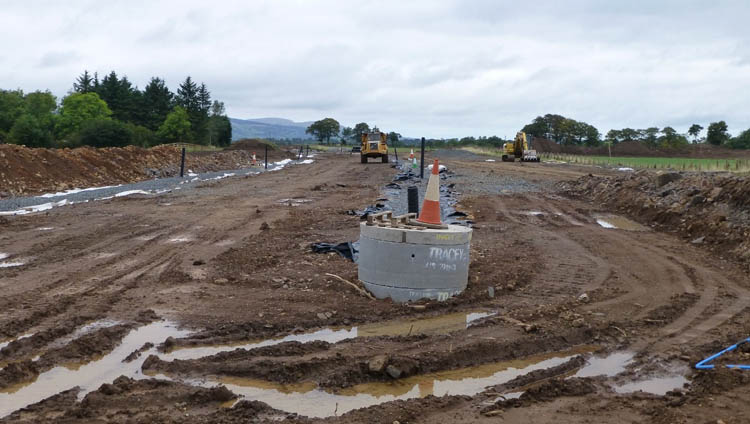

Pic 2: The view north east from Lisglass Road on 22 Sep 2013 along what will be the central reservation, again showing drains in place. This is the same view before work began. [Noel O'Rawe]

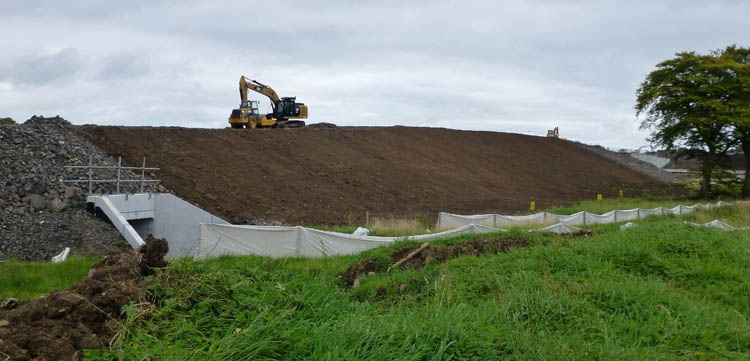

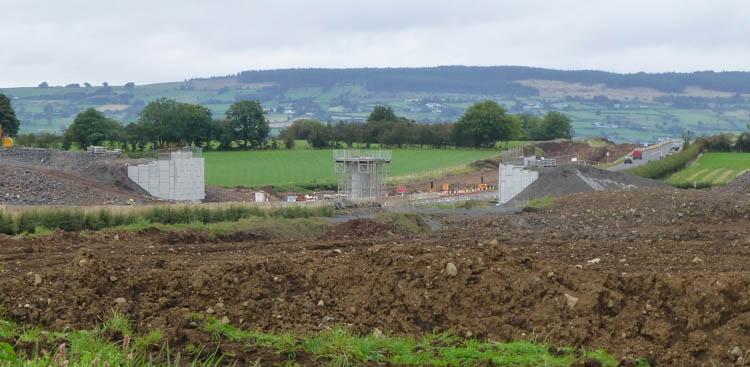

Pic 3: Part of the embankment for the Green Road/Calhame Road grade separated junction looking well advanced on 22 Sep 2013, here seen looking south east from Green Road with the existing A8 in the right distance. [Noel O'Rawe]

Pic 4: The flyover component of the Green Road/Calhame Road grade separated junction, seen looking north east from Calhame Road on 22 Sep 2013 [Noel O'Rawe]

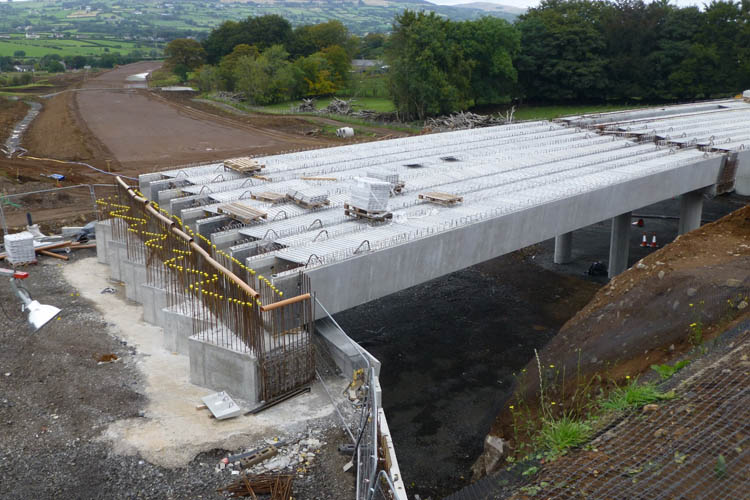

Pic 5: The A57 bridge taking shape with the bridge beams in place on 22 Sep 2013. They appear to be hollow (metal?) beams. In the background the formation of the Ballynure Bypass stretch is looking very neat with a diverted watercourse on the left. [Noel O'Rawe]

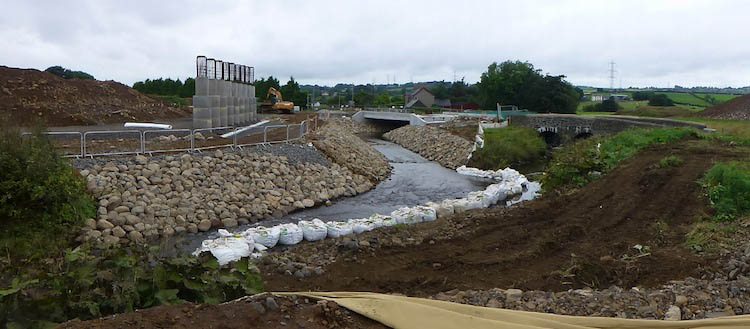

Pic 6: At Church Road, on the Ballynure Bypass stretch, the new bridge that carries Church Road over the Ballynure Water is completed and in use with the river diverted into it. The old bridge, on the right, will presumably the removed. The piers are for the flyover that will carry the future A8 over the whole lot on a flyover. Seen on 22 Sep 2013 [Noel O'Rawe]

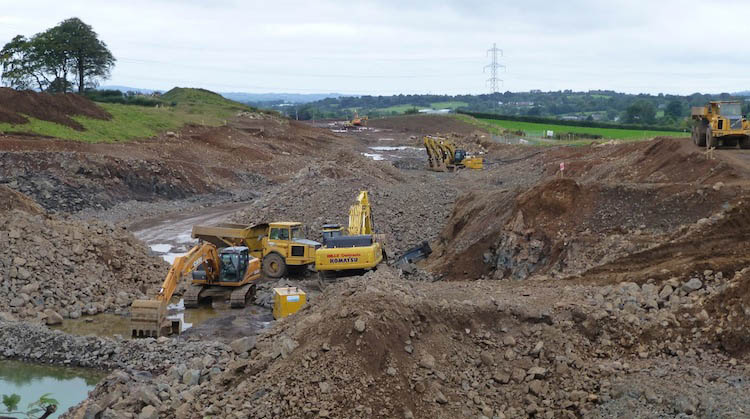

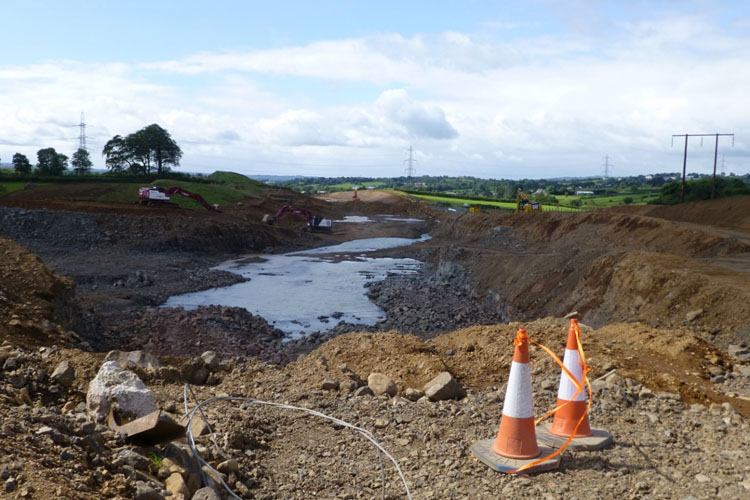

Pic 7: The view south west from Lismenary Road on 22 Sep 2013, where the vast cutting for this part of the Ballynure Bypass is still being excavated. This is a zoomed-in view of the same area shown in Pic 10 in the previous update. [Noel O'Rawe]

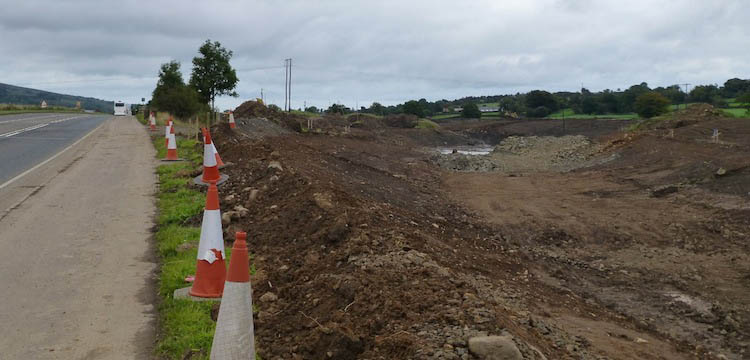

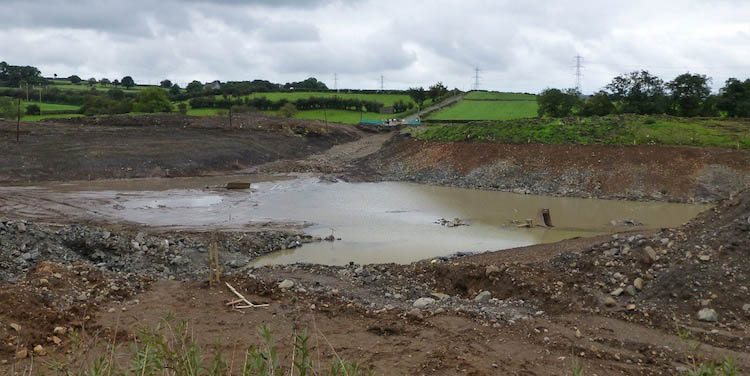

Pic 8: View north from the existing A8 near Ballybracken Road, just north of Ballynure. This is the point where the Ballynure Bypass stretch will rejoin the existing A8. The cutting on the right is for a road that will carry local traffic into Ballynure (behind the camera) after the new A8 is operational. 22 Sep 2013 [Noel O'Rawe]

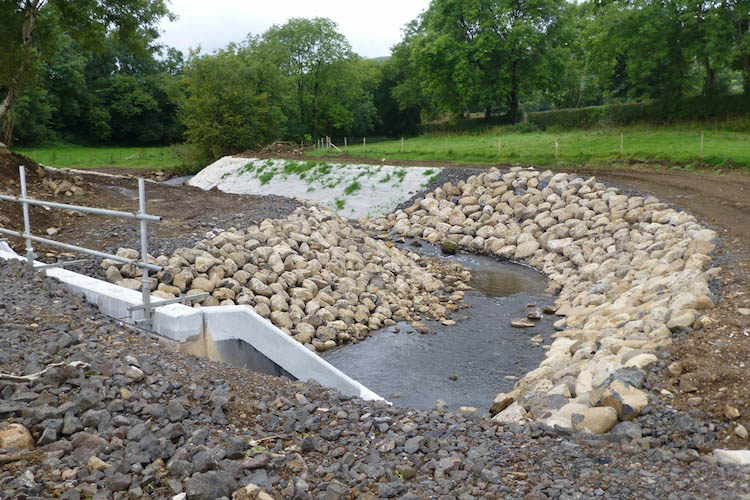

Pic 9: Another view of the completed cutting that will carry a range of local roads below ground level around the Ballybracken Road grade separated junction, seen on 22 Sep 2013. Excavation work appears to be completed although the hole has a lot of sitting water in it due to recent rainfall. [Noel O'Rawe]

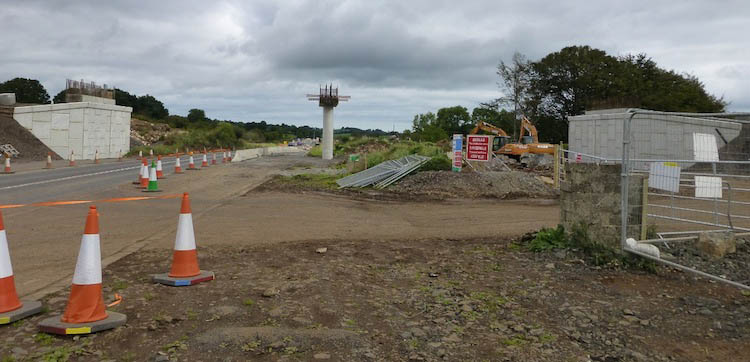

Pic 10: The future flyover for the Deerpark Road grade separated junction, close to the north end of the scheme, on 22 Sep 2013. This junction is likely to be the second one to get its bridge beams in the near future. [Noel O'Rawe]

Pic 11: The Larne River finally diverted into its carefully crafted new culvert on 22 Sep 2013. Compare to the view last month (Pic 13 in the 21 August update below) when the culvert was still under construction. The grass shows that even now nature has begun to reclaim this territory. [Noel O'Rawe]

4 Sep 2013: A very quick update to make you aware that the contractor, Lagan Ferrovial Costain, have launched a web site dedicated to the scheme at http://a8lfc.com. The site aims to provide updates on the progress of works, recent news, information on the contractors and also some photographs. I would draw your attention in particular to the downloadable scheme newsletter which dates from last Spring and is a very interesting read. The main page of the site contains some nice photographs of the works underway. These have the advantage of having been taken on the site itself, hence showing scenes inaccessible to the public, although they are of limited use since they're not dated or captioned, so we don't know what they are showing or when they were taken.

21 Aug 2013: The project has now been underway for just over a year, with just under two years yet to go. Until the summer most of the work seemed to focus on vegetation clearance, building low-level structures such as culverts and constructing bridge piers. In more recent months, however, many of these have been completed and instead there has been an increased focus on earthworks with both embankments and cuttings taking shape on a very impressive scale. One of the largest cuttings on the whole project is the offline section bypassing Ballynure, which is now well underway. The selection of pictures below were provided by our own Noel O'Rawe (thank you) who visited the site at the weekend and illustrates the progress that has been made. The past three months has seen exceptionally good weather so the contractor will likely have been able to take full advantage of the dry days and late sunshine to move things along. The photos are arranged in order starting at the Belfast end of the scheme and heading towards Larne. (Last month I increased the size of the pages on the site, so these pictures are at a new, larger size - enjoy).

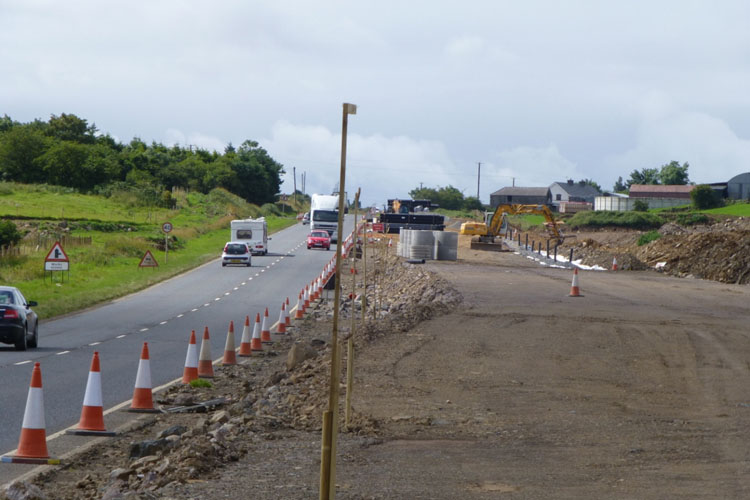

Pic 1: The view along the A8 from near Glen Road on 17 Aug 2013, showing the future northbound carriageway taking shape while the existing road runs on the right. On the left the drains are being installed. This is a similar view before work began. [Noel O'Rawe]

Pic 2: The view looking south at the site of the future Green Road/Calhame Road grade separated junction on 17 Aug 2013. The inset map shows where the picture was taken. You can see that the large, curved embankment taking shape ahead is the future northbound offslip and onslip, while the bridge piers are visible on the left. [Noel O'Rawe]

Pic 3: In the previous update (see below) work on the embankment to carry Legaloy Road up onto the new bridge had just begun, and as of 17 Aug 2013 seems to be well advanced. The inset map shows where the picture was taken. This little stub of road is now redundant and will presumably be removed and grassed over. [Noel O'Rawe]

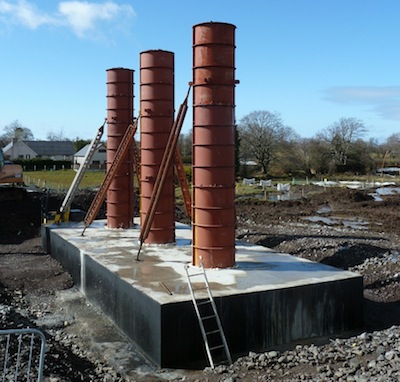

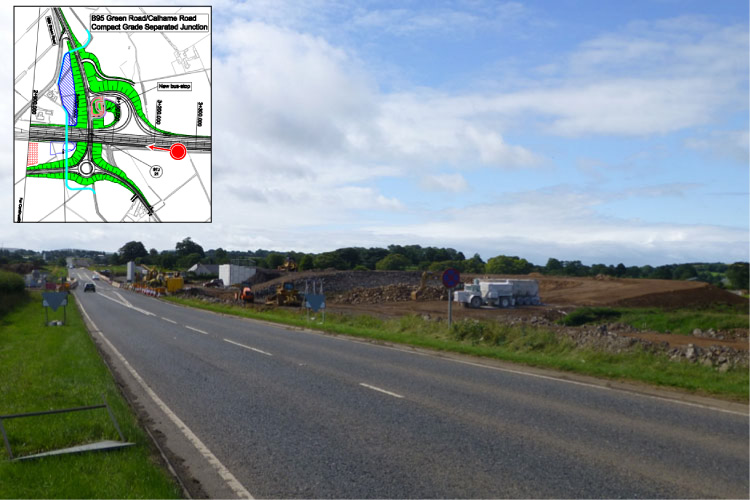

Pic 4: A final picture at the Green Road/Calhame Road grade separated junction, taken from the location marked on the inset map on 17 Aug 2013. The piers for the future flyover are taking shape ahead. Taken from the embankment that will carry Calhame Road up onto the bridge. [Noel O'Rawe]

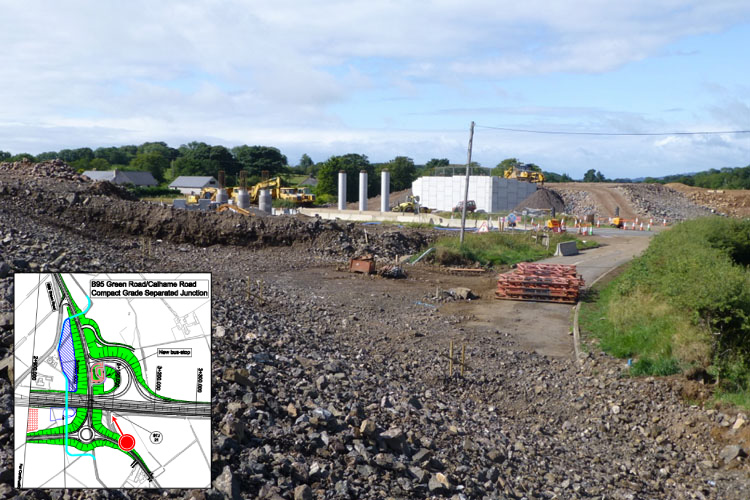

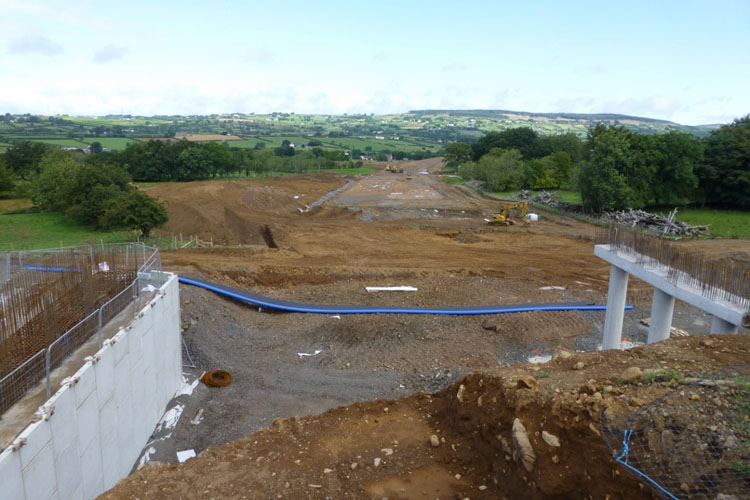

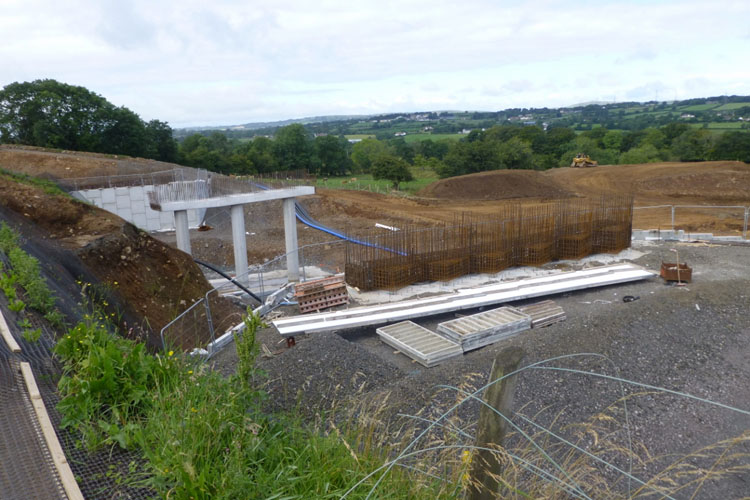

Pic 5: The future bridge that will carry the A57 over the new dual-carriageway still hadn't got its beams in place on 17 Aug 2013, but is nevertheless one of the most well-advanced bridges on the scheme. Once it has been finished, the A57 (which currently runs parallel to it, to the left here) will be diverted onto the bridge and a huge cutting excavated on the left. [Noel O'Rawe]

Pic 6: The view north from the A57 on 17 Aug 2013, with the Balllynure bypass section of the road progressing very well ahead. This is the same view before work began. Work on the huge cutting behind the camera has yet to get this advanced. [Noel O'Rawe]

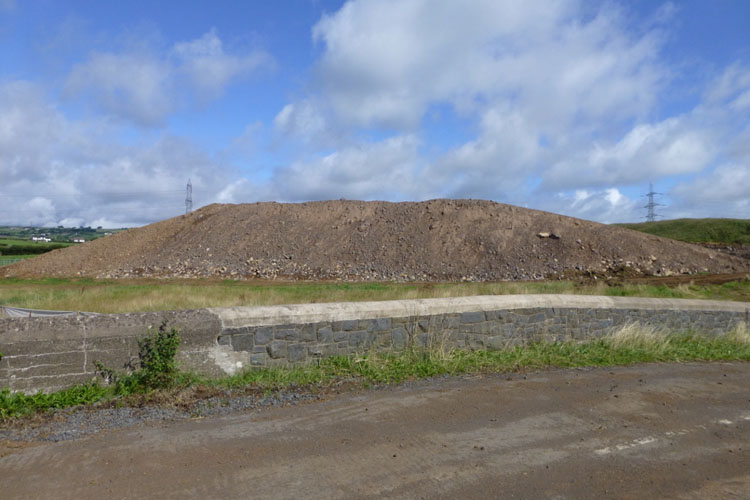

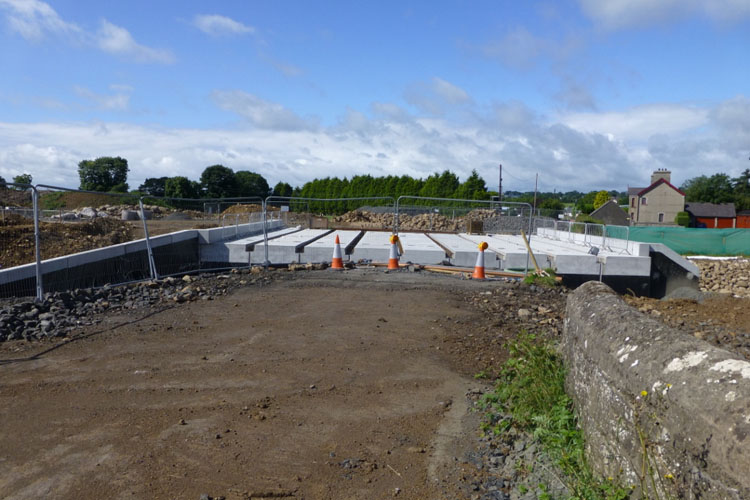

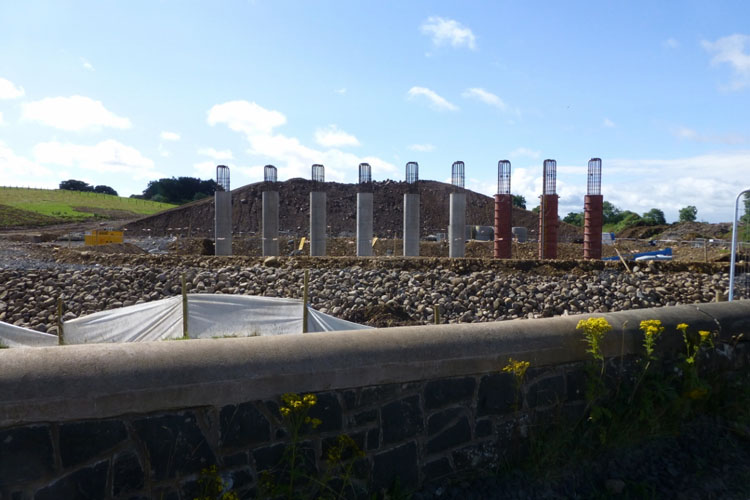

Pic 7: At Church Road there is to be a double bridge! Church Road crosses over the Ballynure Water river, while the new dual-carriageway will itself be bridged over this bridge on a flyover. The existing bridge is a narrow stone construction and is being replaced by this more modern edifice, here seen on 17 Aug 2013, which is a few metres west of the existing bridge. This is the same view before work began. [Noel O'Rawe]

Pic 8: Remaining at Church Road, where the previous picture was taken, these are the piers for the much larger flyover that will carry the future A8 over both Church Road and its new river bridge. This is a similar view before work began (the existing bridge parapet has been repaired in the interim). 17 Aug 2013. [Noel O'Rawe]

Pic 9: Still at Church Road, but turning around 180°, this is the embankment for the future A8 taking shape on the north side, as seen on 17 Aug 2013. This is the same view before work began. The existing bridge that the photographer is standing on will presumably be removed and the site buried under this embankment, since the river is being shifted west by a few metres. [Noel O'Rawe]

Pic 10: By the time the Ballynure bypass stretch of the new road reaches Lismenary Road it will have descended into a long cutting, one of the largest on the whole scheme. This view looking south west from Lismenary Road on 17 Aug 2013 shows work well underway to excavate this enormous feature. The scheme has been specially designed so that the majority of material removed from places like this can be re-used for embankments elsewhere on the scheme, thus minimising waste. This is the same view before work began. [Noel O'Rawe]

Pic 11: Ballybracken Road, just north of Ballynure, is where the Ballynure bypass section of the scheme rejoins the line of the existing A8. The souhbound offslip, northound onslip and a local road will all be accommodated in a network of cuttings (in red on the map). This view on 17 Aug 2013 shows the work underway, taken from the existing A8 at what will eventually be an overbridge. The inset map shows the location of the shot as a blue dot, indicating what the view encompasses. [Noel O'Rawe]

Pic 12: Looking south west from close to Moss Road on 17 Aug 2013, this is another section where the future northbound carriageway is taking shape beside the existing A8. This is the same view before work began. [Noel O'Rawe]

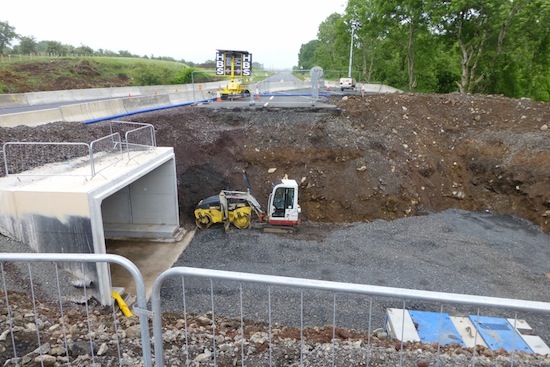

Pic 13: Our final shot is of the almost completed Larne River diversion, which has yet to have the river diverted into it, as seen on 17 Aug 2013. The attention to detail here is is very interesting - this is not simply a concrete channel, but a well-planned piece of eco-engineering designed to encourage the formation of a natural river environment once again. This is the same view before work began. [Noel O'Rawe]

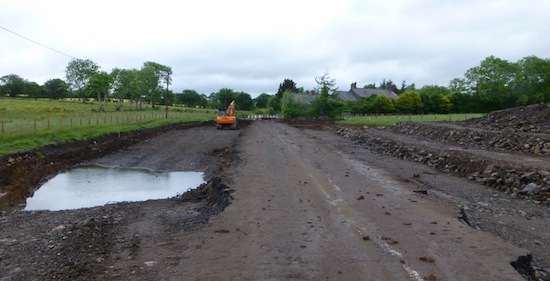

2 Jul 2013: Another update, this time taken on 23rd June by Noel O'Rawe (to whom we are indebted)! We can see that progress continues to be excellent over the past month. The pictures below are arranged in sequential order starting at the Belfast end of the scheme and heading towards Larne.

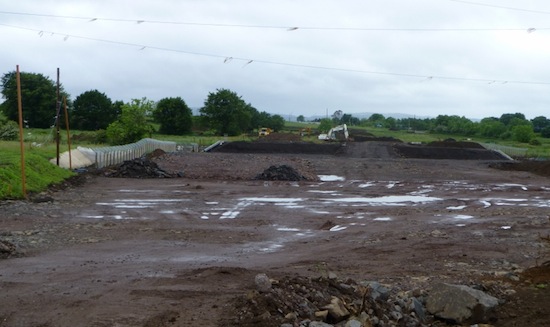

Pic 1: The view south-west from Lisglass Road, ie towards Corr's Corner. The road is being built offline here, and with the land now cleared the stone road base now seems to be going in. This is the same view before work began. 23 June 2013 [Noel O'Rawe]

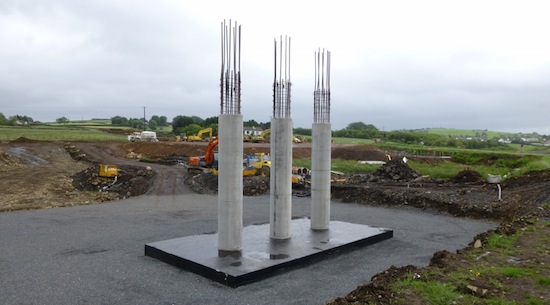

Pic 2: The view north along the A8 at the site of the future Green Road/Calhame Road grade separated junction. When compared to how the site looked two months ago, you can see that the western bridge abutment is now in place, as are the pillars that will be in the central reservation. Work on the eastern abutment seems to be underway on the right. 23 June 2013 [Noel O'Rawe]

Pic 3: A brand new flood constriction pond taking shape near Green Road. When finished this will collect runoff water from flood events so as not to overwhelm local watercourses. 23 June 2013 [Noel O'Rawe]

Pic 4: The view east from the existing A8 at the site of the future Green Road/Calhame Road grade separated junction. Two diverted watercourses are taking shape, while the gravel beyond will be the approach embankment to carry the road onto the flyover. This is the same view before work began. 23 June 2013 [Noel O'Rawe]

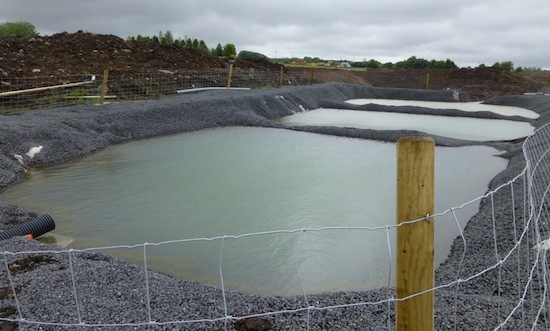

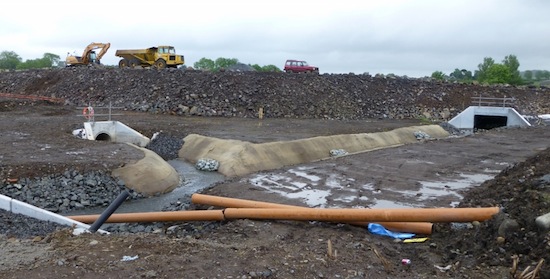

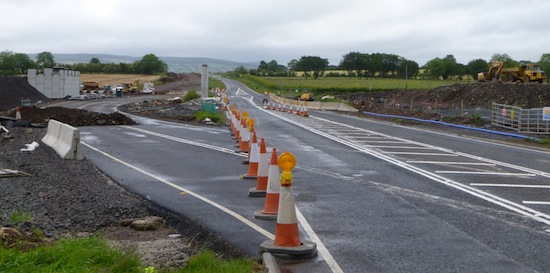

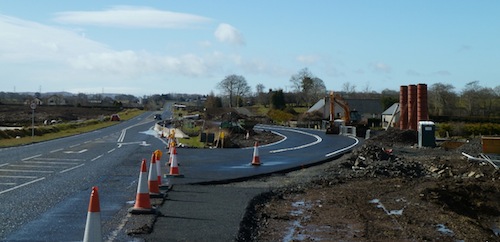

Pic 5: The "old" Legaloy Road being removed so that it can be diverted up onto an embankment (taking shape to the right) to lead it up onto the flyover. This bit of the road will be buried under the embankment when completed. This is the same view before work began. 23 June 2013 [Noel O'Rawe]

Pic 6: The pillars for the future flyover that will carry the A57 Templepatrick Road over the new dual-carriageway near Ballynure are completed and the abutment walls have been added, and the space behind them is now being in-filled. Presumably work will soon focus on putting the bridge beams in place so that the existing A57 (where the photographer is standing) can be diverted onto it to allow the huge cutting to be excavated for the future dual-carriageway. 23 June 2013 [Noel O'Rawe]

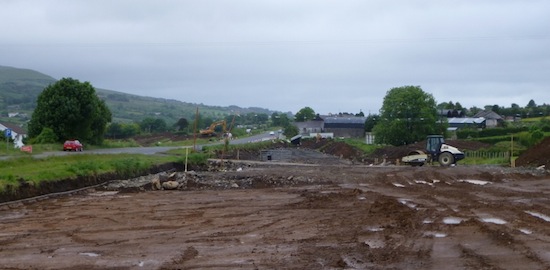

Pic 7: The view north-east from Ballybracken Road, just north of Ballynure. There will be a southbound offslip into Ballynure here, which will be built in a cutting to the right of this shot. The land just ahead is being cleared for the future dual-carriageway which swings slightly off the line of the existing A8 for a short distance here to achieve the necessary geometry. This is the same view before work began. 23 June 2013 [Noel O'Rawe]

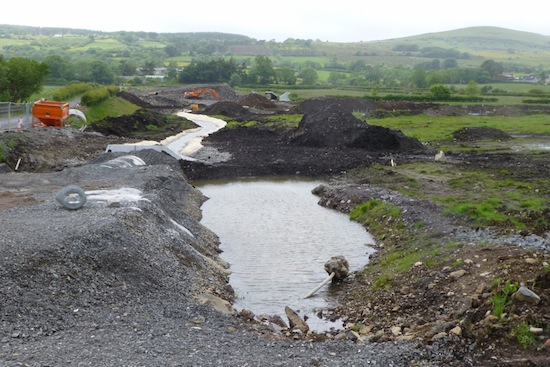

Pic 8: Looking north west from the existing A8 at Moss Road (visible on the left) a small river is being carefully realigned prior to work beginning on a series of embankments for the grade separated junction, which will eventually bury all the land visible on the right here. This is the same view before work began. 23 June 2013 [Noel O'Rawe]

Pic 9: At the same junction at Moss Road, these are the recently constructed pillars for the eastern end of the future Moss Road flyover. This is the same view before work began. 23 June 2013 [Noel O'Rawe]

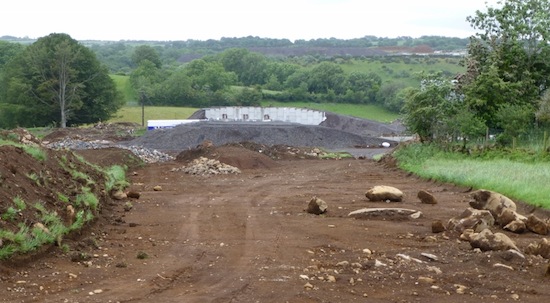

Pic 10: At Deerpark Road there will be another grade separated junction. This is the view south-east from Deerpark Road along what will be the new link road connecting it to the bridge, the embankments of which are taking shape ahead. This is the same view before work began. 23 June 2013 [Noel O'Rawe]

Pic 11: The view south near Park Road where the substantial culvert that will carry the diverted Larne River is progressing well. The eastern bit (on the left) is finished and work is well underway on the western bit. Once completed the Larne River, which currently runs about 50 metres ahead will be diverted through here. 23 June 2013 [Noel O'Rawe]

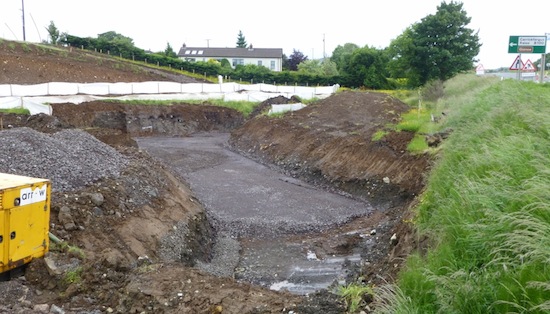

Pic 12: Finally, at the extreme north end of the scheme at Ballyrickard, the foundations for the future terminating roundabout are taking shape beside the existing road. The white screens are around a diverted watercourse. This is the view south. This is the same view before work began. 23 June 2013 [Noel O'Rawe]

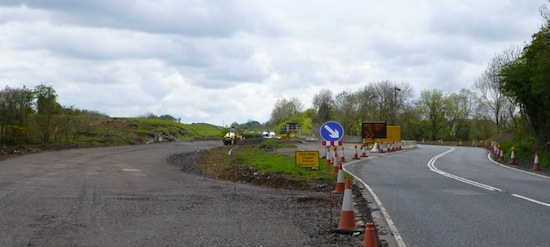

27 May 2013: More photos, all taken on 26th May by Noel O'Rawe. With work of some form having been underway now for 10 months, progress seems to be excellent as you can see, and some of the earthworks are now pretty impressive in their scale. The pictures are sequential starting at the Belfast end of the scheme and heading towards Larne.

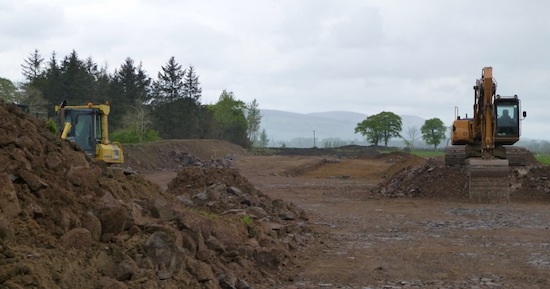

1. View north-east from Lisglass Road, 26 May 2013. At this point the dual-carriageway is being built off-line to bypass the settlement of Bruslee. Here the road base is taking shape. This is the same view before work began, and this is the same view in the early stages of work on 4 Nov 2012. Compare also to the same view in November last year. [Noel O'Rawe]

2. View east from the A8 from opposite Green Road, 26 May 2013. At this point there will be a huge embankment for the Green Road/Calhame Road grade separated junction, and beside the embankment is to be a flood contriction pond, designed to store floodwater and release it into local watercourses in a controlled manner. I'm not clear on what this huge water-filled hole is for, however, as its location doesn't seem to coincide with any of these structures. Perhaps it is being used as a source of fill for use elsewhere. This is the same view before work began. [Noel O'Rawe]

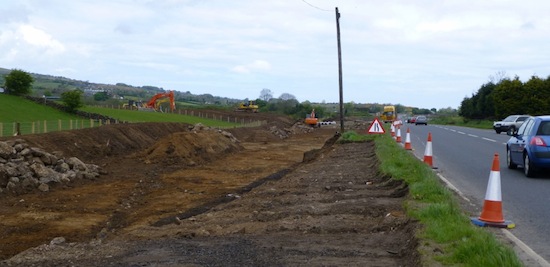

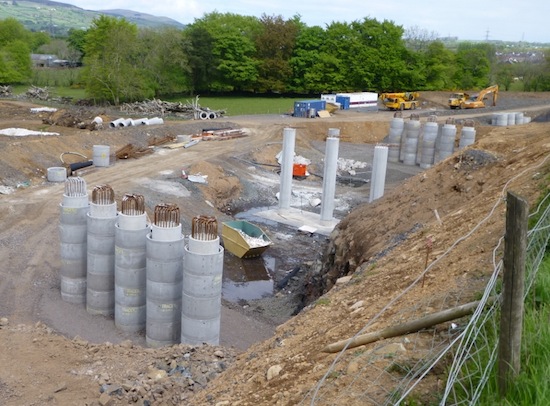

3. The pillars for the future flyover that will carry the A57 Templepatrick Road over the new dual-carriageway near Ballynure nearing completion, 26 May 2013. The photographer is standing on the existing A57, which will then be removed and a huge cutting excavated to make way for the new road. The bank here is extremely steep, so a temporary concrete barrier has been installed on the existing A57 to prevent vehicles plunging off this precipice. This is the same view before work began. The progress can be seen by comparing how it looked two months ago. [Noel O'Rawe]

4. At Ballygowan Road, the new dual-carriageway is being constructed by widening the existing road, here seen on 26 May 2013. This is the view north, towards Larne with the current road on the right, which will later be rebuilt to become the southbound carriageway, while the northbound carriageway will be built on the left. This is the same view before work began. [Noel O'Rawe]

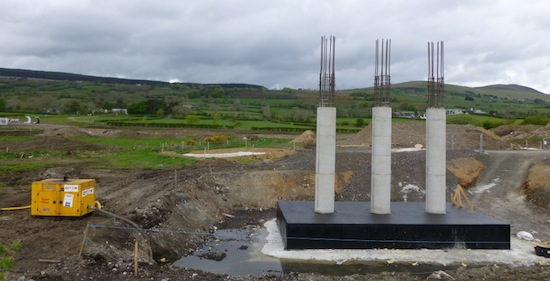

5. At Moss Road there will be a new grade-separated junction facilitated by a flyover, of which this is the western end, 26 May 2013. The land beyond will later be buried by the approach embankment, so all the vegetation has been removed. This is the same view before work began. [Noel O'Rawe]

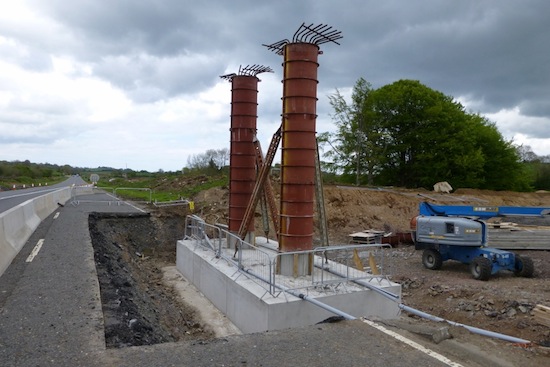

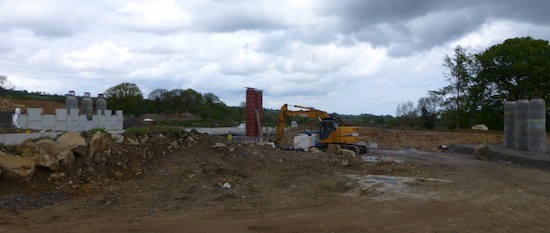

6. Similarly, there will be a large grade-separated junction at Deerpark Road, with another flyover. These pillars, seen looking north towards Larne on 26 May 2013, will eventually be in the central reservation of the future dual-carriageway. This is the same view before work began. [Noel O'Rawe]

7. Another view looking north towards the site of the future Deerpark Road flyover shows the western, central and eastern bridge pillars, 26 May 2013. The one on the left is now getting the cladding which will support the embankment that will be created behind it. The existing A8 runs on the left, but the photographer is standing on what will be the southbound carriageway. [Noel O'Rawe]

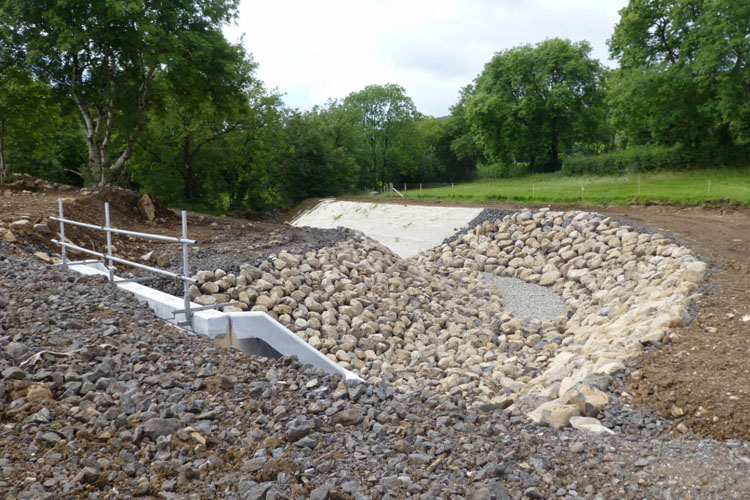

8. Finally, work continues at Park Road to divert the Larne River. This view looking south on 26 May 2013 shows a new chicane being created on the left, over the bit of the culvert that has now been completed, presumably to allow the second half to be constructed. The view is almost unrecognisable from what it was before work began. [Noel O'Rawe]

24 Apr 2013: The photos in this update were taken between 1 and 2 weeks ago by Noel O'Rawe. As you can see, columns have now appeared at the site of the future Green Road/Calhame Road grade-separated junction. The main focus of work still seems to be the construction of culverts and the diversion of watercourses etc.

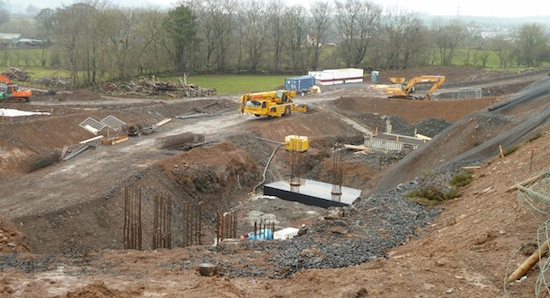

Pic 1: View south-west at the site of the future Green Road/Calhame Road grade-separated junction. On the right are three columns that will form the western end of the future flyover. Taken 14 Apr 2013 [Noel O'Rawe]

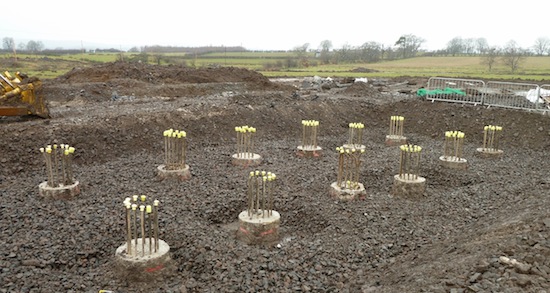

Pic 2: A close-up of the three columns that are now taking shape at the western end of the future flyover at the site of the future Green Road/Calhame Road grade-separated junction. Taken 14 Apr 2013 [Noel O'Rawe]

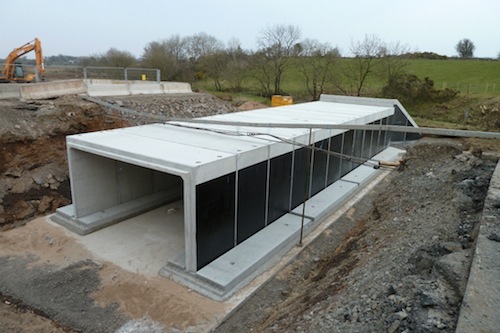

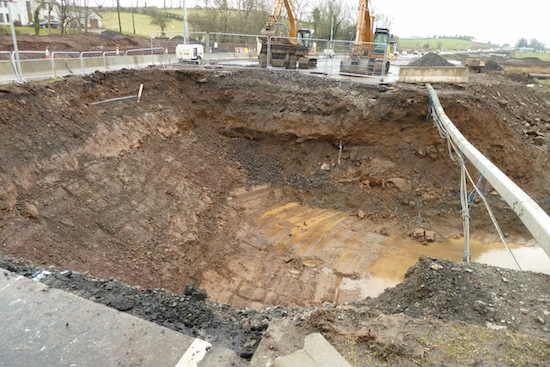

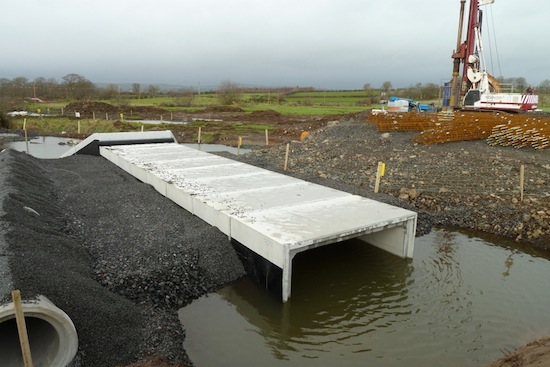

Pic 3: One half of the culvert at Park Road which will eventualy carry the diverted Larne river (which currently flows about 30 metres to the right). Work will presumably now focus on covering over this section, diverting traffic onto it, and building the other half. Taken 7 Apr 2013 [Noel O'Rawe]

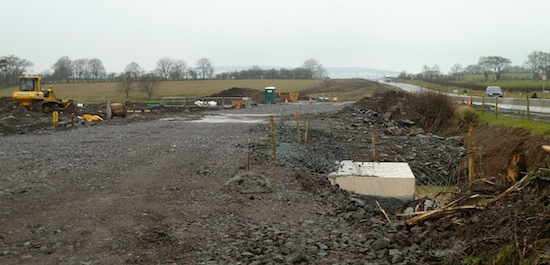

25 Mar 2013: A week ago Noel O'Rawe visited the site again, and supplied more fascinating photos of the work underway, which I have just got a chance to upload tonight. I will leave most of the explanations to the captions. As well as the vegetation clearance, fencing and culvert construction that has been underway for some time, there is increasing evidence of construction of bridge structures, mostly notably at the A57 junction at Ballynure. Some demolition of vested properties has also taken place, including an agricultural property at the A57 junction. The pictures are arranged in order from south to north, ie from Belfast towards Larne.

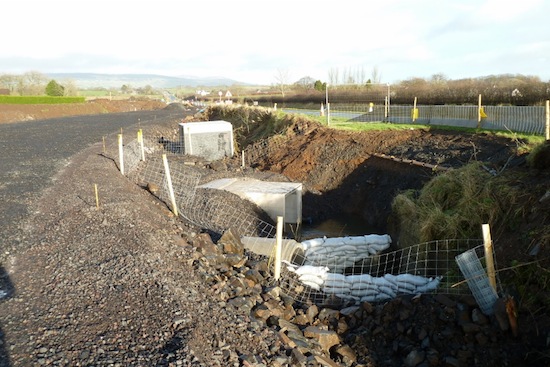

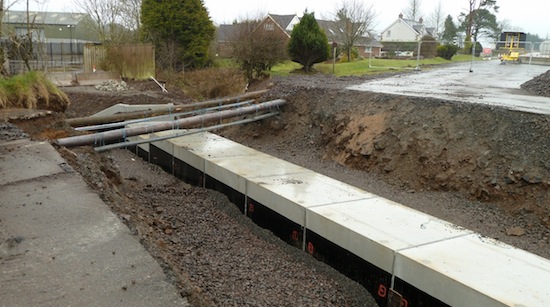

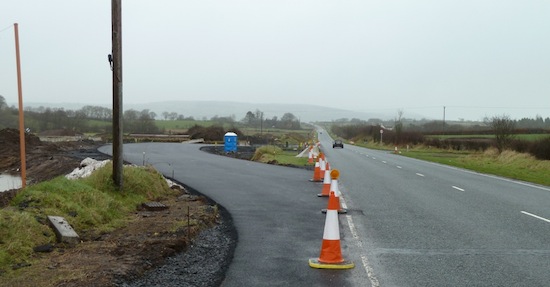

Pic 1: View south along the current A8 a little north of Glen Road, showing a culvert under construction, while A8 traffic uses a chicane behind the camera. This is the same view before work began. Note the existing utilities preserved in the suspended pipes. Taken on 18 March 2013. [Noel O'Rawe]

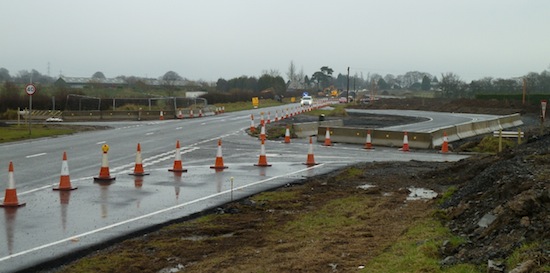

Pic 2: View south west along the A8 near Drumadowney Road where a culvert is being built under the existing A8. The chicane came into use at the end of January while the second half was built under the main road. This has now been completed and reinstated, so this chicane is now redundant. Taken on 18 March 2013. [Noel O'Rawe]

Pic 3: View north east along the line of the A8 near Green Road, where a culvert has been completed and is now being covered over to allow all A8 traffic to be diverted onto it while the second half of the culvert is built to the right. This is the site of the future Green Road/Calhame Road grade separated junction (see map in previous update below). Taken on 18 March 2013. [Noel O'Rawe]

Pic 4: In Pic 3 above you can just see some metal fences to the left of centre. This is what is behind them - the foundations of the western side of the future flyover that will form part of the future Green Road/Calhame Road grade separated junction (see map in previous update below). Taken on 18 March 2013. [Noel O'Rawe]

Pic 5: As the new A8 approaches Ballynure from Belfast it veers off the route of the existing A8, at the A57/A8 junction, to take an offline route around the town. The road will drop down below ground level and pass under the A57 in a cutting. This is the view north from the existing A57 showing the foundations of the bridge that will carry the future A57 over the A8 which will run from left to right here. This is a very major piece of engineering on the side of a very steep slope. This is the same view before work began. Taken on 18 March 2013. [Noel O'Rawe]

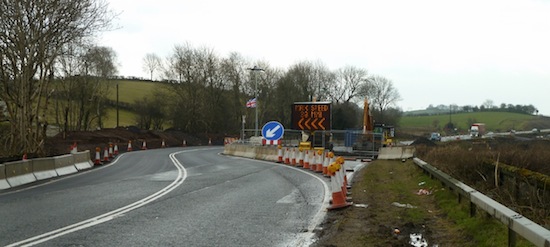

Pic 6: View north along the A8 approaching the Park Road junction where yet another chicane has been built to allow for construction of a bridge over the Larne River. This is the same view before work began. Taken on 18 March 2013. [Noel O'Rawe]

Pic 7: Closeup of the excavation shown in Pic 6 where a new bridge over the Larne River is being built. The reason there is no river visible is that the river is being shifted slightly: the existing river and bridge are about 30 metres behind the camera. At this point the road will be mostly constructed to the right so presumably the new bridge will extend off the frame to the right. Taken on 18 March 2013. [Noel O'Rawe]

2 Feb 2013: More photos for you this time, thanks to Noel O'Rawe who visited the site last weekend. Progress seems to be good. Last week further tree felling took place, this time in the vicinity of Deerpark Road and Ballygowan Road towards the Larne end of the scheme. The photos below show some of the other work that has been happening. Firstly, there are three photos taken at Legaloy Road which is the site of the future "Green Road/Calhame Road Grade Separated Junction" where some actual piling work seems to have started. As was the case three months ago, much of the rest of the work still seems to be concentrated on putting culverts in place to divert watercourses. These steps are vital before construction on the road itself can begin. In cases where a new culvert is going under an area of online widening (ie where the new road will be made by widening the existing road) the need to keep the road open means it is necessary to build half the culvert first, and then divert all traffic onto this new culvert so that the other half of the culvert can be built. This is in evidence in two locations - at Drumadowney Road, onto which traffic was diverted two days ago, and Glen Road which will follow in the very near future. Both are shown in the pictures below. Finally, a temporary (18th month) 40mph speed limit has just been applied to the A8 between Deerpark Road and Ballyrickard Road, ie the 2km closest to Larne, suggesting that more work may be getting underway there soon.

View north east towards work underway on the future Green Road/Calhame Road junction, 27 Jan 2013, with the existing A8 on the right. The photographer is standing on what will eventually be the central reservation. Half of a new culvert has been built (foreground) while the pile driver beyond seems to be putting in piles for the future overbridge. To make this easier to understand, I have included a map of the final design at this location below with the details marked. [Noel O'Rawe]

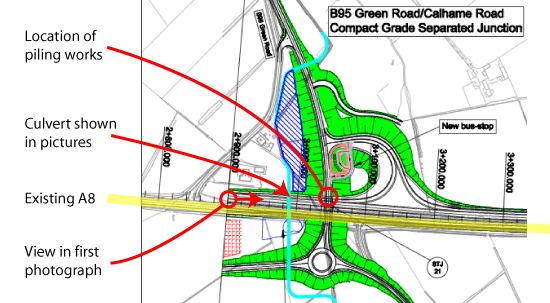

Map of the future Green Road/Calhame Road junction with the features of the previous photograph marked. Existing A8 is marked in yellow.

Closeup of the half-finished culvert at Green Road/Calhame Road taken from the existing A8 on 27 Jan 2013, along with an additional length of pipe on the left, perhaps part of the road drainage system. [Noel O'Rawe].

Closeup of a pile in the ground at Green Road/Calhame Road. This is where the central reservation will be. It could be for the central pier of the bridge, or it could be part of some system for measuring ground movement. 27 Jan 2013. [Noel O'Rawe]

View north-east along the A8 close to Drumadowney Road, where a new culvert has to be built across the existing A8. Half of the culvert has been put in place, and this short length of road built on top of it. A8 traffic was shifted onto this on 31st January, so that the existing A8 could be excavated to build the second half. This is the same view before work began. Taken 27 Jan 2013. [Noel O'Rawe]

View north-east along the A8 near Glen Road, where once gain a new culvert has to be built across the existing A8. Half of the culvert has been put in place, and this short length of road is being built on top of it. Like Drumadowney Road, A8 traffic will shortly be shifted onto it. This is the same view before work began, also illustrating how much vegetation clearance has already taken place. Taken 27 Jan 2013. [Noel O'Rawe]

Close-up of the half-finished culvert near Glen Road (same location as previous photo) 27 Jan 2013. The half-finished box culvert is beyond a round pipe, which in this case may be there to carry the existing watercourse which is just visible below the tufts of grass. [Noel O'Rawe]

5 Nov 2012: This update is to bring you photographs, thanks to Noel O'Rawe who took these images yesterday (Sunday 4th). As expected, the work so far is concentrated at the southern end of the scheme and seems to mostly involve the construction of culverts over watercourses. This would make sense, as lots of pieces in the jigsaw, such as new access points to houses and farms, have to be in place before their existing entrances can be sealed off to facilitate the later phases of construction. In addition, tree felling seems to be largely complete, and the fences that mark out the land that has been bought from landowners seems to be largely in place. For each picture below I include a Google StreetView link to the same view before works began. This illustrates not only the before-and-after aspects of the scene, but also illustrates the scale of work required to clear vegetation.

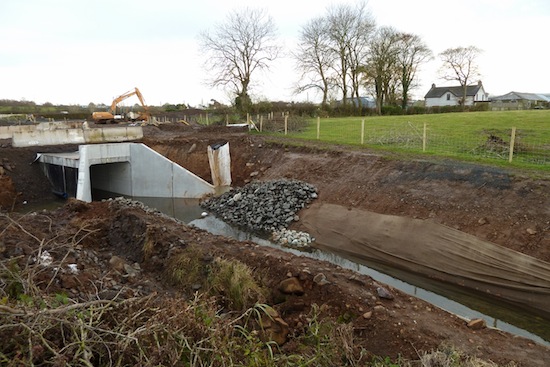

Pic 1: View south from Drumadowney Road towards a new culvert going in over a minor watercourse. This will carry a new residential/agricultural access road for the properties beyond, which currently open directly onto the A8. StreetView before works began. 4 Nov 2012 [Noel O'Rawe]

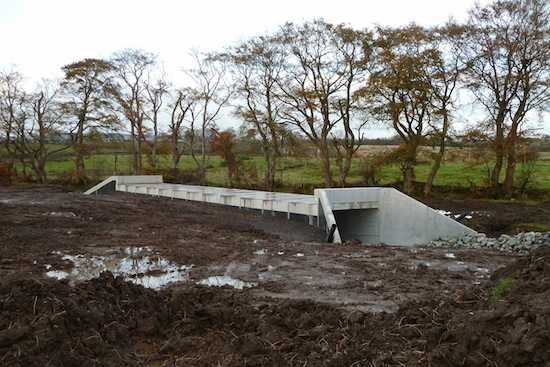

Pic 2: View north from Green Road towards a new culvert going in over another watercourse. A new grade-separated junction is being built here, and Green Road (where the photographer is) is being realigned to meet it. The culvert seen here will carry the realigned Green Road. Because Green Road will be climbing up to cross over the A8, the culvert will eventually have an embankment over it, hence why it appears to be so wide here. StreetView before works began. 4 Nov 2012 [Noel O'Rawe]

Pic 3: This view is looking east from the current A8 at the same grade-separated junction referred to in pic 2. This culvert will carry a short parallel link road that will connect the bridge over the A8 at Green Road over to Calhame Road. As with the others, the road will be on a slight embankment, hence the very wide culvert. StreetView before works began. 4 Nov 2012 [Noel O'Rawe]

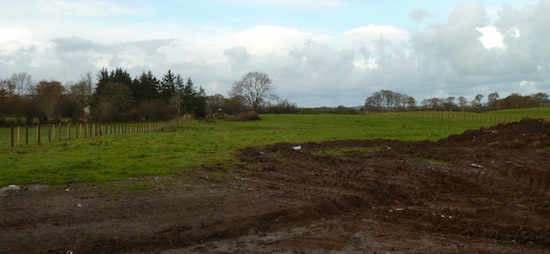

Pic 4: This view looking north from Lisglass Road is at one of the two locations where the new A8 will run off-line from the current road, at this point to bypass the settlement of Bruslee. This shot shows the view to Larne, and you can clearly see the temporary fences erected to split the land now owned by Roads Service from the land still owned by the landowners. StreetView before works began. 4 Nov 2012 [Noel O'Rawe]

Pic 5: This shows the view south from the same location as pic 4, ie Lisglass Road looking in the Corr's Corner direction. It shows yet another culvert in place: this one will carry the main A8 dual-carriageway over the Ballylinny Burn, and is probably the largest of the culverts shown in these images. StreetView before works began. 4 Nov 2012 [Noel O'Rawe]

24 Oct 2012: Work continues to build up on this scheme. I have not been up the A8 since work started, so I do not know precisely what has occurred to date (can anyone update me?!). The stretch around the small settlement of Bruslee, and particualrly the Ballynure bypass stretch, are entirely offline so the work there will not affect drivers on the A8 itself. However the remainder of the scheme involves an online upgrade which will require working on the road while it is being used. The recent imposition of a 40mph speed limit on a stretch of the A8 at the south end gives a clue that work will be taking place on this stretch at an early stage. The stretch affected is shown here. In other news, you can see pictures of the Minister at the (very wet!) sod-cutting ceremony here and here. The ceremony took place in this field at the extreme north end of the scheme. This is the future site of the roundabout that will be built to serve the A36 Shanes Hill Road.

15 Oct 2012: The "Roads" Minister Danny Kennedy officially cut the first sod on this scheme on Thursday, 11 October. Work actually got underway two months ago, with completion due "in spring 2015", according to the press release, although the timescale given in September suggests early summer is more likely (see previous update).

8 Sep 2012: Roads Service have updated their web site which includes this comment: "The construction phase is expected to last for approximately 34 months." This is a bit longer than previously anticipated, and it pushes completion from Feb 2015 to June 2015. There is a lot of work ahead.

20 Aug 2012: A press release on Costain's web site confirms both that the scheme is going ahead, and that work has indeed begun. Costain is one of the three contractors who have partnered to carry out the work to upgrade the A8. The contract value is given as £102m. This may just be the construction cost, not including land acquisition, compensation, legal costs etc. I can't see corresponding press releases on either Lagan's web site, or Ferrovial's web site. Interestingly, Costain's press release says that completion is due "Winter 2015" which, even if we assume this means early 2015, is still later than we had hoped. The unexplained two month delay in commencement from June to August probably explains the delay. With a 2-and-a-half year construction period, completion is now likely to be around February 2015.

13 Aug 2012: Work finally seems to be underway on this scheme. Site visitor Noel O'Rawe reports that there is a lot of work taking place to the north-east of Coleman's Corner (ie the very south end of the scheme). This is probably the construction of a site storage yard, which is earmarked for this location. This would be one of the first steps required as a contractor gears up on a big project such as this. It allows the contractor to bring in heavy plant machinery, set up portacabins, fuel storage facilities etc.

1 May 2012: Today the "Roads" Minister announced that the scheme has passed its public inquiry, and that work is to begin on the ground next month (June). Work is due to take two-and-a-half years, meaning that it ought to be completed around Christmas 2014. The DRD has published both the Inspector's Report (a 577 page tome) and the Departmental Statement (where Roads Service respond to the inspector's recommendations) and they are available here. Although the scheme has, overall, passed the public inquiry, public participation (which was very great) has resulted in over 60 individual recommendations, most of which have been accepted by Roads Service. The most significant one relates to the plan to sever Church Road in two, at the point where it crosses over the Ballynure Water. The dual-carriageway is due to cross Church Road here at right angles, on an embankment. Roads Service decided quite late on to use an embankment rather than a bridge because it was £700,000 cheaper, and because they were planning to provide a new link road from the western end of Church Road to the A57 Templepatrick Road just to the south. This, they argued, would actually benefit most users of Church Road. However, the inspector felt that on balance the disruption to the area meant that the extra cost of a bridge would be justified. Roads Service have accepted this, and the associated link road will now not be built. You can see the original link road on page 6 of this PDF file. In my previous post I commented that the scheme requires tree felling, and that this would be problematic due to the bird nesting season. However, in the Departmental Statement Roads Service say: "Vegetation removal will either be undertaken outside of the nesting bird season or with a suitably qualified ecologist surveying the vegetation in advance." In other words, they feel they can go ahead with tree felling, provided an ecologist has determined that each tree is free of nests before it is cut down.

22 Apr 2012: There is still no sign of any work on the ground, which is not surprising given that the outcome of the Public Inquiry and the Departmental Statement (giving Roads Service's response) have not even been published yet. There are numerous trees along the route, so if work is to go ahead tree felling must take place prior to the bird nesting season, which has now begun. This suggests that, if the Public Inquiry gives the go-ahead, work might not now proceed until after the summer. This seems to be supported by the DRD's own Business Plan 2012-13, just published online. This document gives the target start date (the date work ought to have begun by) for the scheme as "31st August 2012", which is much later than the date of "April/May" suggested by the Minister in February. It's not clear why the outcome of the Inquiry has not been published - presumably Roads Service are still working on their Departmental Statement.

14 Feb 2012: At last we have clarity about this scheme. Ever since Dublin withdrew its funding for the A5 and A8 schemes, there has been a question mark over this scheme. Today it was announced that the scheme will go ahead, perhaps commencing within weeks. The Public Inquiry process is still ongoing, in the sense that the Inspector's Report has not been published, but the Minister indicated that if this process concludes in the scheme's favour, work could get underway "in April/May 2012". This will be good news for the contractor Lagan/Ferrovial/Costain, which was awarded the work two years ago. There is slight disagreement over the cost. DRD's press release gives the total cost as "£110-120m", while the First and Deputy First Minister's press release gives it as "£105m". It's possible that the lower amount is not actually the total cost, eg it might not include money spent to date. It is not really surprising that this scheme has got the go-ahead - it is one of the few schemes that has already had its public inquiry, and hence one of only four schemes (A2 Greenisland, A6 Toome, A5, A8) that could realistically go ahead at short notice. If it does go ahead within the timescale indicated, it will be the first of the major new road schemes to get underway.

12 Nov 2011: Roads Service apparently now have the Inspector's Report on June's Public Inquiry, but are not planning to release it until March/April time next year when it will be released along with various other documents, such as the Vesting Order.
All the media attention of the past week has been on the implications of Wednesday's withdrawal of Dublin's promised £400m on the A5. However, they seem to be forgetting that the money was also to part-fund this scheme on the A8. For simplicity, on paper all the £400m was to have been paid to the A5, but this was purely for bureaucratic expediancy. The A8 scheme is being progressed by Roads Service on the assumption that this £400m was coming. So the announcement throws up lots of question marks about this scheme. There are two things that work in the scheme's favour. Firstly, the DRD needs to spend the spare cash quickly, and the A8 is one of only three schemes that have already had their public inquiries and hence could proceed soon (the other two being A6 Randalstown-Castledawson and A2 Greenisland; ignoring the A5). Secondly, at £113m the scheme is considerably cheaper than the A5 and still quite affordable by Stormont alone. By contrast, I think it's improbable that Roads Service would regard this as the most eligible scheme if everything was on a level playing field. The future of the A8 scheme is thus wide open at this point.

4 Jul 2011: The Public Inquiry opened on 15th June and concluded on 23rd June. We now have to wait to see what the Inspector's recommendation will be. It is likely to take a few months to compile the report, which I speculate we could expect in the Autumn.

14 May 2011: Roads Service have announced that the Public Inquiry into this scheme will begin at 10am on 15th June 2011, in Corr's Corner Hotel. This is slightly earlier than was anticipated last May. They have also released an addendum to the Environmental Statement. Basically this is needed because the designers have tweaked the design a bit, so that (for example) in some places the road is lower than originally planned, and in others higher. This means that some of the noise calculations, etc, needed to be re-done. As always, I would urge all those with an interest in this proposed scheme to turn up to the Inquiry as this is the key event for expressing concerns.

14 Jan 2011: The DRD has released its draft budget for the period 2011-2015. This shows that the A5 and A8 schemes are being progressed at all costs - all other schemes (with the exception of the Cherrymount Link in Enniskillen) have been put on hold until at least 2015 in order to ensure there is sufficient money for the A5 and A8. Even so, the budget assumes that the £400m contribution from the Irish government comes through (see previous update). The decision to press ahead with the A5 and A8 will certainly provoke debate because (a) a number of smaller schemes are being sacrificed to allow the A5 and A8 to proceed and (b) the Irish government contribution carries a high risk of withdrawal. Meanwhile, work is proceeding on this scheme with a public exhibition of the latest proposals scheduled for 25 and 26 January. It will be held in Corr's Corner Hotel, Newtownabbey from 2pm to 9pm. As always, I strongly encourage all those with an interest in the scheme to turn up as this is a key event for getting your views across. This will coincide with the publication of the draft Environmental Statement (setting out the impacts of the scheme) and three draft Notices (setting out changes to private accesses onto the A8, listing land that will be purchased for the scheme and a notice that provides the legal basis to construct a new trunk road).

23 May 2010: Roads Service have now completed the 'high level review' into the route of the scheme at Ballynure (see update on 14 Dec 2009). They have decided that their original plan (western bypass of the town) is still the best option. They studied several variations of the original online dualling option through Ballynure to see if any of them performed better than the option that was rejected. However, they did not. In fact, they were worse: "none of the alternative online dualling options through Ballynure performed as well as the original option assessed at Stage 1 (at-grade solution with a signalised junction and 40mph speed restriction)" [source]. The full report can be read here. They also concluded that an online dual-carriageway would create a major visual barrier through the village, would require the closure of further road accesses onto the A8 and require the demolition of "a significant number of buildings". In addition, the presence of the Ballynure Water meant that any bridge would have to be around seven metres above ground level, which would visually be a significant sructure in the centre of the village. Roads Service therefore plan to press ahead with the western bypass option. According to a written answer in the Assembly, there will be another public exhibition (the "emerging specimin design exhibition") in August or September 2010. The Public Inquiry is still scheduled for late 2011.

22 Feb 2010: Roads Service awarded the £113m contract for this scheme to the Lagan/Ferrovial/Costain consortium on 26 January 2010. The contactor will initially work on the design and legal process around the new road, before hopefully following that up with the actual construction. Roads Service estimate that about 200 jobs will be created for the duration of the construction phase. Roads Service have also said that the next round of public consultations - when they plan to reveal the detailed design of the road and its junctions - will be in "mid to late 2010", while the formal public consultations will take place in "early to mid 2011" following the publication of the necessary legal documents.

23 Jan 2010: Roads Service intend to proceed to appoint a contractor for this scheme. Letters stating their "intention to award" were sent out two weeks ago, according to their web site. The stage 3 assessment is now underway - this means they will refine the preferred route that was announced in August, producing actual designs for the various junctions and perhaps tweaking the exact route.

14 Dec 2009: There has been much debate and publicity in recent weeks about the choice of route of the A8 at Ballynure. The eight local farmers who are affected by the proposed bypass to the west of the village along with local politicians, most notably from the UUP, have argued that the bypass uses an unacceptable amount of good agricultural land. They contend that it should be possible to route a grade separated dual-carriageway along the existing route through the middle of the village, despite the fact that this is likely to be more challenging. They argue that this would not increase sevarance, since the road is already there. A week ago Danny Kinahan of the UUP said that he had secured a committment to a 'high level review' of the A8 plans by Roads Service. There have been no independent public statements from Roads Service on the issue.

2 Nov 2009: Roads Service have said that the draft vesting order should be published in early to mid 2011. They have also clarified that four properties will have to be vested, and that these consist of "a private dwelling, a building site, a derelict building and an agricultural barn" and that the cost of these is expected "to be in the region of £550,000". Meanwhile, Roads Service have said that land to be vested will impact on 99 landowners, at at total cost which is "in the region of £8 million".

10 August 2009: The preferred route was announced last Monday. Details and maps are available on the Roads Service web site here. The public exhibition last week was apparently a great success, with almost 800 people turning up to view the proposals. The cost is now being given as £113m, within the limits predicted last May (£105m-120m). The route chosen is largely an online upgrade of the existing road, but the designers appear to have done this without compromising safety. All junctions are either compact grade-separated junctions or left-turns only. There is one at-grade roundabout at the northern terminus of the scheme. For details of the route, see the section entitled "Route" above. However, it is worth noting that the decision has been made to bypass Ballynure to the west, principally because a bypass to the east would encourage HGVs heading from Larne to the West along the A57 to continue to go through the village. The hamlet of Bruslee will also remain intact, since the decision has been made to bypass it to the east.

27 July 2009: The Minister for Regional Development will announce preferred route for the dual-carriageway on 5 August 2009. This will be followed by a two day public exhibition at which members of the public will be able to view the developments. The exhibition will be held at Corr's Corner Hotel, Newtownabbey (on the A8) on Wed 5 August and Thu 6 August from 2pm to 9pm. I would strongly encourage all those with an interest in the scheme to turn up as this is one of your main opportunities to get your views across and ask questions.

12 July 2009: According to Roads Service, the preferred route for the scheme is due to be announced in "early August" 2009. This will then be followed a public exhibition where those with an interest in the scheme can turn up and express their views.

13 May 2009: According to the Deputy First Minister the cost of this scheme has now been more accurately estimated as between £105m and £120m. He also said that they have been assured that the Irish government's committment to financially support this and the A5 scheme remains secure. According to the Regional Development Minister, the preferred route is to be announced in mid-summer 2009. The procurement process is also due to commence shortly.

23 May 2008: Roads Service held a preliminary public exhibition about the scheme on 20 and 21 May 2008. The aim of this was to inform landowners and other interested parties about the scope of the project and to keep them informed as to the process that would be followed. It was revealed that the next milestone will be the announcement of the preferred route in Summer 2009. They also said that scheme delivery would be between 2013 and 2018, rather than simply "2013" as stated in the document "Investment Delivery Plan for Roads". Finally, the scheme now has an official web page, although at the minute it does not seem to be linked from anywhere on the Roads Service web site!

28 Apr 2008: According to the "Investment Delivery Plan for Roads" document released in April 2008, this scheme has now been placed into the "Preparation pool" for schemes likely to proceed within 5 years, ie by 2013.

14 Sep 2007: At the fifth plenary meeting of the North-South Ministerial Council in July the Northern Ireland Executive "confirmed its acceptance, in principle, to taking forward these two major road projects." and stated that "The road project from Belfast to Larne will be taken forward by the Northern Ireland Executive and its agencies." No timeline has been stated, but it is likely that the scheme will progress within the next ten years.
