Status
|
Construction scheme
(completed) |
Contractor
|
McAvoy Construction
LLP
|
Where
|
To
construct a roundabout on the A24 at The
Temple crossroads, south of Carryduff,
where the B6 crosses it; and create an
adjacent 34 space park-and-share
facility.
|
Total
Length
|
n/a |
Dates
|
Summer 2012 - Roads
Service Study proposes this scheme
March 2014 - Work said to begin "within
three years", ie by Spring 2017
8 February 2016 -
Vesting Order made
11 February 2016 - Tender for
construction released
21 April 2016 - Contract awarded to
McAvoy Construction LLP
13 June 2016 -
Construction began
Construction to last 6 months, hence
completion due approx Christmas 2016
9 Jan 2017 - Roundabout declared
completed
|
Cost
|
£1.25m as of Feb
2016 (changed from £1.2m as of Sep
2015; itself changed from
£750,000 as of Mar 2014)
|
Photos
|
See below |
See
Also
|
General
area map - Google Maps
|
Click
here to jump straight down to updates
for this scheme.
Temple Crossroads is a staggered crossroads
between Carryduff and Ballynahinch on the main
A24. It is the point where the B6 Lisburn to
Saintfield Road cross over the A24. Although the
A24 here is not congested (traffic levels hover
around 10,000 vehicles per day), the real issue
is one of safety. Traffic turning on/off the A24
into/out of the side roads create large speed
differentials with the potential for accidents.
It is also intimidating for pedestrians from the
local houses and shops. Local people have been
lobbying for improvements for years.
Roads Service revealed the outcome of a "route
improvement study" in the summer of 2012. A
route improvement study assesses a given route
(eg the whole A24) and identifies any measures
that could be taken to improve safety or
facilitate smooth movements. In this case, a
roundabout for The Temple crossroads has been
proposed, along with localised widening of the
four approaches (thanks to Lisburn
Today). The scheme was then sent to a
consultant for a feasibility study which will
determine whether the proposal can be taken
forward. In March 2014 the DRD indicated that
the scheme would be progressed to construction.
In 2016 it was announced that a 34-space
park-and-share facility would be provided
adjacent to the roundabout. It went out to
tender in February 2016.

Photos
The image below shows the junction as it was in
August 2015, before work began. Note the
commercial properties along the inside of the
bend when approaching from the north.
Updates
19 Jan 2017: The DFI Minister declared
the scheme completed on 9 January, and the
roundabout is now in normal use. The photograph
below shows the Minister with the completed
roundabout behind him. The press release
suggests that the roundabout was completed two
months ahead of schedule, which mostly fits with
the press
release at project commencement in June
where it anticpated completion in February 2017.
A park-and-share facility has also been
completed. The press release notes that some
landscaping works still need to be done, be done
which will take place in the coming weeks. A
good job by the contractor, McAvoy Construction.
The Infrastructure Minister Chris Hazzard
(right) with Stephen Pollock, head of Network
Development Section of TransportNI, Eastern
Division at the completed Temple roundabout on 9
Jan 2017. View looking south. [DFI image]
15 Dec 2016: Work on the roundabout is
very close to completion, ie very much on its
original schedule. When I passed through a
couple of weeks ago it was operating as a proper
roundabout, but unfortunately since I was
driving I didn't get a chance to take a picture.
However I cannot pass up the opportunity to
share (below) Google Maps' recently updated
satellite image of the area which was taken on
16 August 2016 and gives an excellent overview
of the site layout. You can see from this, for
example, that the realigned B6 Saintfield Road
on the west side is actually returning to its
original, historic line. The roundabout is being
built primarily for road safety. While some road
users are frustrated by the delays the new
roundabout adds to journeys, it was nonetheless
quite a hazardous junction and the rounabout
will undoubtedly prevent crashes and injuries in
the years to come.

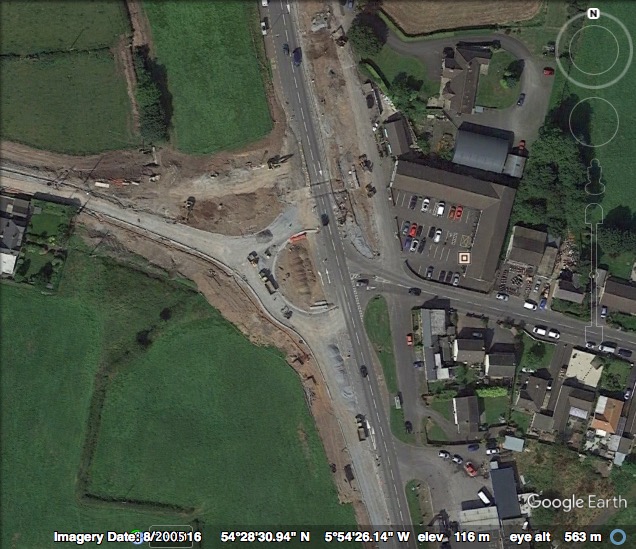

Google Earth image of A24 Temple
Crossroads taken on 16 August 2016 showing the
roundabout partially constructed.
11 Sep 2016: This update is to share
some pictures that were taken by Martin Young on
23 August. Once again in the busyness of life
it's taken me a while to get them up on the
site, so just bear in mind that these show the
works as they were three weeks ago. You can see
that the kerbing for the western side of central
island was in place, plus those for the
realigned A24 approaching from the south. Work
was also well underway on the realigned B6
Saintfield Road to the west of the roundabout,
which was still closed at that time. If traffic
has not already been switched onto this section
of road, I would speculate that it will do so in
the near future. Work is expected to be
completed around Christmas.

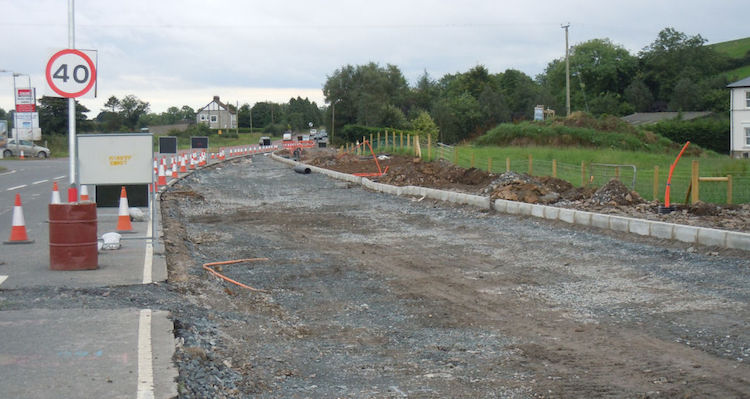

Pic 1: View south west across the A24 at The
Temple, 23 Aug 2016, showing the kerbing for the
western side of the roundabout in place and the
new road taking shape. [Martin Young]

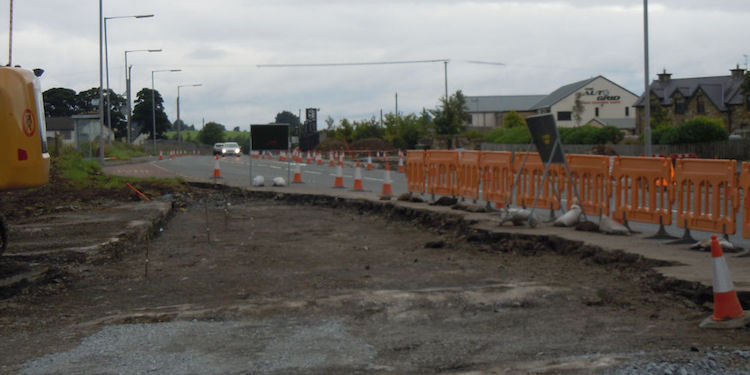

Pic 2: View south along the A24 at The Temple,
23 Aug 2016, with the new roundabout directly
behind the camera. The kerbs on the right show
the route of the realigned A24 to allow the road
to meet the new roundabout at the right angle.
[Martin Young]
Pic 3: View north towards the future roundabout,
23 Aug 2016. The existing A24 runs just off
frame to the right. [Martin Young]

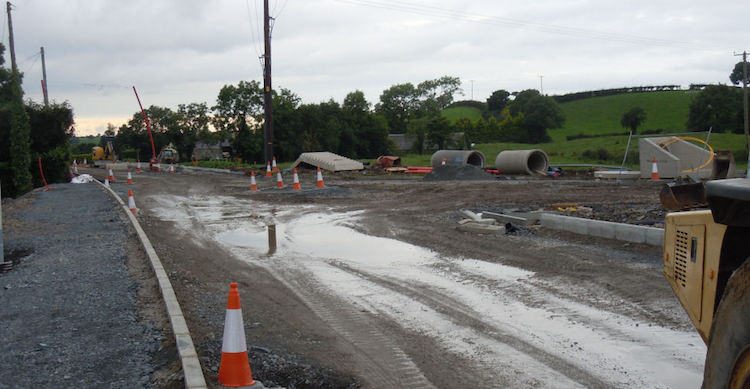

Pic 4: View west along the B6 Siantfield Road,
which is being realigned and was closed to
traffic when this picture was taken on 23 Aug
2016. The large area of ground on the right may
be the park-and-share site that is to be
constructed as part of the scheme, though I have
not seen its location confirmed. [Martin Young]

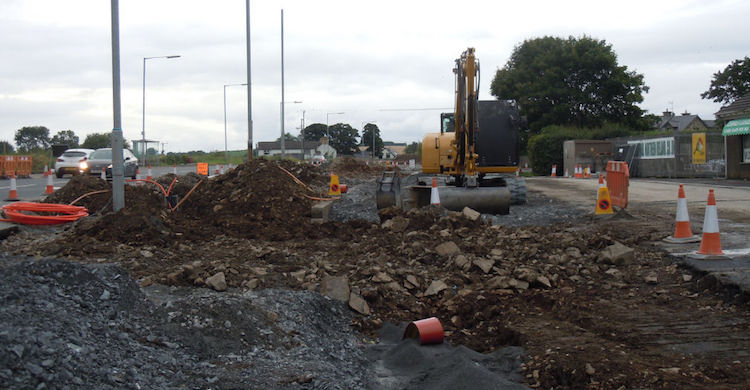

Pic 5: View north along the A24 at The Temple,
23 Aug 2016, from the new roundabout. The ground
ahead has been broken up to allow it to be
realigned directly towards the photographer.
[Martin Young]

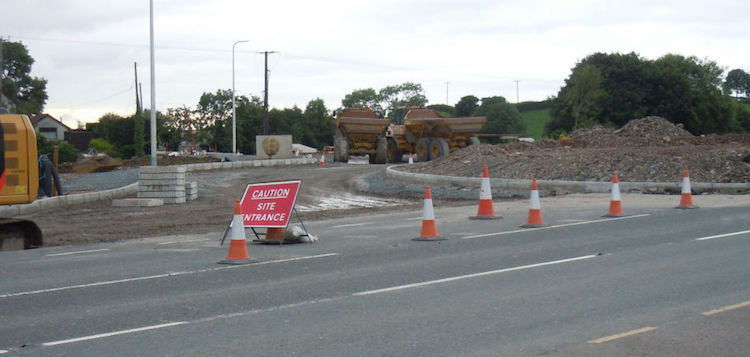

Pic 6: Looking north along the eastern side of
the A24 at The Temple, ie on the opposite side
from where works have focused. This showed
clearance works underway on 23 Aug 2016, which
is preumably to prepare for work switching to
the east side to allow the second half of the
roundabout to be completed. The road on the
right is part of an even earlier 19th century
road, that was bypassed several decades ago when
the current road was built. [Martin Young]
7 Aug 2016: Work finally
got underway on this roundabout on 13
June, under the contractor McAvoy Construction
LLP. Work seems to have initially involved
closing the B6 Saintfield Road on the west side
of the junction to faciliate local realignments
and the construction of the western half of the
roundabout. Traffic on the main A24 has been
largely unaffected, other than some minor lane
alterations and a 40mph speed limit. The DfI
press release (linked above) gives the cost as
£950,000. This is lower than the £1.25m being
quoted in February, so it is possible that the
£950k figure refers to construction alone, ie
not including planning and land purchase costs.
The photos below were taken by Martin Young on
19 July - unfortunately I was not able to update
the site during July so just note that these
show work as it was about three weeks ago.
However, I drove past the site on Saturday 6
August and could see that the kerbing for the
western half of the central island is now in
place and the future road alignments on this
side very apparent. Access to/from the B6
Saintfield Road still seems to be closed. I
would speculate that once the western side of
the roundabout is completed, traffic will be
switched onto it, and work will then resume
building the eastern side of the roundabout. A
park-and-share site is also to be built on the
western side, but since DfI have not published
the plans for the roundabout I don't know
exactly where. With thanks also to Mark Higgins
for information on this.

View south along the A24 at The Temple on 19
July 2016. The B6 Saintfield Road on the right
is closed to allow construciton of the western
side of the rounabout in the area just beyond
the red fences. [Martin Young]

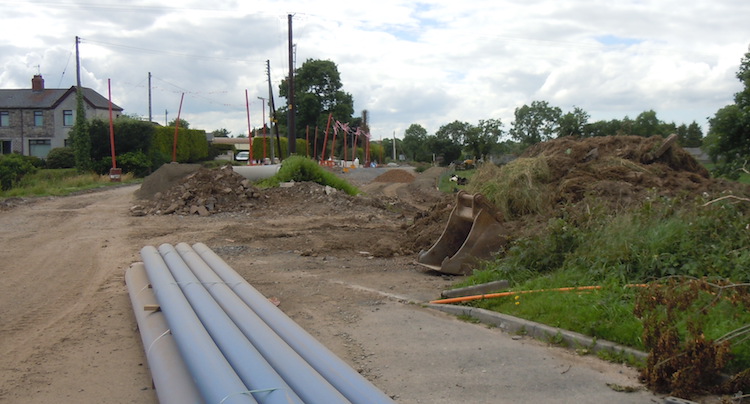

Moving to just beyond the "Road Closed" sign in
the previous shot, this is the view south from
B6 Saintfield Road with the main A24 on the
left. The area ahead used to be part of a field,
but you can see that it has been stripped away
to form the alignment of the future roundabout.
The photographer is on or close to what will be
the central island. 19 July 2016. [Martin Young]
Same location as the previous photo, but turning
90° to the right, this is the view west along
the B6 Saintfield Road which is currently shut
to allow construction work. The line of gravel
in the centre of shot may be the route of the
future, realigned, Saintfield Road. The red
posts are there to warn workers of the presence
of overhead cables. 19 July 2016. [Martin Young]
30 May 2016: I drove through The Temple
at the weekend (as I am sure many people did)
and there was no evidence of any work either
underway or even in preparation, despite the
contract being awarded almost six weeks ago. I'm
not sure why work hasn't get begun, but there
are many possible reasons, eg contractural
timings, the need for the contractor to have the
equipment and manpower available or progress on
the Vesting Order that was made in February.
Hopefully we will see some action soon.
24 Apr 2016: The construction contract
for the new roundabout at Temple Crossroads was
awarded to McAvoy
Construction LLP on 21 April -
congratulations. Construction is likely to get
underway soon, though this assumes that the
"making" of the Vesting Order in February (see
previous update below) has gone smoothly. With
construction due to take six months, it should
be completed and open to traffic before the end
of the year.
24 Feb 2016: The DRD have revealed that
they "made" the Vesting Order on 8 February. The
Vesting Order is the legal document that compels
landowners to sell the land required for a road
project to the DRD. The Vesting Order exists in
a draft form throughout planning, so that the
public can see what land will be taken, but only
once there is funding and the scheme is
definitely going ahead is it formally activated.
This is called "making" the Vesting Order. You
can see the Order here.
Meanwhile, in the Assembly
on Monday the DRD Minister confirmed that
construction should begin in the spring and that
the total project cost is £1.25m.
11 Feb 2016: The tender for this
roundabout has finally
been released, having slipped a couple of
times from the original estimate of September
2015 given last year. The tendering period is
one month, closing on 10 March 2016. The page
also gives a total contract period of eight
months, which presuambly covers the construciton
period and gives the expected cost to be £1.2m.
Note that this is the construction cost only,
and does not include land purchase or planning
costs. I would anticipate that we will see the
contract awarded perhaps in the mid to late
spring with work getting underway shortly after,
and hence the roundabout is likely to be
completed before the end of 2016.
9 Dec 2015: In the previous update I
said that the DRD was hoping to award the
contract in February 2016 but added that "from
experience it will likely slip a bit". Well,
true to form, the schedule has slipped. The
scheme is still sitting in the Future
Tenders list with an estimated date of
release of "November 2015" which has now been
and gone. Meanwhile, a consultation
has been opened into the Vesting Order that will
be needed to buy the land necessary for this
scheme. The consultation opened on 25 November
for six weeks, closing 8 January. Interestingly,
the consultation includes a map of the land to
be vested. While it doesn't show the proposed
roundabout, the land being taken does fairly
clearly imply where the roundabout will be, ie
mostly on the western side of the existing A24
and very slightly south of the western end of
Saintfield Road. There isn't really any reason
why the scheme could not go out to tender during
the consultation, but as yet it does not seem to
have. A start date of February now seems
unlikely to me - we're probably talking sometime
in the spring.
29 Oct 2015: The DRD has published their
most
recent procurement plan, and it lists this
scheme. It gives the construction cost as £1.2m
- though note that this may not represent the total
project cost, which also includes planning and
land acquisition. It states that the contract
should be awarded in February 2016 with a total
construction period of 6 months. If this
schedule remains, then we could see the project
completed by August 2016, though from experience
it will likely slip a bit.
3 Sep
2015: In my last update 18 months ago (see
below) I noted that the Minister had suggested
that this scheme was in the minor works
programme for construction within three years. I
expressed some caution about this, but lo and
behold it has now appeared on the DRD's
"future tenders" list with an estimated
release date of "September 2015" (ie, anytime
now). This could mean a contractor being
appointed and construction getting underway
early in 2016. The same page also lists the cost
of the scheme as £1.2m, considerably more than
the £750,000 estimated 18 months ago. This cost
may not include land acquisition which is
usually costed separately from construction. On
this basis I have moved the scheme right up the
list to "schemes likely to get underway within
twelve months".
19 Mar
2014: The Minister gave an update
on this scheme in
the Assembly yesterday. Back in 2012, it
was merely a recommendation from a feasibility
study, but it now seems that the scheme may
actually be moving into the formal planning
stages. He confirmed that the preferred option
remains the construction of a roundabout, and
that it will cost about £750,000. He said "My
Department is continuing to progress this
scheme and has recently begun discussions with
affected landowners to agree accommodation
works. Progression of the scheme through
the various statutory processes, including the
vesting order, direction order and tendering
process, will also be required. Subject
to the satisfactory completion of each of
those stages, I have asked officials to bring
the scheme forward as quickly as
possible. I can confirm that it is
currently included in my Department’s
three-year minor works programme." At face
value, this would seem to suggest that
construction will get underway within three
years, but schemes like this are quite
susceptible to delay (eg on the A23 at
Moneyreagh where a similar scheme was scuppered
by high land costs). The reference to "minor
works" is because the cost of this scheme is
quite low (under £1.5m), and is therefore
progressed and funded differently from "major
works" like the A5 or A6 upgrades. I have
therefore moved this scheme from the list
"proposed but no definite go ahead" to "schemes
in planning".
27 Aug
2012: Local politicians were the first to
announce that this scheme is a possibility. See
this
article in the Lisburn Today.
|
